- Before
- Owns 34 staffing and services suppliers, $41M a year, and hears about overbilling once a year, from a sample, long after payment.
- Now
- Opens one claim per supplier, every line cited and already argued from the supplier's side, and signs it with a reason code.
One staffing invoice, from the rate card to a signed claim
Kestrel & Vane Group buys senior consultants from Brightline Staffing under master services agreement MSA-BLS-2024-07. Its September invoice, BLS-26-0917, is unpaid and due on 1 November. Here is what happens to it, screen by screen, in the working solution.
- 01Wed 14 Oct · morning
One invoice, with the contract laid over it

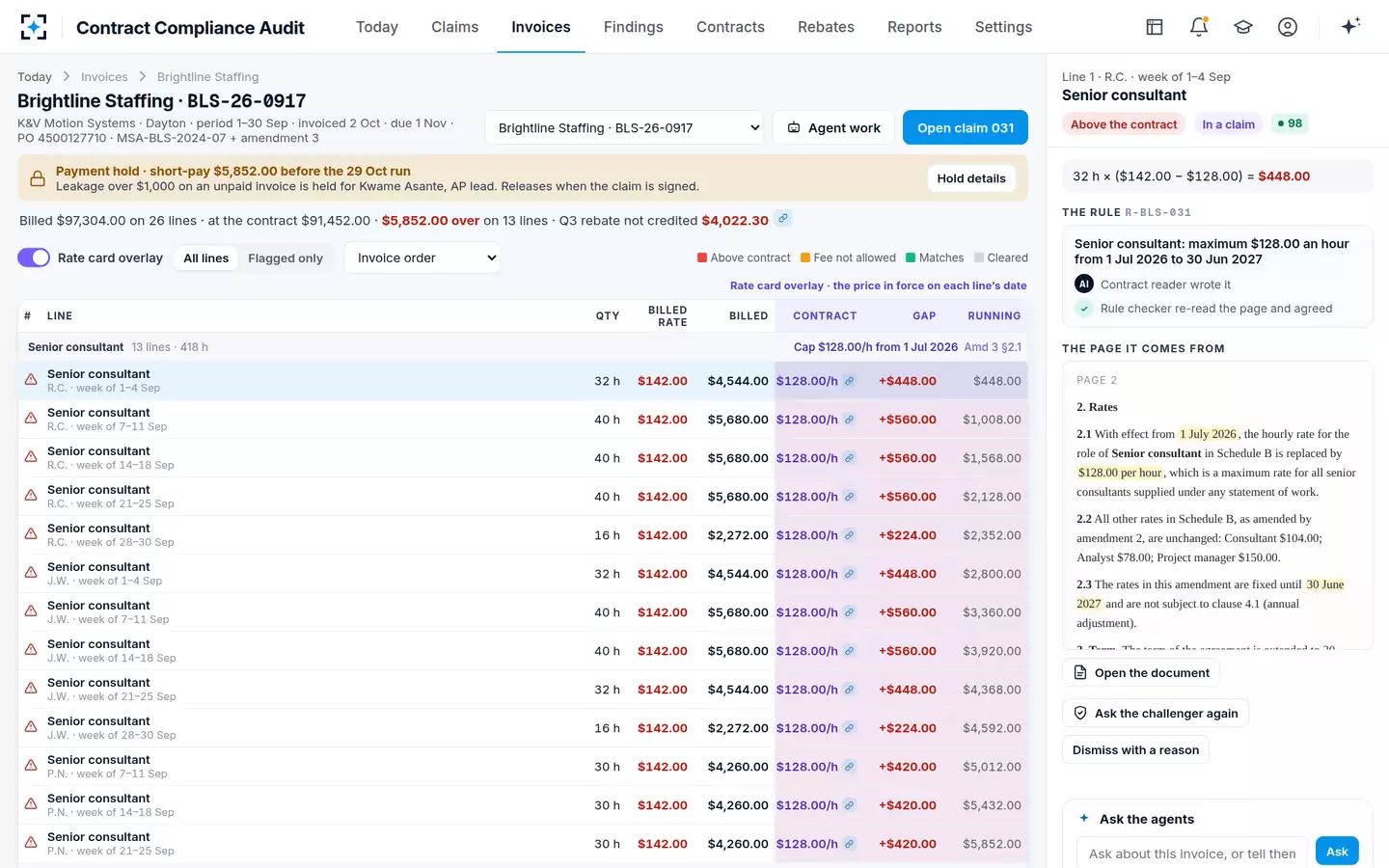

Elena Varga · Category manager, professional services and staffingFrom her morning briefing, Elena opens Brightline's September invoice: $97,304.00 billed on 26 lines, $91,452.00 at the rate in force on each line's date, $5,852.00 over the contract on 13 lines. Every line sits on the rate card overlay — billed rate, contract rate, gap and a running total — and the side panel shows the clause and the page it came from.
“Payment hold · short-pay $5,852.00 before the 29 Oct run. Leakage over $1,000 on an unpaid invoice is held for Kwame Asante, AP lead.”
- 02Behind every rate
Four rate cards, and the one in force on each date

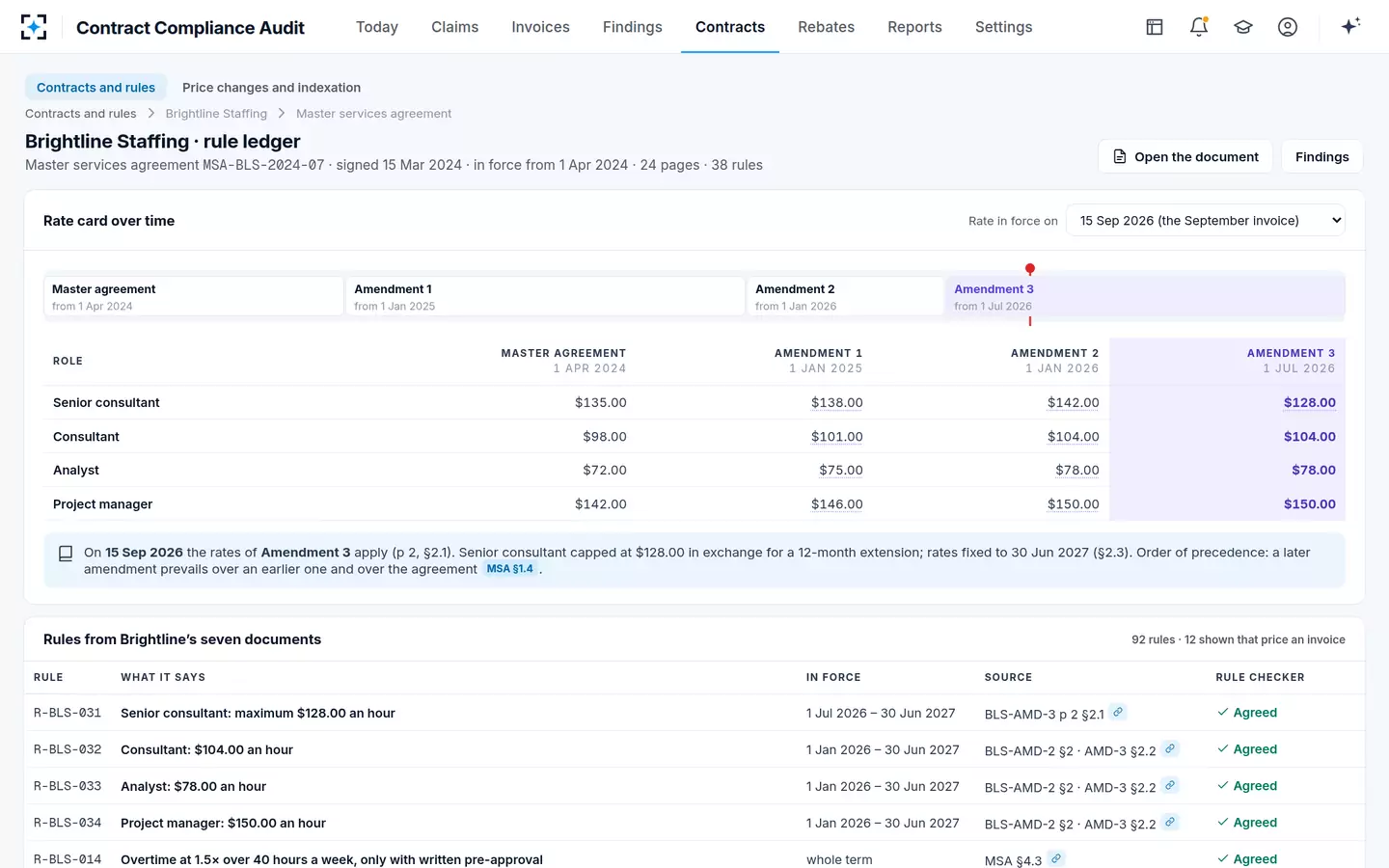

Contract reader and rule checkerThe contract reader turned Brightline's seven documents — the master agreement, three amendments, the Schedule C rebate, SOW 14 and change order 2 — into 92 dated rules, each cited to page and clause. The senior consultant rate went from $135.00 to $138.00, then $142.00, then $128.00 from 1 Jul 2026, when amendment 3 capped it in exchange for a 12-month extension. The rule checker re-read every page on its own and agreed.
“If documents conflict, a later amendment prevails over an earlier one and over this agreement” — MSA §1.4.
- 03Same morning
When the two agents disagree, a person decides

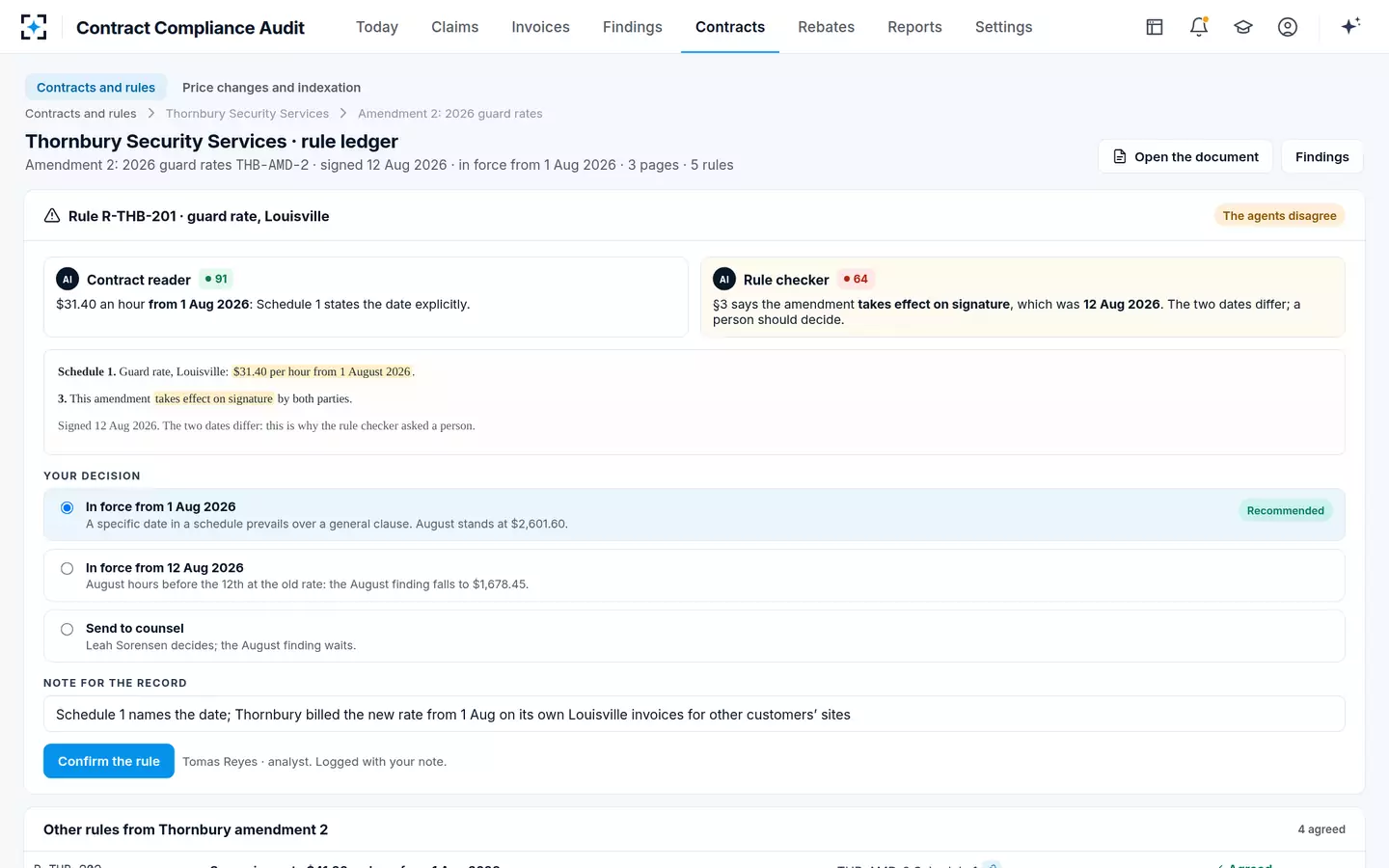

Tomas Reyes · Contract compliance analystThornbury Security Services' amendment 2 sets guard hours in Louisville at $31.40 from 1 Aug 2026 in Schedule 1, but §3 says it takes effect on signature, and it was signed on 12 Aug. The contract reader took 1 August; the rule checker disagreed, so August's $2,601.60 finding waits. Tomas chooses in force from 1 Aug, from 12 Aug ($1,678.45), or send it to counsel, and writes a note for the record.
The rule checker never settles legal ambiguity itself: it sends the difference to a person.
- 04Quarter end

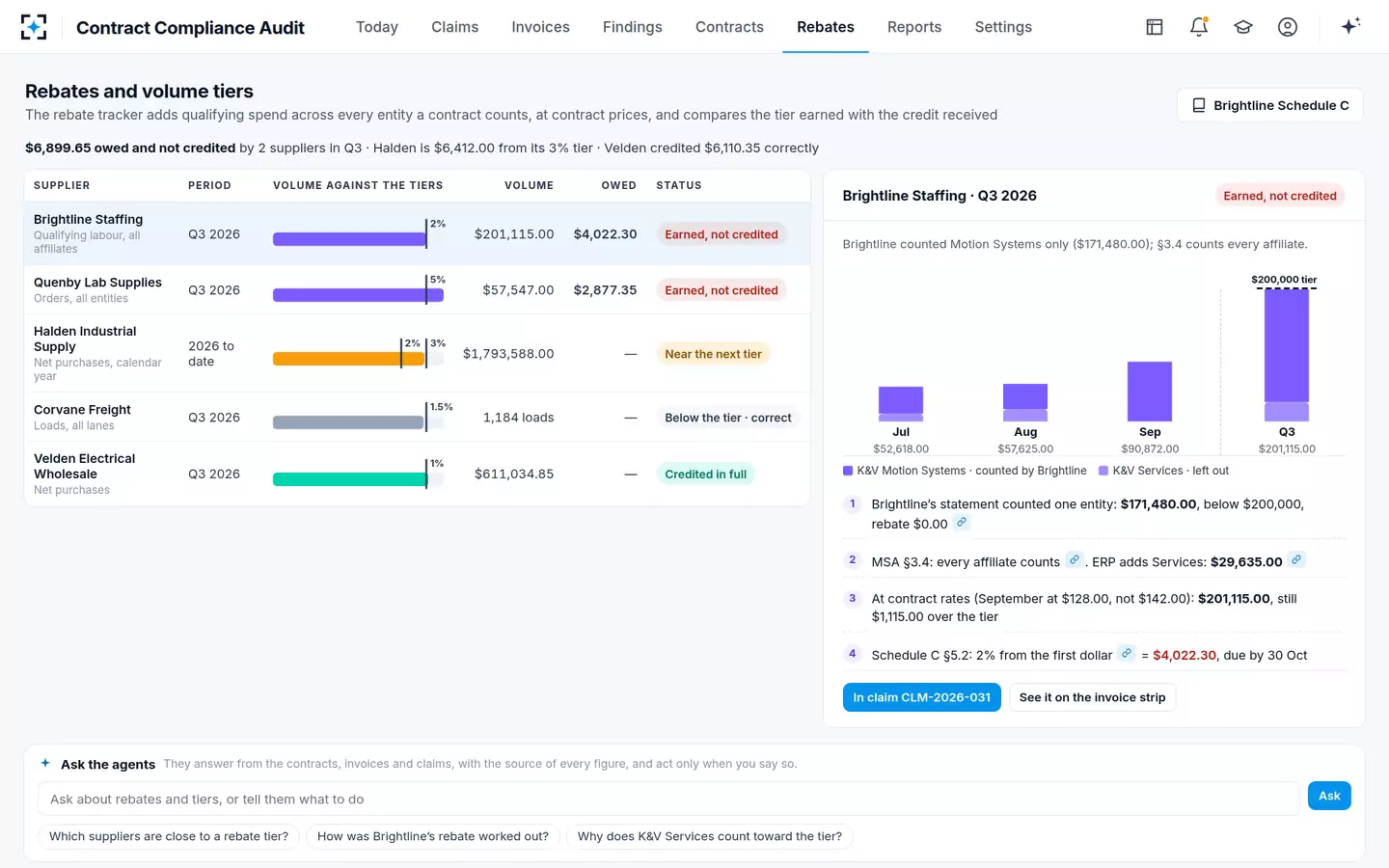

A tier crossed across two entities, never credited
Rebate trackerBrightline's Q3 statement counted K&V Motion Systems only: $171,480.00, below the $200,000 tier, rebate $0.00. MSA §3.4 counts every affiliate, and the ERP adds K&V Services' $29,635.00. At contract rates — September at $128.00, not $142.00 — the quarter is $201,115.00, still $1,115.00 over the tier, so Schedule C §5.2 pays 2% from the first dollar: $4,022.30, due by 30 Oct.
The rebate tracker always counts at contract prices, and never counts spend the contract excludes.
- 05Across the wave
Price rises checked against the index the contract names

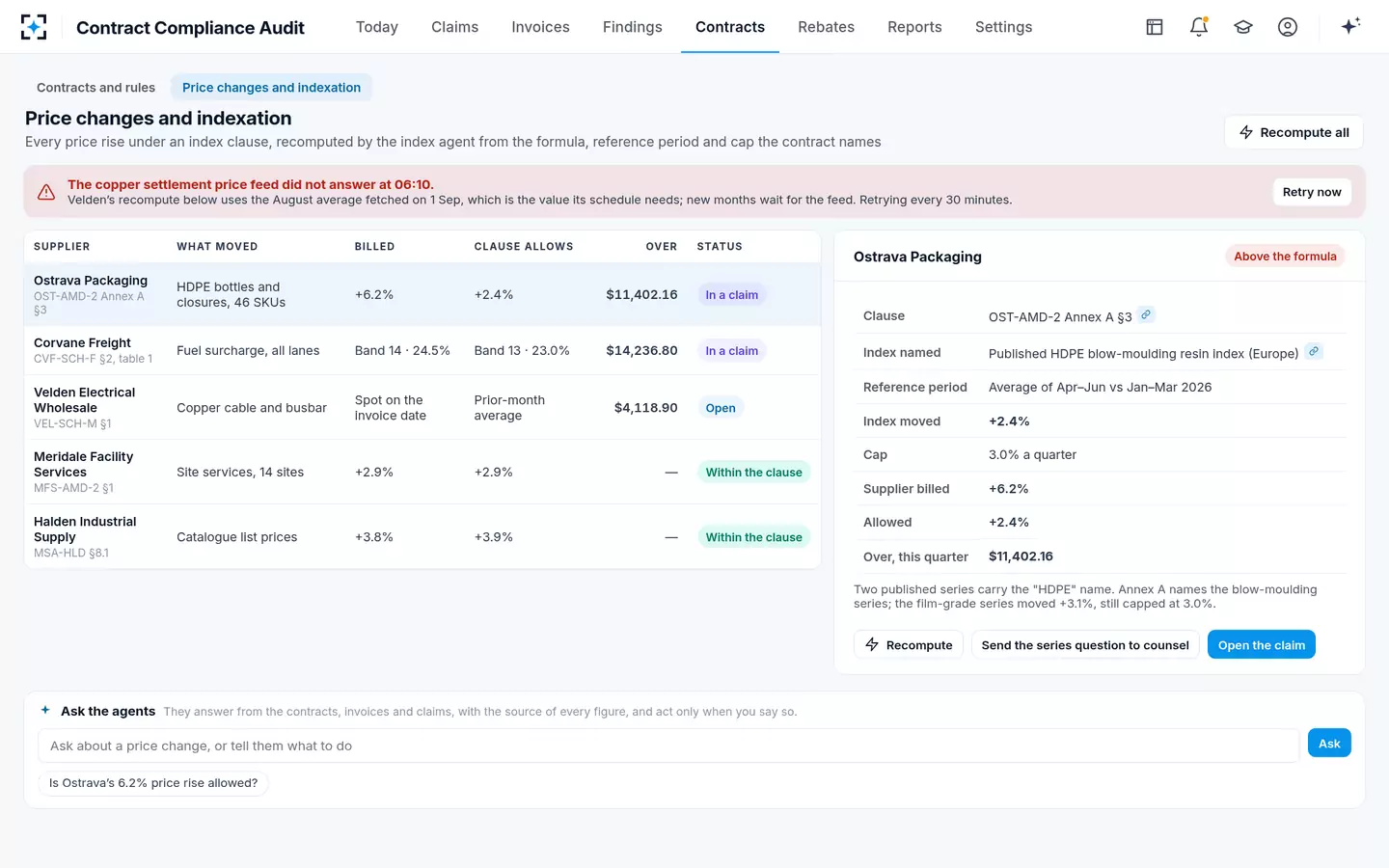

Index agentOstrava Packaging raised HDPE bottles and closures, 46 SKUs, by 6.2%. Annex A of amendment 2 allows only the change in the published HDPE blow-moulding resin index — the April–June average against January–March, +2.4% — capped at 3.0% a quarter. The 3.8 points above it come to $11,402.16 this quarter. The same screen shows Corvane Freight's fuel surcharge billed at band 14 where the clause allows band 13, and Velden's copper surcharge taken at the spot price instead of the prior-month average.
“Two published series carry the “HDPE” name. Annex A names the blow-moulding series; the film-grade series moved +3.1%, still capped at 3.0%.”
- 0606:44

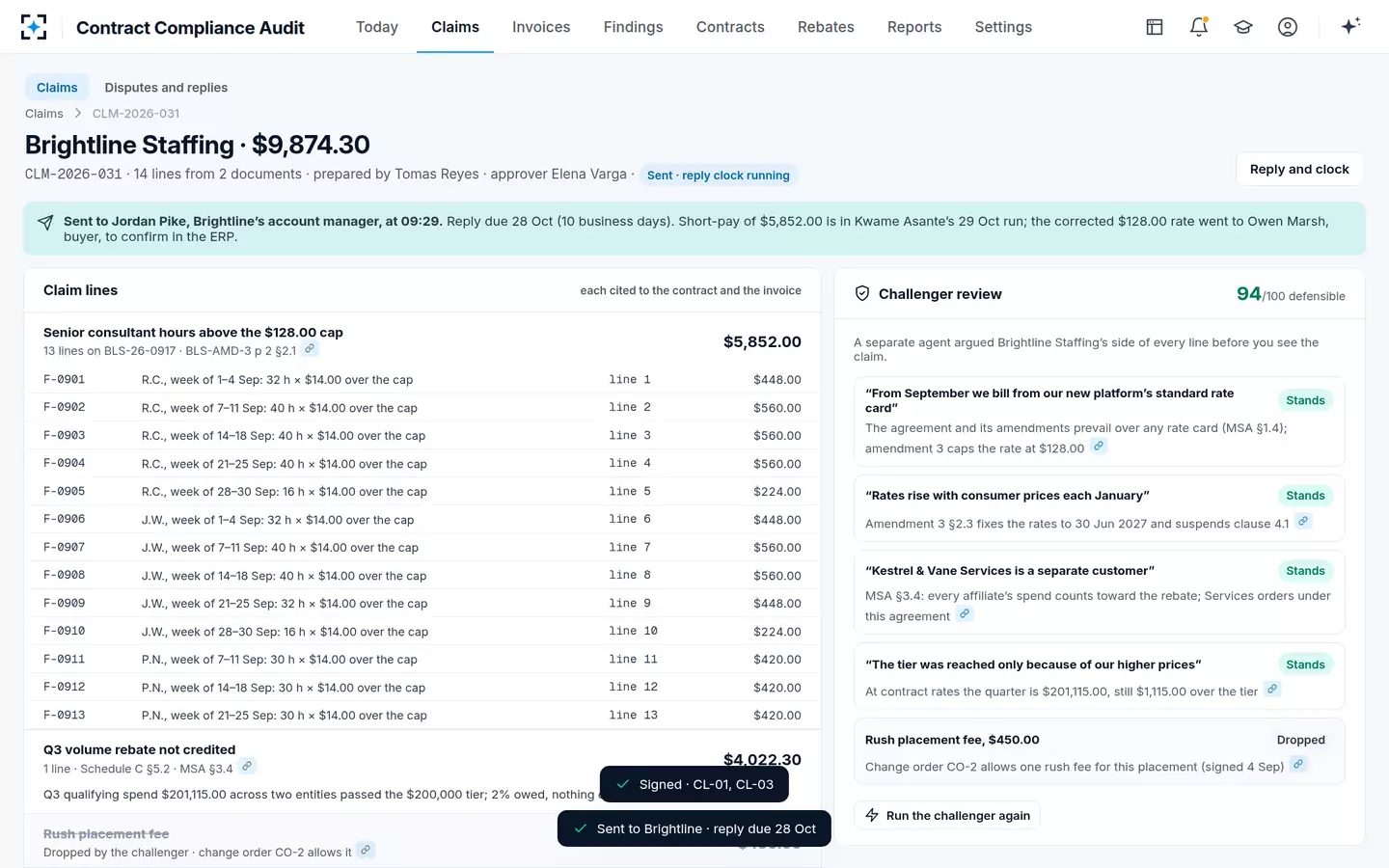

One cited claim, argued from the supplier's side
Claim builder and challengerThe claim builder bundled 14 lines into CLM-2026-031 for $9,874.30: 13 senior consultant lines, 418 hours at $14.00 over the cap ($5,852.00), and the Q3 rebate ($4,022.30). The challenger then argued Brightline's side — a new billing platform, rates that rise with consumer prices, K&V Services as a separate customer, a tier reached only on higher prices — and each argument fails on the contract. The $450.00 rush placement fee was dropped: MSA §7.3 bans it unless a written change order allows it, and change order CO-2, signed 4 Sep, does.
Defensibility 94 out of 100. The challenger never adds lines or changes amounts.
- 07Her signature

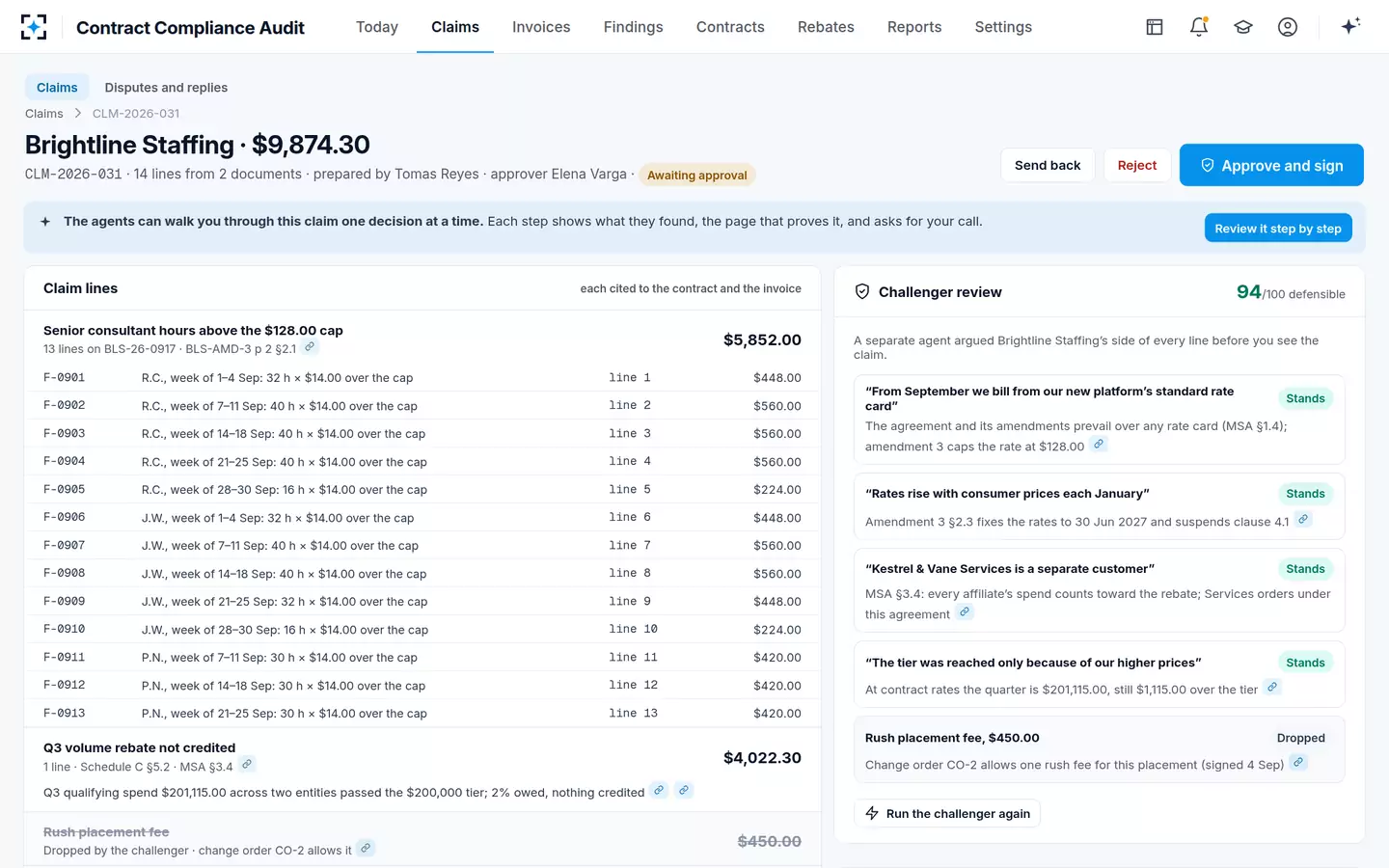

Signed with reason codes, inside her limit

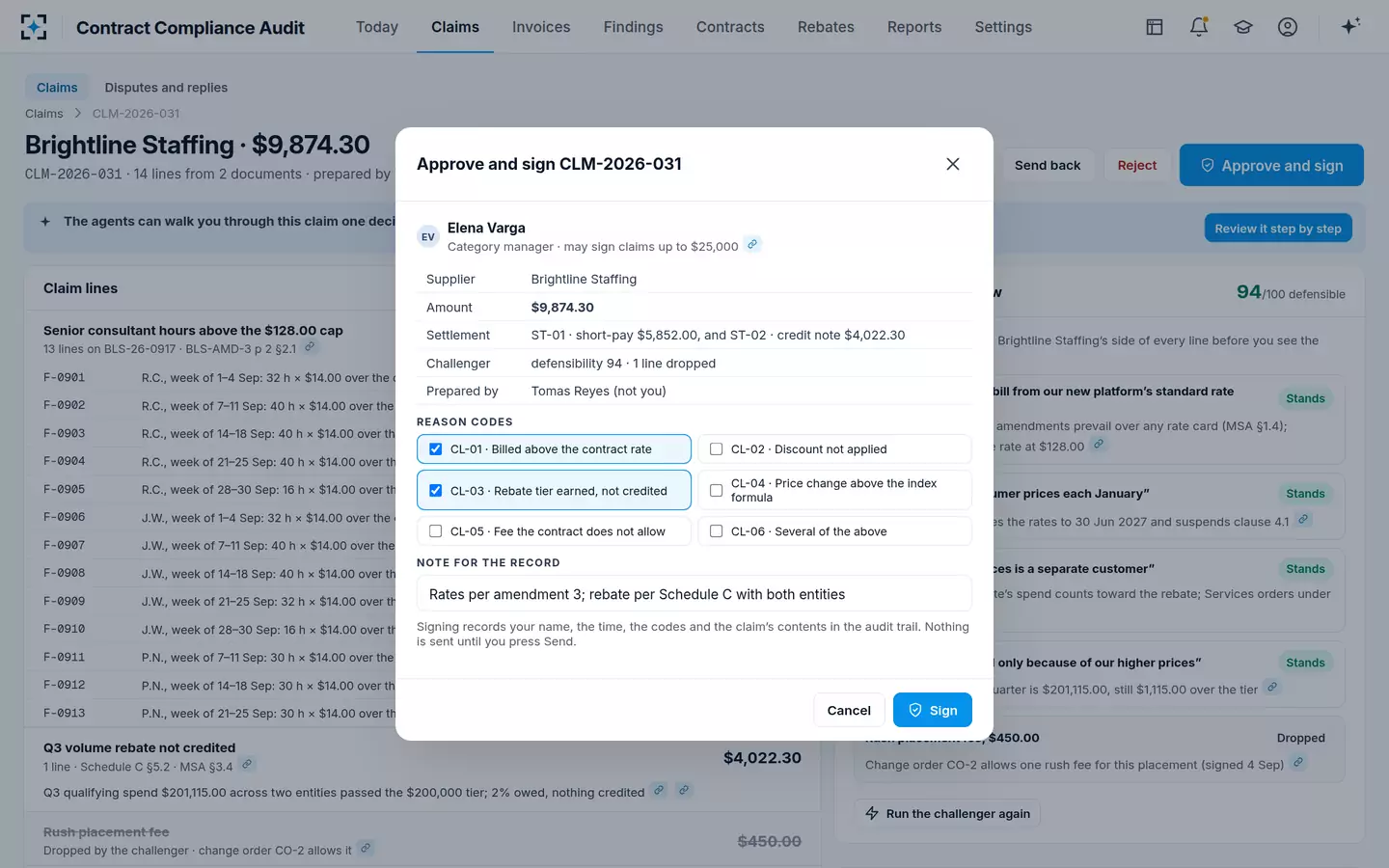

Elena Varga · Category managerThe claim builder recommends short-paying $5,852.00 on the unpaid invoice and taking the rebate as a credit note. Elena may sign claims up to $25,000; above that the procurement director signs after her, and Tomas Reyes, who prepared the claim, cannot approve it. She ticks CL-01 · Billed above the contract rate and CL-03 · Rebate tier earned, not credited, and adds a note for the record.
“Signing records your name, the time, the codes and the claim's contents in the audit trail. Nothing is sent until you press Send.”
- 08Sent
To the account manager, with the reply clock running
Elena Varga · Category managerThe claim goes to Jordan Pike, Brightline's account manager, copying Kwame Asante, AP lead, and Owen Marsh, buyer, with the schedule of 14 cited lines, amendment 3 page 2, Schedule C and ERP spend by entity. The reply is due in 10 business days, on 28 Oct. The short-pay goes into Kwame's 29 Oct payment run, and the corrected $128.00 rate goes to Owen to confirm in the ERP, so September does not repeat.
- 09Replies

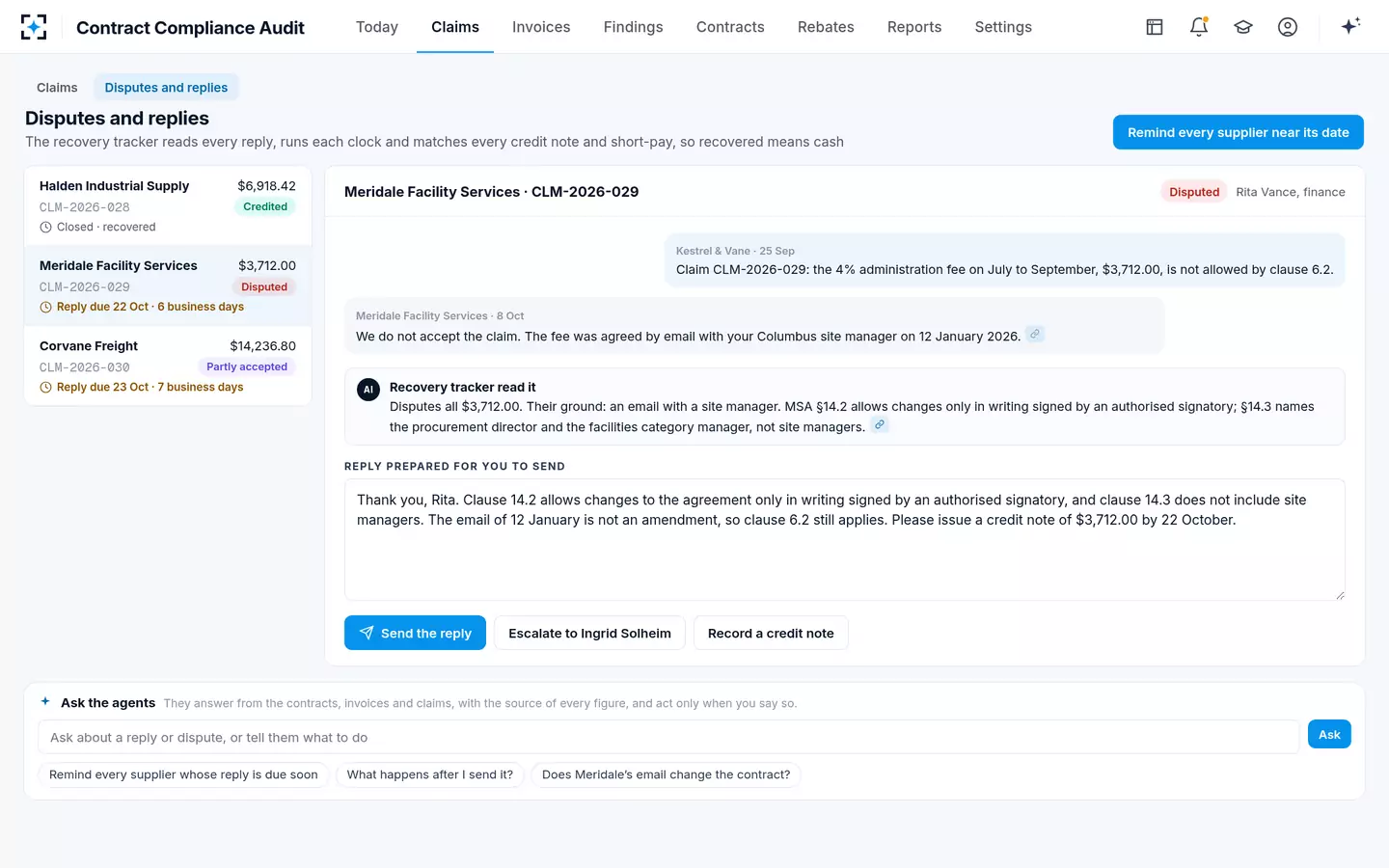

Every reply read, with the rebuttal drafted
Recovery trackerMeridale Facility Services disputes claim CLM-2026-029, $3,712.00 of a 4% administration fee that MSA §6.2 does not allow: it says the fee was agreed by email with a Columbus site manager. The recovery tracker reads the reply, finds that §14.2 allows changes only in writing signed by an authorised signatory and that §14.3 does not include site managers, and drafts the answer. It waits for a person to send it, escalate it to Ingrid Solheim or record a credit note.
The recovery tracker never accepts a settlement and never posts to the ERP.
- 10End of the wave

From found to cash, and fixed at the source
Ingrid Solheim · Procurement directorThe Q3 wave checked $9.66M of spend across 11 suppliers — 18,406 lines on 1,312 invoices, every line. It found $68,963.13, 0.71% of spend, on 10 of them; $46,143.68 is in five claims, $17,570.62 agreed and $6,918.42 already back as a credit note. Below it, the agents list the fixes that stop the leakage coming back next quarter, each for a named person to confirm: Brightline's $128.00 rate on its PO, Thornbury's $31.40 guard rate, Meridale's administration fee blocked.
