- Before
- Watches every active outage on the east network and owns the times customers are told and the evening storm calls — with a default time on each outage.
- Now
- Sees every outage as a band that narrows with each fact, approves any time more than 2 hours later, and signs off recalibration. “I don't need a perfect time. I need a time that's honest about how sure it is.”
One storm outage, from the lockout to a window customers can plan around
Tuesday 13 October 2026. A thunderstorm cell crosses Kestrel Bay on Lumina Utilities' east network at 14:40. At 14:52 recloser R-MR12-3 on feeder MR-12, fed from Marlow Road substation, locks out. Here is what happens next, screen by screen, in the working solution.
- 0116:06

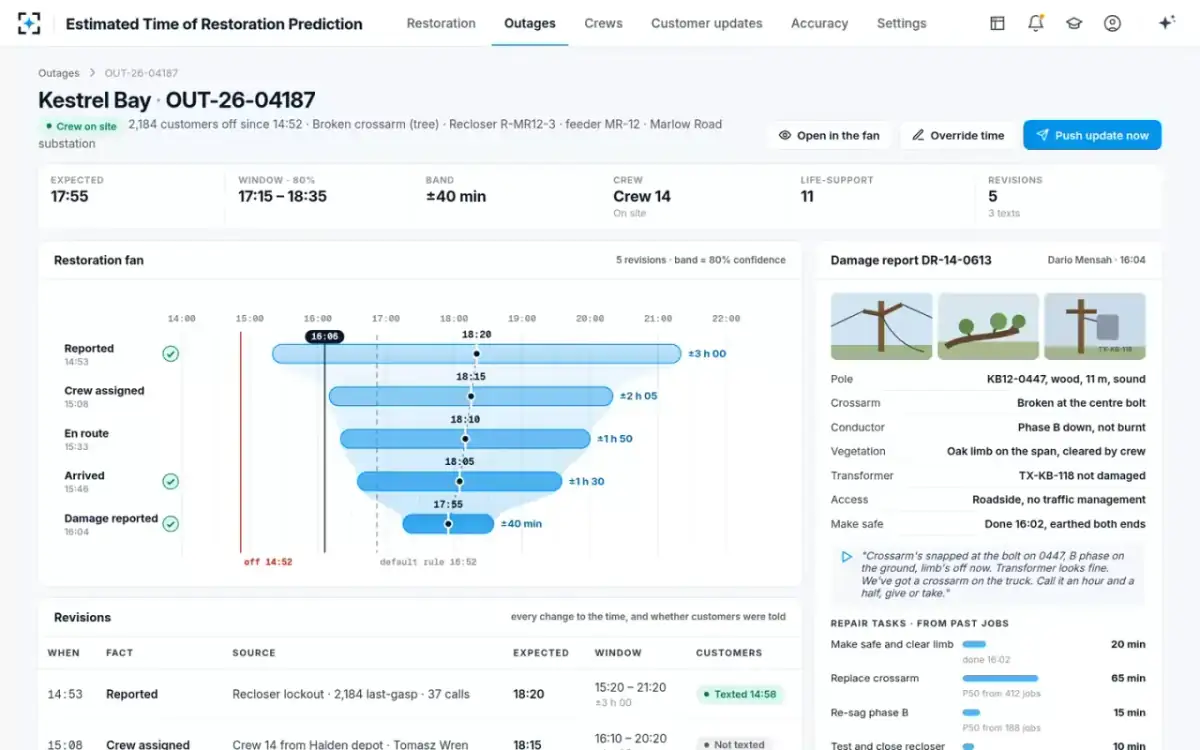

Eight outages, each drawn as a restoration fan

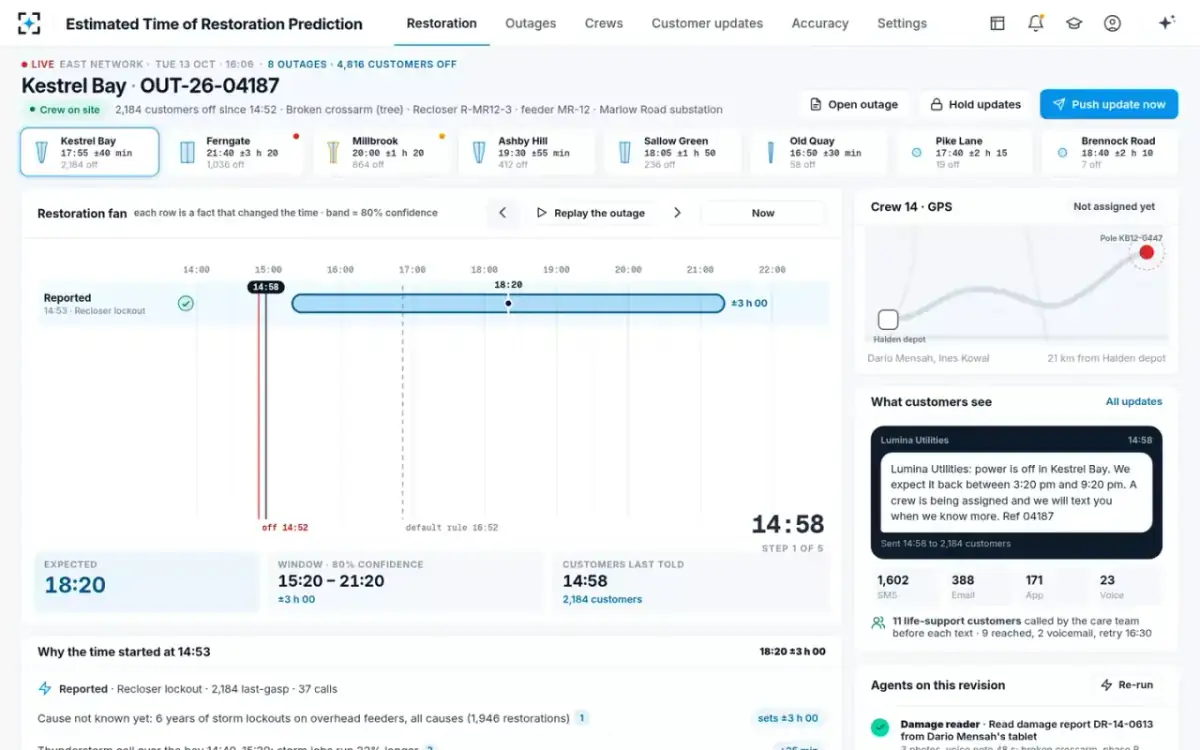

Rhea Castellanos · Outage managerRhea owns the times customers are told on the east network. Eight outages are live, 4,816 customers off, each a chip with its own small fan so she sees which times are tight and which are still guesses. Kestrel Bay, OUT-26-04187, is selected: five rows, one for each fact that changed the time, and a band that has narrowed from ±3 h 00 to ±40 min. The expected time is 17:55, in a window of 17:15–18:35.
Default rule would have said 16:52 — “1 h 03 too early”
- 0214:53 · first time
A first time that says how unsure it is
Incident reader and Restoration predictorThe incident reader reads the lockout with 2,184 smart-meter last-gasp messages and 37 calls. The cause is not known yet, so the predictor starts from six years of storm lockouts on overhead feeders — 1,946 restorations — adds 25 minutes because storm jobs run 22 % longer and 35 minutes because the nearest free crew is 21 km away at Halden depot. The first time is 18:20, between 15:20 and 21:20.
14:58 text: “We expect it back between 3:20 pm and 9:20 pm. A crew is being assigned and we will text you when we know more.”

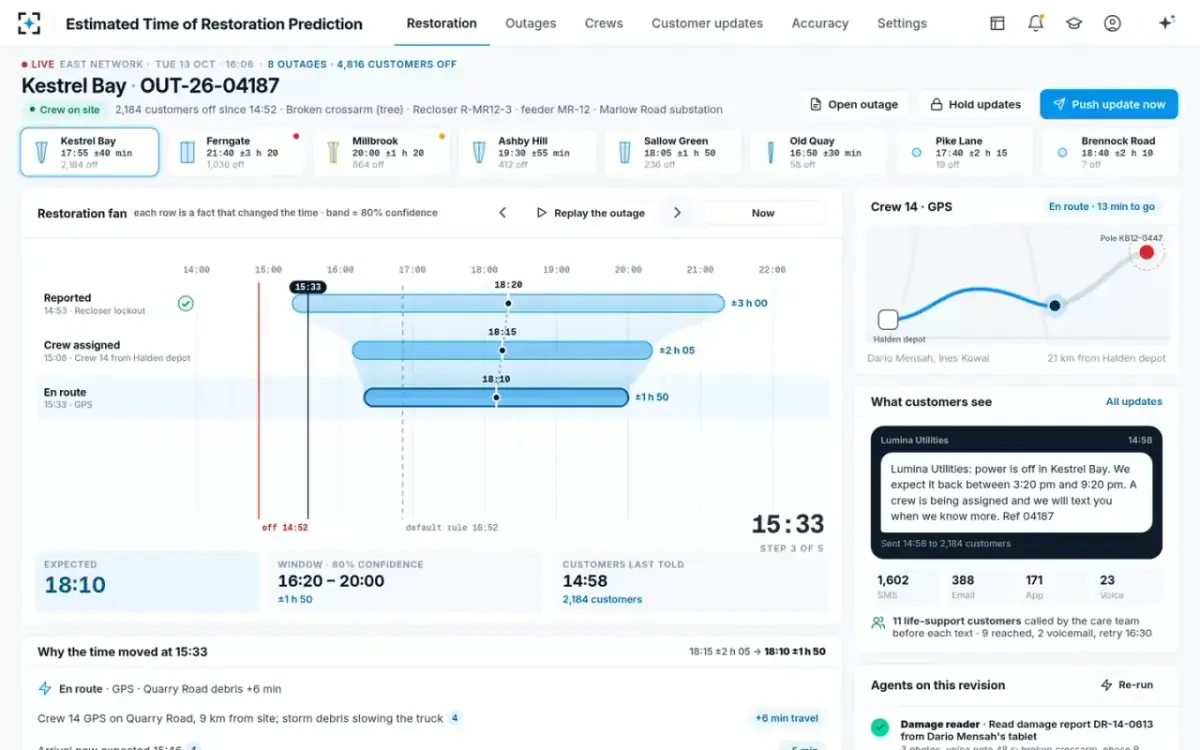

- 0315:08 – 15:33
Crew 14 assigned, and its GPS feeds the time
Tomasz Wren · Distribution dispatcherTomasz assigns Crew 14, Dario Mensah and Ines Kowal, with crossarm and conductor kit on board; the band narrows by 55 minutes. The crew tracker follows the truck every 30 seconds: on Quarry Road, 9 km from site, storm debris adds 6 minutes of travel. The time moves to 18:10 ±1 h 50. Each change is under the 30-minute push rule, so customers are not texted.
“Change under the 30-minute push rule: customers not texted”

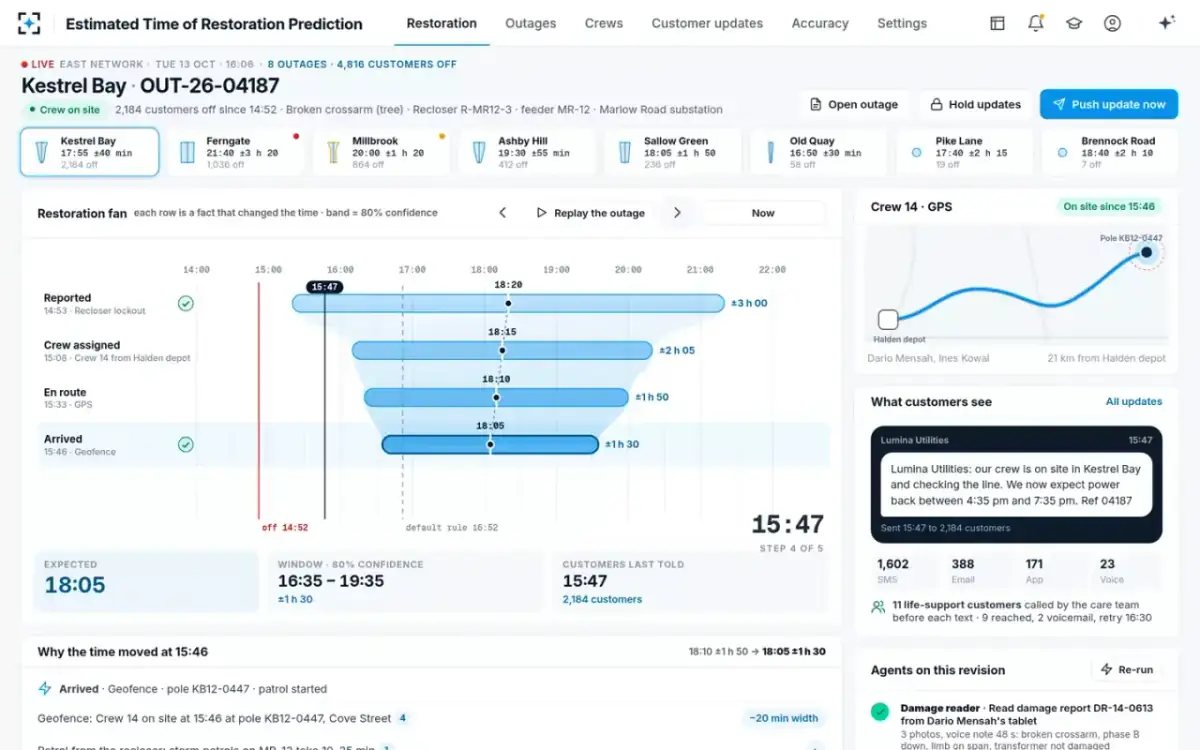

- 0415:46 · on site
The geofence says the crew has arrived
Crew trackerAt 15:46 Crew 14 enters the geofence at pole KB12-0447 on Cove Street, and the patrol from the recloser starts. Storm patrols on MR-12 take 10 to 25 minutes. The window has halved since the last text, from 6 hours to 3, so customers are told the crew is on site: 18:05, between 16:35 and 19:35.
15:47 text: “Our crew is on site in Kestrel Bay and checking the line. We now expect power back between 4:35 pm and 7:35 pm.”
- 0516:04 · damage reported
The damage report, from the tablet
Dario Mensah · Lead lineworker, Crew 14Dario files damage report DR-14-0613 with three photos and a 48-second voice note: crossarm broken at the centre bolt, phase B down but not burnt, an oak limb on the span already cleared, transformer TX-KB-118 not damaged. Make safe was done at 16:02, earthed both ends. The damage reader reads the form, the photos and the voice note and names what is broken.
Voice note: “Crossarm's snapped at the bolt on 0447, B phase on the ground, limb's off now. Transformer looks fine. We've got a crossarm on the truck. Call it an hour and a half, give or take.”

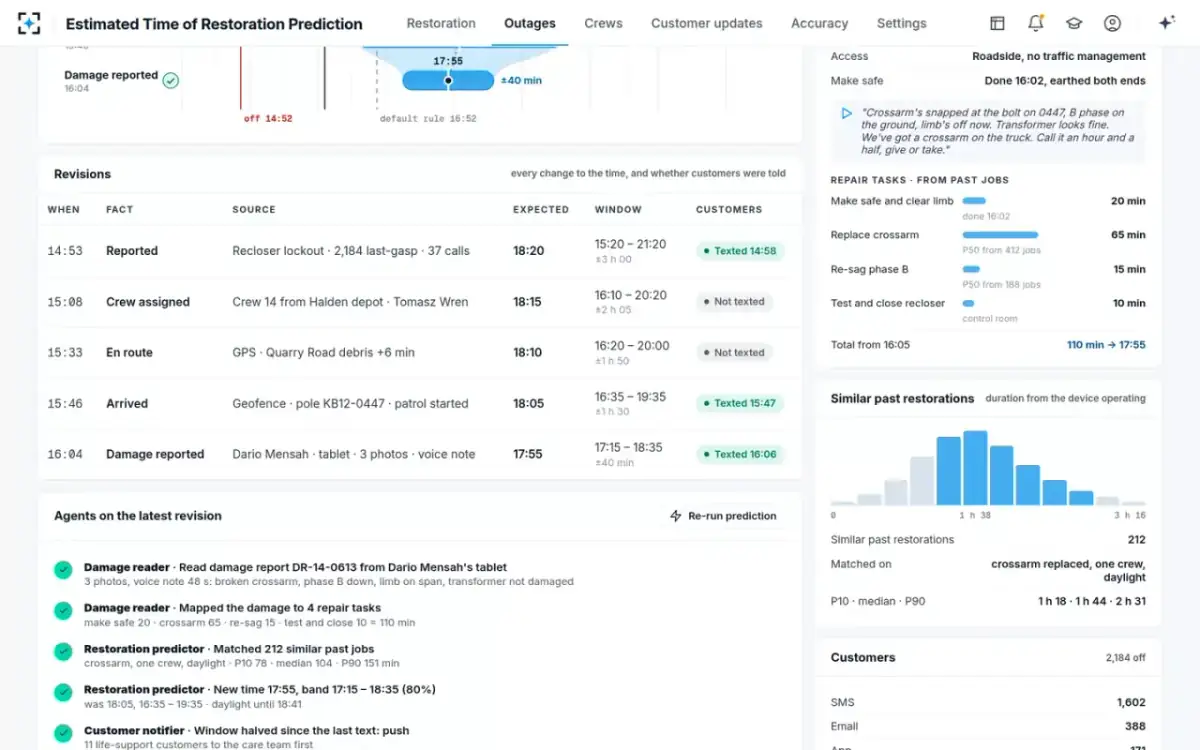

- 0616:05 · re-predicted
Four repair tasks, 212 similar jobs, a band of ±40 minutes
Damage reader and Restoration predictorThe damage reader maps the report to four repair tasks with durations from past jobs: make safe and clear the limb 20 minutes, replace the crossarm 65, re-sag phase B 15, test and close the recloser 10 — 110 minutes from 16:05. The predictor matches 212 similar jobs (crossarm replaced, one crew, daylight): P10 78, median 104, P90 151 minutes. Daylight lasts until 18:41, so no lighting set-up is needed. New time 17:55, band 17:15–18:35.
The predictor never shows a time without its band, and never narrows the band past what the evidence supports.
- 0716:05 – 16:08

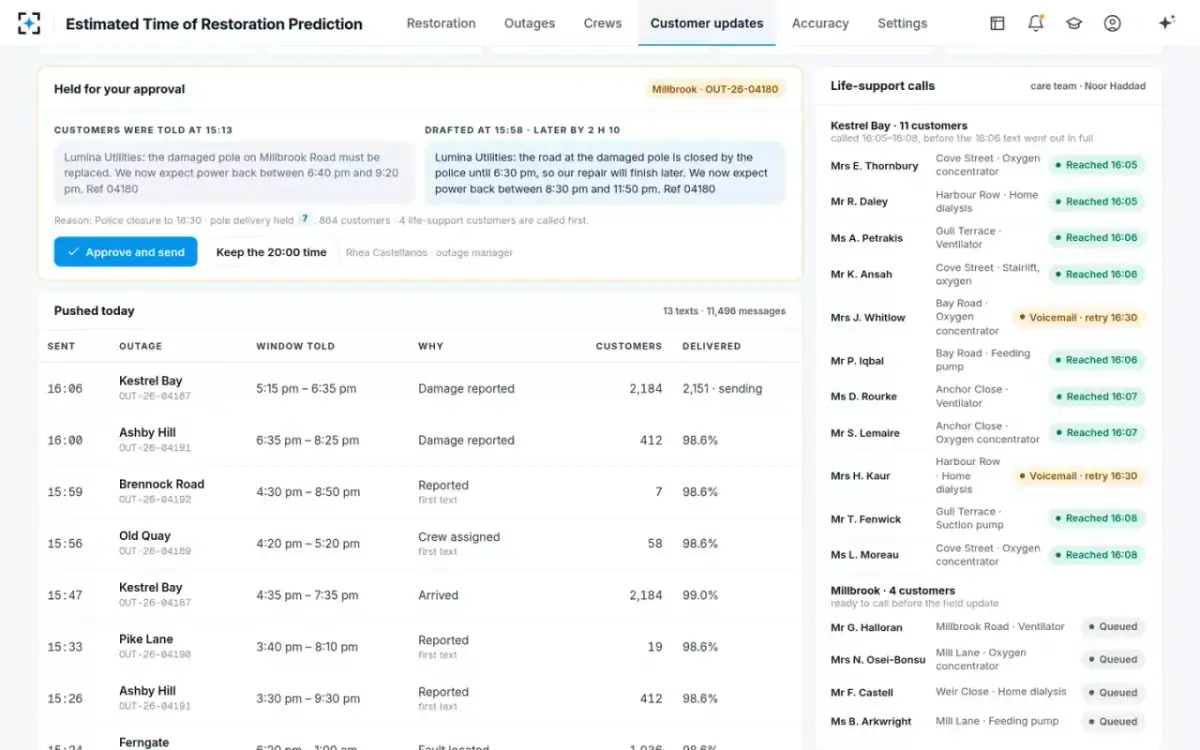

Life-support customers hear first
Noor Haddad · Care team leadThe window has halved again, so the customer notifier pushes — and queues the 11 life-support customers in Kestrel Bay for the care team before the bulk text. Noor's team calls them between 16:05 and 16:08: oxygen concentrators, home dialysis, ventilators, a feeding pump, a suction pump. Nine are reached; Mrs J. Whitlow and Mrs H. Kaur go to voicemail, with a retry at 16:30. Then 2,184 customers get the new window: 1,602 by SMS, 388 by email, 171 in the app and 23 by voice.

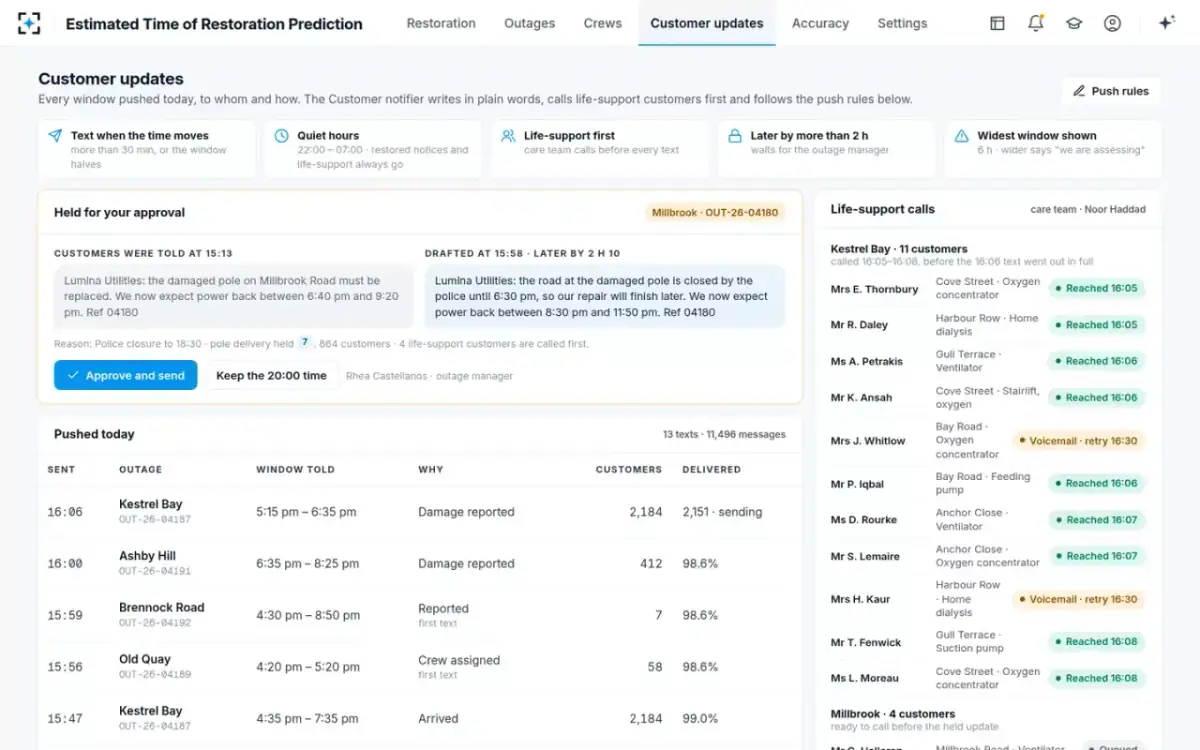

16:06 text: “Lumina Utilities: the crew found a damaged pole fitting on Cove Street and is repairing it. We expect power back between 5:15 pm and 6:35 pm.”

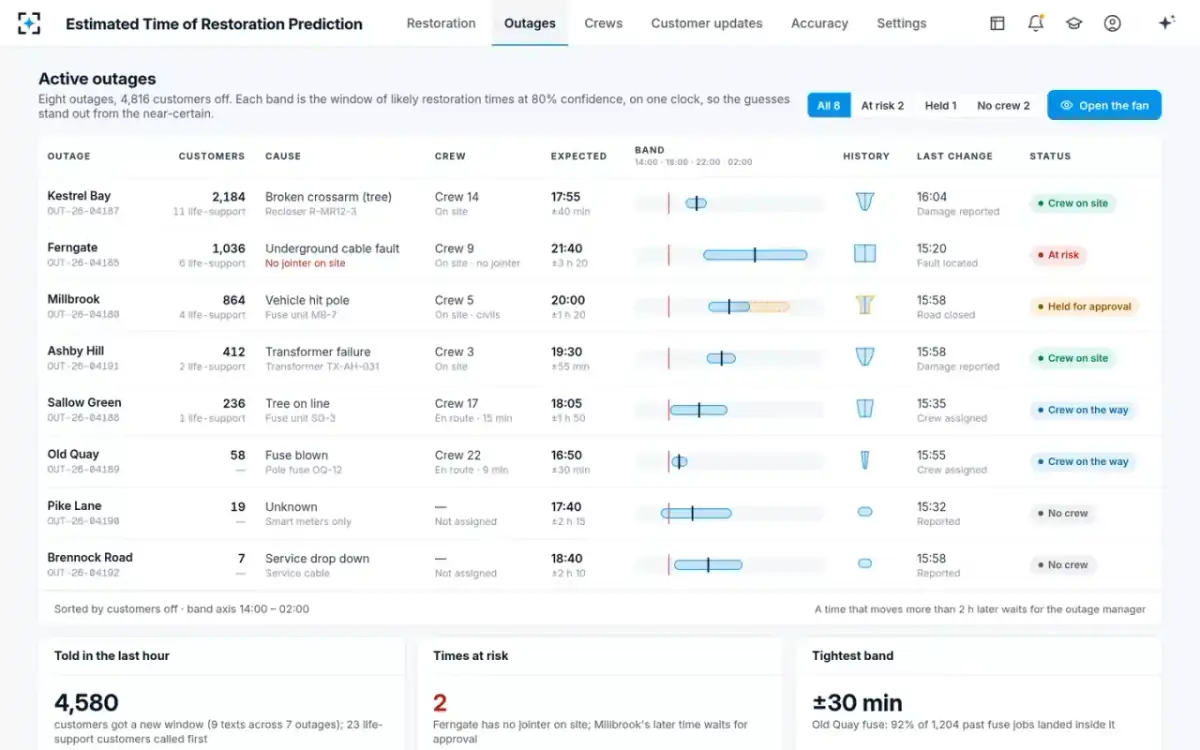

- 08Held · later by 2 h 10
A much later time waits for the outage manager
Rhea Castellanos · Outage managerIn Millbrook a vehicle snapped a pole, and the police now keep Millbrook Road closed until 18:30, so the pole truck cannot reach the site. The new window, 8:30 pm to 11:50 pm, is 2 h 10 later than the 864 customers were told at 15:13. The notifier drafts the text and holds it. Rhea sees both messages side by side and chooses Approve and send — the 4 life-support customers are called first — or Keep the 20:00 time, and the predictor re-checks at 16:30.
“Later by more than 2 h — waits for the outage manager”
- 0916:06 · at risk
A staging recommendation, for the dispatcher to accept

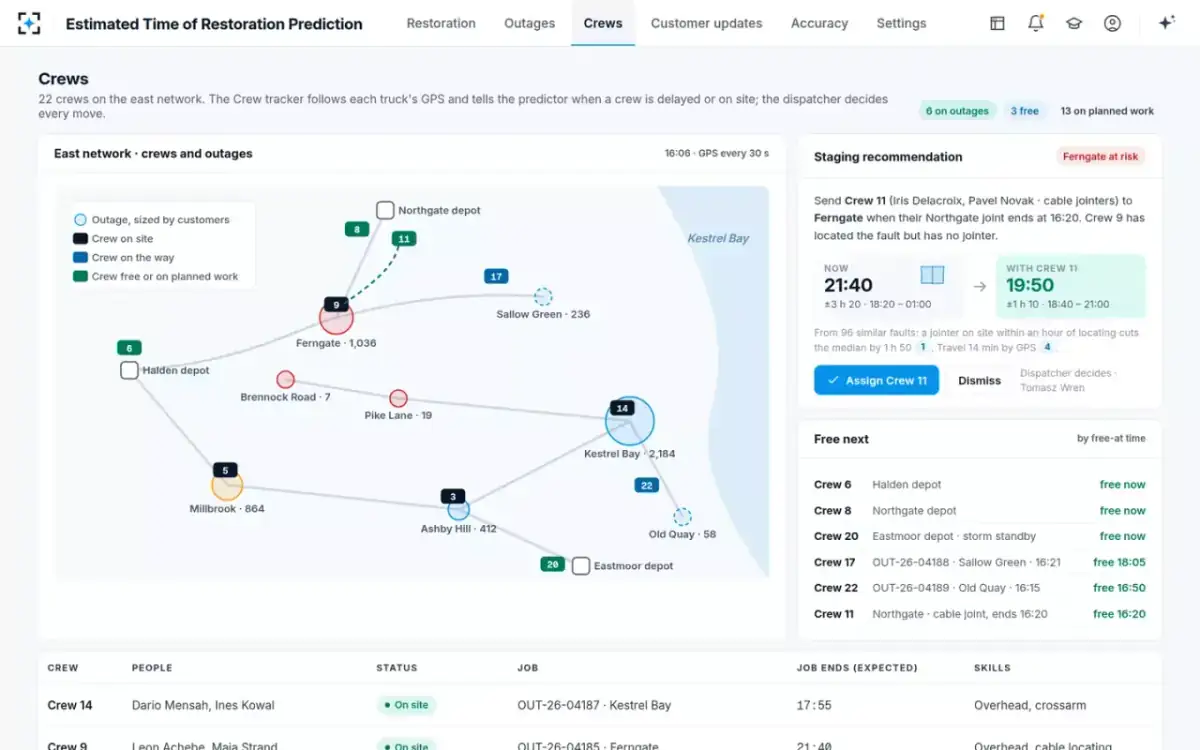

Tomasz Wren · Distribution dispatcherFerngate is at risk: Crew 9 has located an underground cable fault 140 m from the breaker but has no jointer. Crew 11 — Iris Delacroix and Pavel Novak, cable jointers — finish a joint at Northgate at 16:20, 14 minutes away by GPS. From 96 similar faults, a jointer on site within an hour of locating cuts the median by 1 h 50. With Crew 11, Ferngate moves from 21:40 ±3 h 20 to 19:50 ±1 h 10.
“Dispatcher decides · Tomasz Wren” — the crew tracker never assigns or moves a crew.

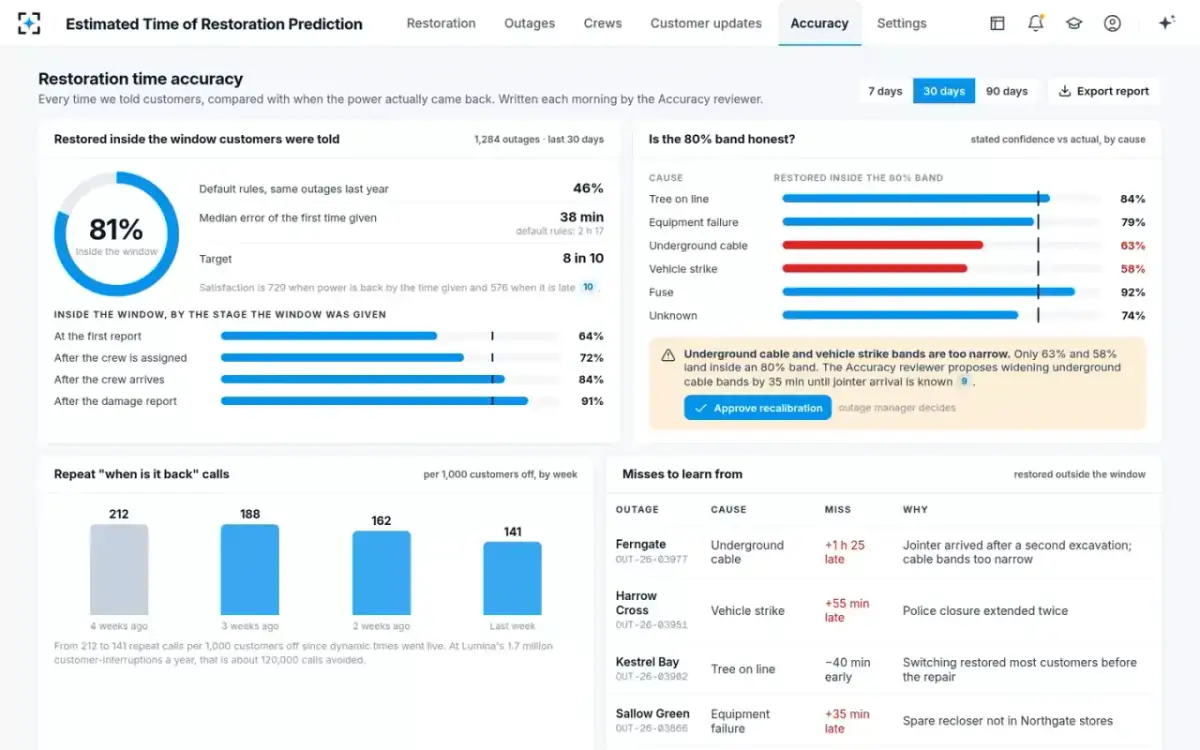

- 1006:00 next morning
Every time told, checked against when the power came back
Accuracy reviewerThe accuracy reviewer compares every window customers were told with the smart-meter restore events. Over 30 days, 81 % of 1,284 outages were restored inside the window; the first time given had a median error of 38 minutes, against 2 h 17 under the default rules. But underground cable and vehicle strike bands are too narrow — only 63 % and 58 % land inside an 80 % band — so it proposes widening underground cable bands by 35 minutes until jointer arrival is known. Rhea decides.
“Approve recalibration · outage manager decides” — the reviewer never changes the prediction on its own.
