- Before
- “I know where this loss is. It’s just that the only copy is in my head.” Six open large losses, held together in email and memory.
- Now
- Every document, payment and reserve on one timeline per loss; she accepts dates and pays, and the agents keep the picture current.
One loss, one morning: a contractor’s letter to an approved reserve
Kestrel Valley Foods’ frozen-food plant in Greeley, Colorado burned on Sunday 14 June 2026 at 02:40: roof collapse over the 41,000 sq ft production hall, three spiral freezers lost. It is Monday, day 120. Here is what happens next, screen by screen, in the working solution.
- 01Monday, day 120

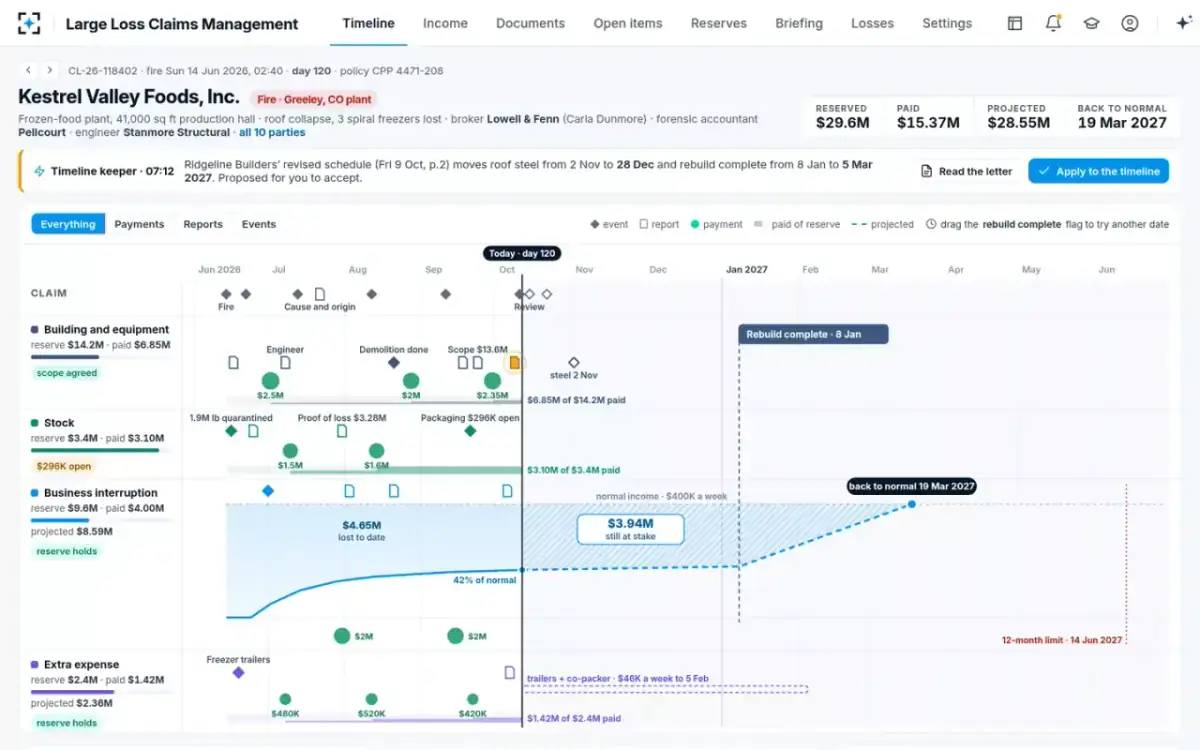

The whole loss on one timeline
Renata Okafor · General adjusterClaim CL-26-118402 under policy CPP 4471-208, on one screen from June 2026 to June 2027. Each coverage part has its own lane — building and equipment, stock, business interruption, extra expense — with its events, reports and payments, and its reserve and paid on the label. Reserved $29.6M, paid $15.37M, projected $28.55M, back to normal 19 Mar 2027.
Timeline keeper · 07:12: “Ridgeline Builders’ revised schedule (Fri 9 Oct, p.2) moves roof steel from 2 Nov to 28 Dec and rebuild complete from 8 Jan to 5 Mar 2027. Proposed for you to accept.”
- 0207:12

The contractor’s letter, read with its page

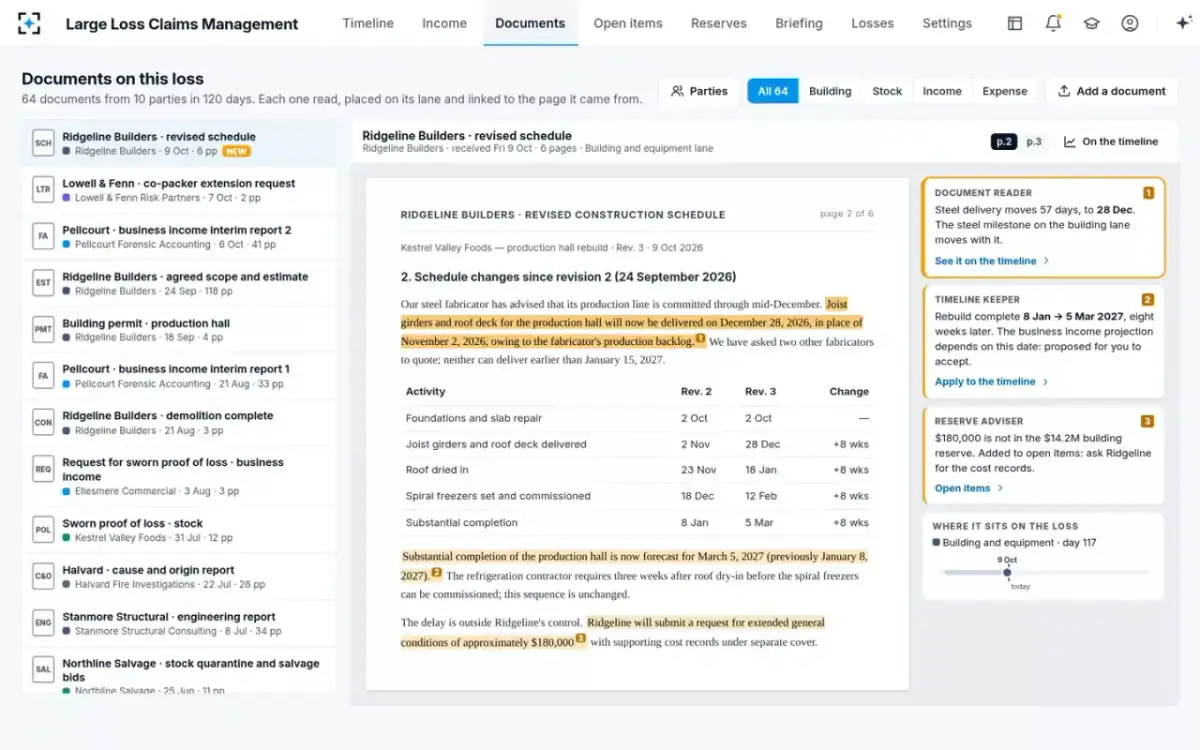

Document readerRidgeline’s revised construction schedule, Rev. 3 of 9 Oct, six pages. On page 2 the fabricator’s backlog moves joist girders and roof deck from 2 Nov to 28 Dec, and substantial completion from 8 Jan to 5 Mar 2027. On page 3, Ridgeline says it will seek about $180,000 in extended general conditions — not in the $14.2M building reserve, so it becomes an open item.
Document reader: “Steel delivery moves 57 days, to 28 Dec. The steel milestone on the building lane moves with it.”
- 03Next decision
Accept the new rebuild date?
Renata Okafor · General adjusterThe letter sits on the building lane. Click it and the three facts the agents took from it are there, each with its page. On the old date every reserve holds; accepting moves the business income projection and the reserves with it. The decision is hers.
Timeline keeper: “Restoration date is the adjuster’s to accept.”

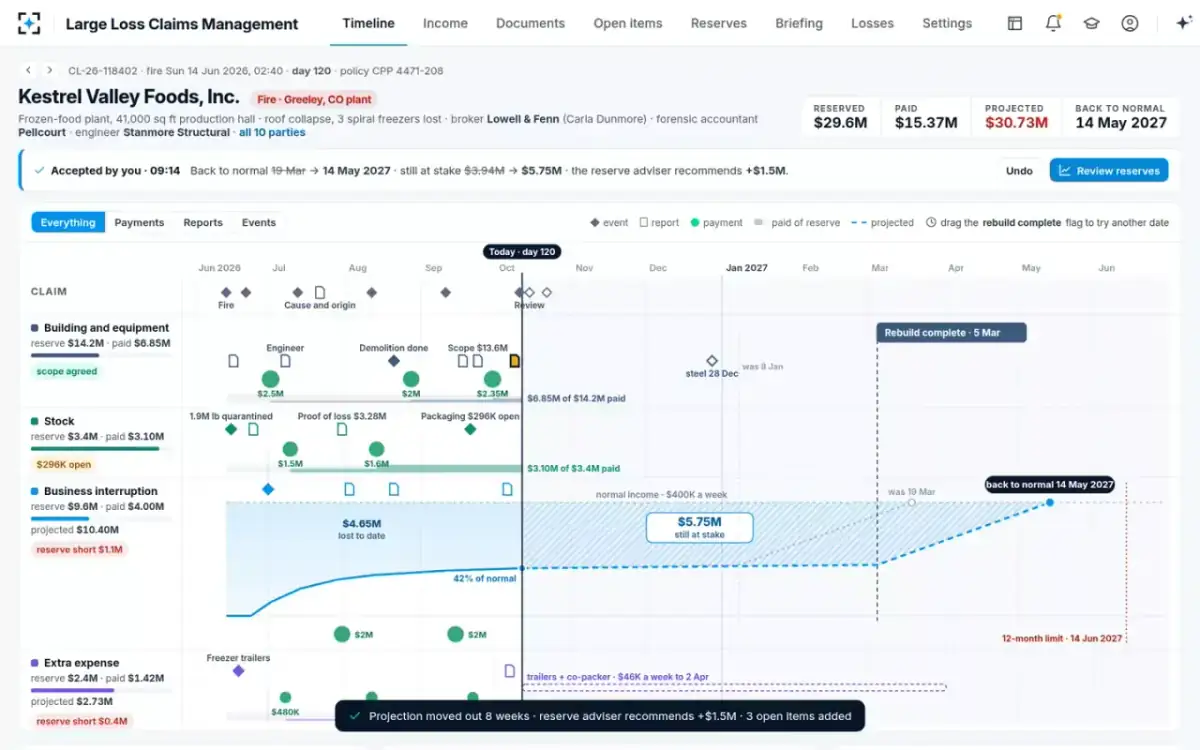

- 0409:14 · accepted
The income line moves out two months
Income projectorRenata applies the revised schedule. The rebuild-complete flag moves to 5 Mar, and the recovery line on the business interruption lane moves with it: back to normal goes from 19 Mar to 14 May 2027, and income still at stake from $3.94M to $5.75M. Business interruption now shows reserve short $1.1M and extra expense reserve short $0.4M; projected incurred rises to $30.73M.
“Projection moved out 8 weeks · reserve adviser recommends +$1.5M · 3 open items added.”
- 05Seconds later
Every step in view, with what it found

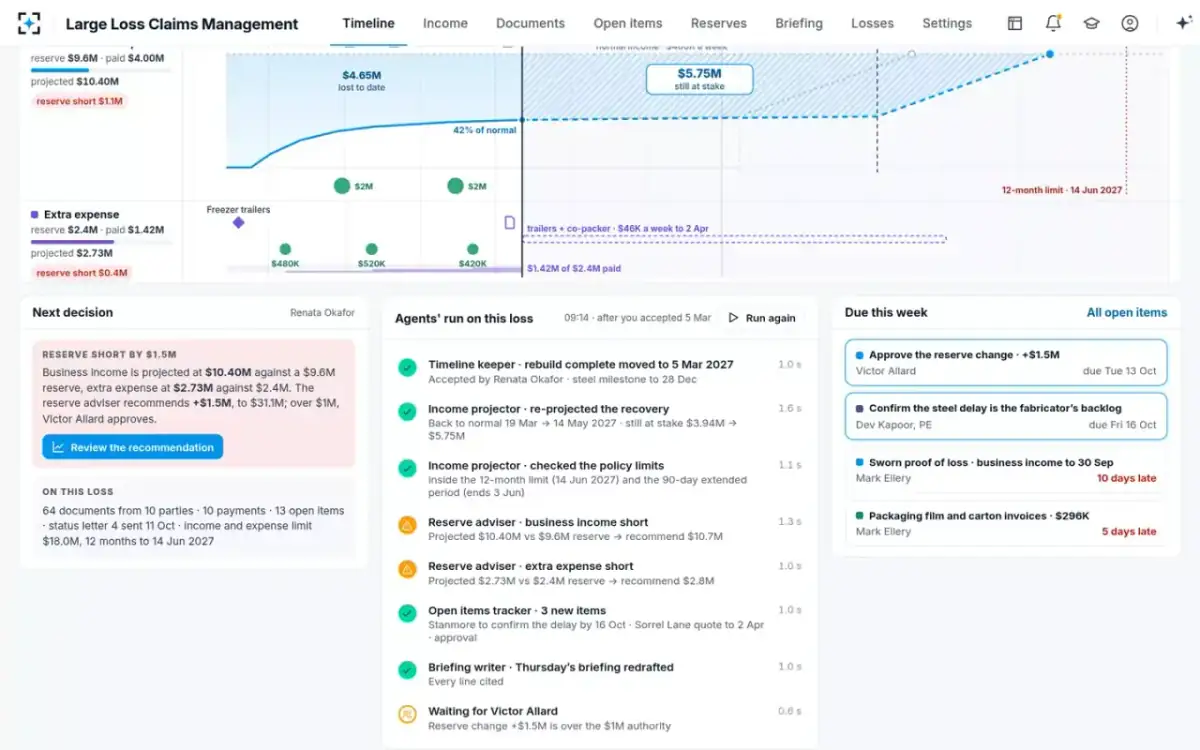

The agentsThe run is on the page: the timeline keeper moved rebuild complete, the income projector re-projected the recovery and checked the policy limits, the reserve adviser found business interruption and extra expense short, the open items tracker added three items, and the briefing writer redrafted Thursday’s briefing. The last step waits for a person.
“Waiting for Victor Allard — reserve change +$1.5M is over the $1M authority.”
- 06Business income
The forensic accountant’s measure, checked against the policy

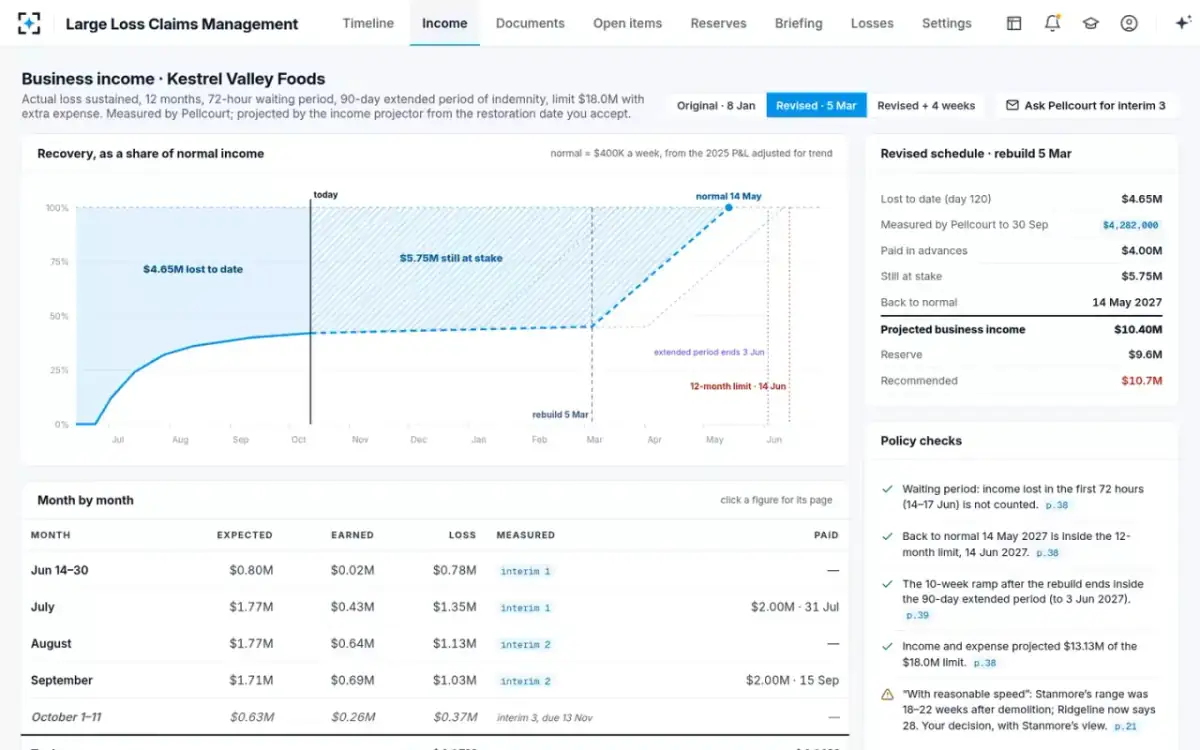

Income projectorActual loss sustained, 12 months, 72-hour waiting period, 90-day extended period of indemnity, $18.0M limit with extra expense. Pellcourt measured $4,282,000 to 30 Sep; normal income is $400K a week from the 2025 P&L adjusted for trend. Switch between the original, revised and revised-plus-four-weeks schedules; each policy check cites its page — including Stanmore’s 18–22 week estimate against Ridgeline’s 28.
“The projection is the agents’ view, for reserving. The measured loss is Pellcourt’s, and the restoration date is yours to accept.”

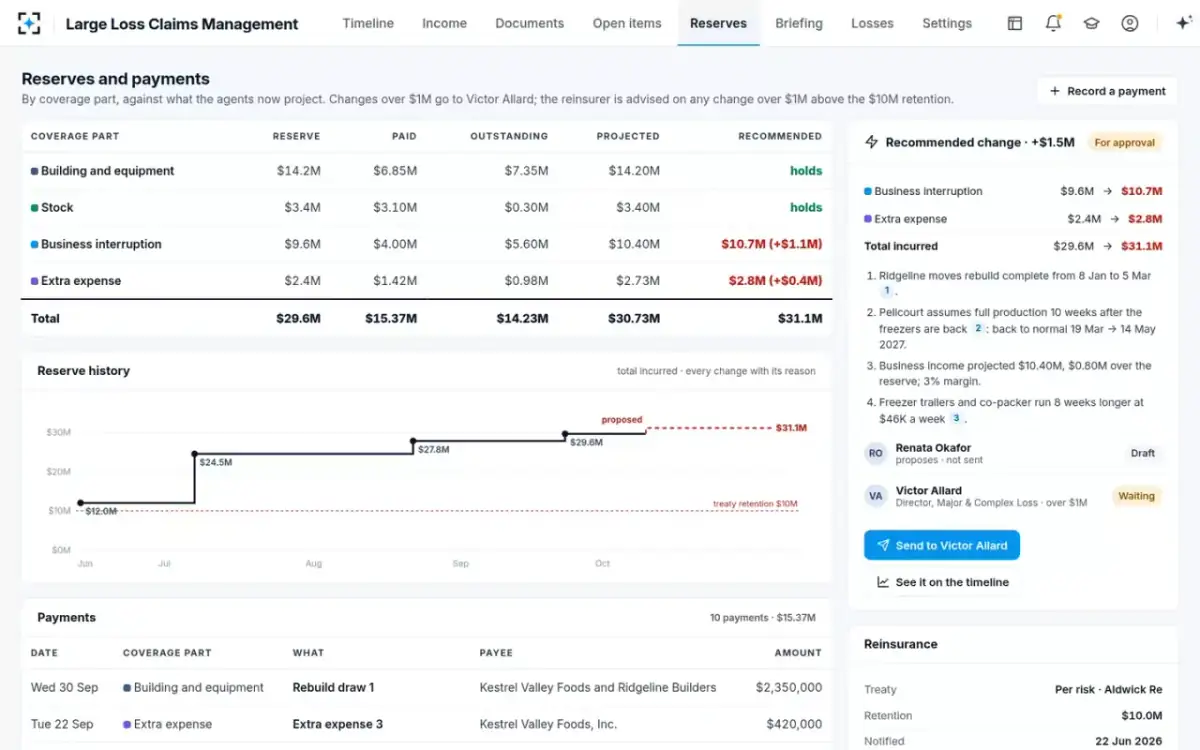

- 07Recommended
+$1.5M, by coverage part, with its reasons
Reserve adviserBuilding and stock hold. Business interruption $9.6M to $10.7M, extra expense $2.4M to $2.8M: total incurred $29.6M to $31.1M. Four numbered reasons, each cited: the rebuild moved, Pellcourt’s ten-week ramp, business income projected at $10.40M plus a 3% margin, and freezer trailers and co-packer running eight weeks longer at $46K a week.

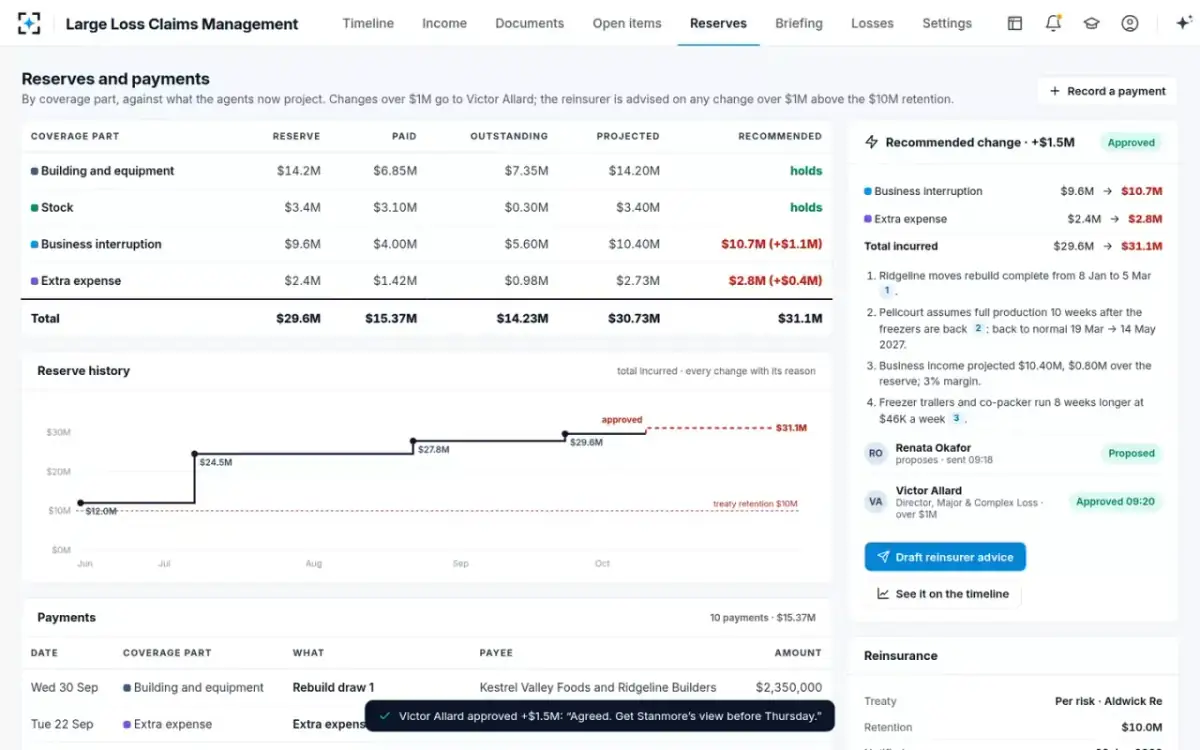

- 0809:20 · approved
The director approves the same morning
Victor Allard · Director, Major & Complex LossOver $1M, the change goes to Victor with the timeline, the projection and the reasons. He approves at 09:20. The reinsurer advice to Aldwick Re is drafted next — the per-risk treaty has a $10M retention, and the recoverable moves from $19.6M to $21.1M. Priya Lindgren in reinsurance accounting sends it.
Victor Allard: “Agreed. Get Stanmore’s view before Thursday.”
- 09Owners and dates
Who owes what, by when

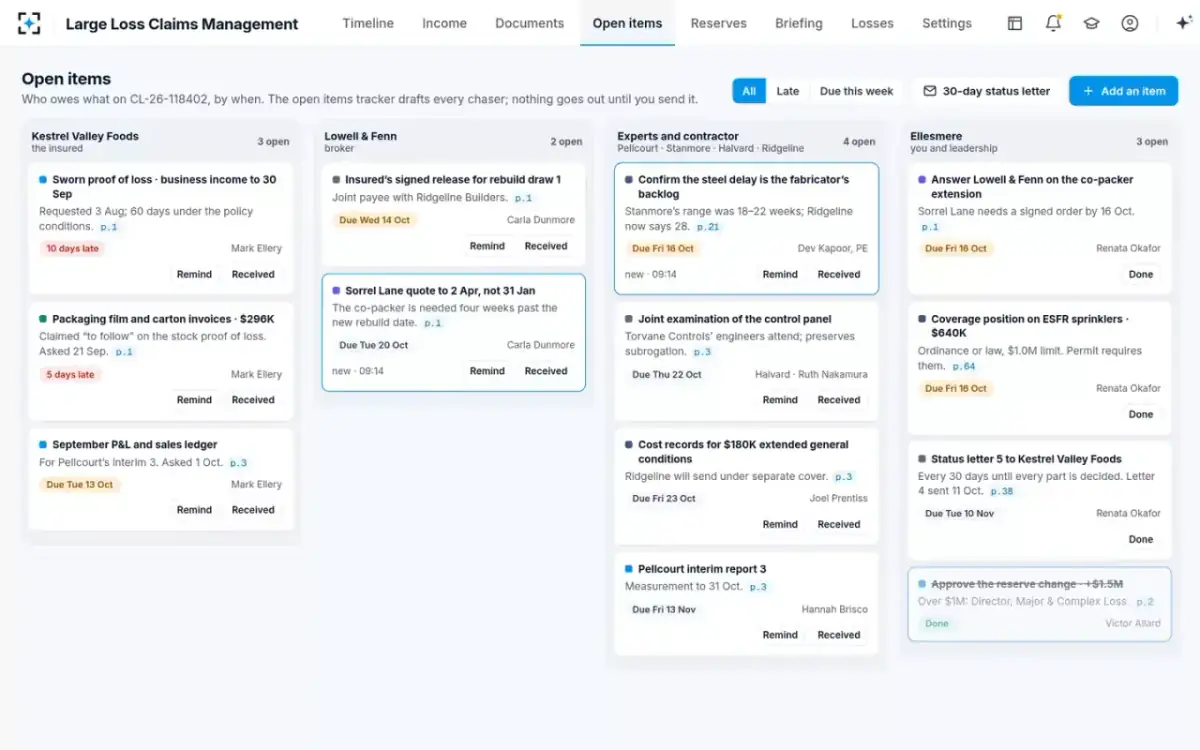

Open items trackerOpen items grouped by who owes them: the insured, the broker, the experts and contractor, and Ellesmere. New this morning: Stanmore’s Dev Kapoor to confirm the delay is the fabricator’s backlog by Fri 16 Oct, and a Sorrel Lane co-packing quote to 2 Apr. The sworn proof of loss for business income is 10 days late. Every chaser is drafted; nothing goes out until Renata sends it.
- 10For Thursday

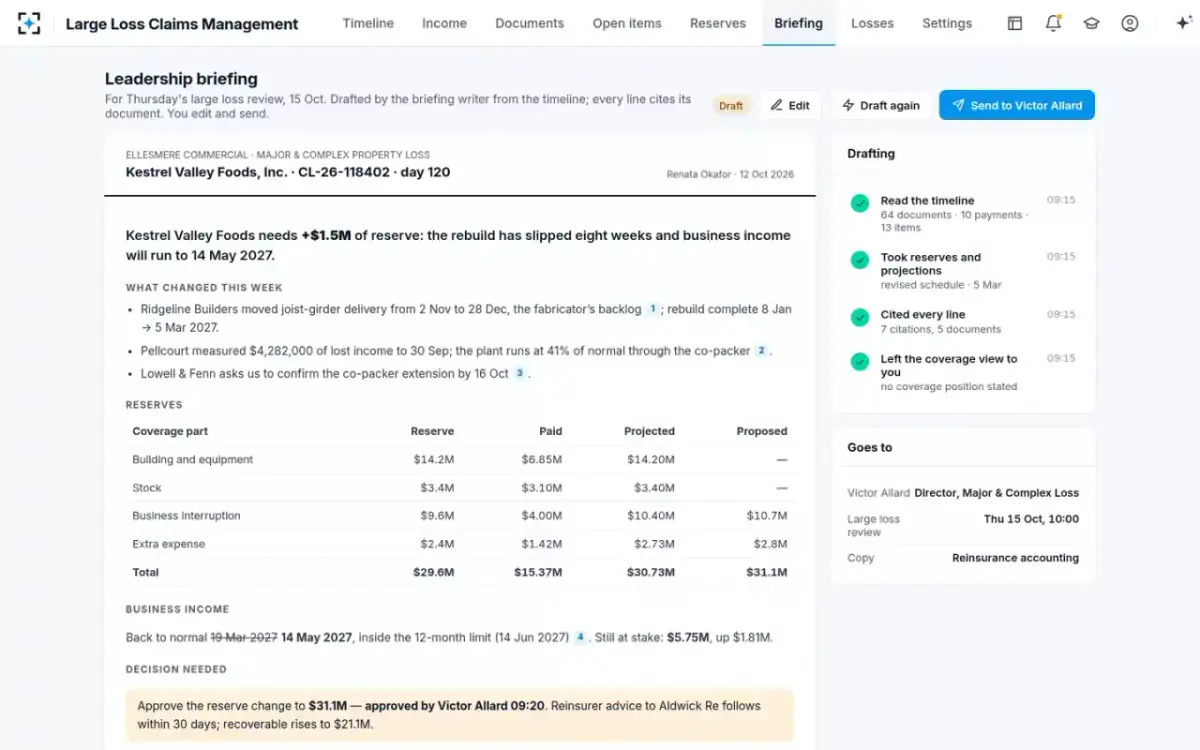

A one-page briefing, every line cited
Briefing writerFor the large loss review on Thu 15 Oct: “Kestrel Valley Foods needs +$1.5M of reserve: the rebuild has slipped eight weeks and business income will run to 14 May 2027.” What changed this week, reserves by coverage part, business income and the decision — with 7 citations to 5 documents. Renata edits it and sends it to Victor.
Briefing writer: “Left the coverage view to you — no coverage position stated.”
