- Before
- Hears that the program is green on a status slide, and finds out what is not ready when it is close to the gate.
- Now
- Starts her day with what would stop the first flight and the fix that needs her, priced and checked, then approves or signs on cited evidence.
One first revenue flight, rehearsed 211 days ahead
Corvane Airways' first A350-900 revenue flight is CV 30 from Denver to Tokyo Narita on Friday, May 14, 2027, on N351CV. Today is October 15, 2026. This is how aircraft entry into service runs in the working solution, screen by screen: the agents rehearse the flight, find what would stop it, and the VP Technical Operations decides.
- 0107:40 MT
What needs her, with the evidence, on one screen

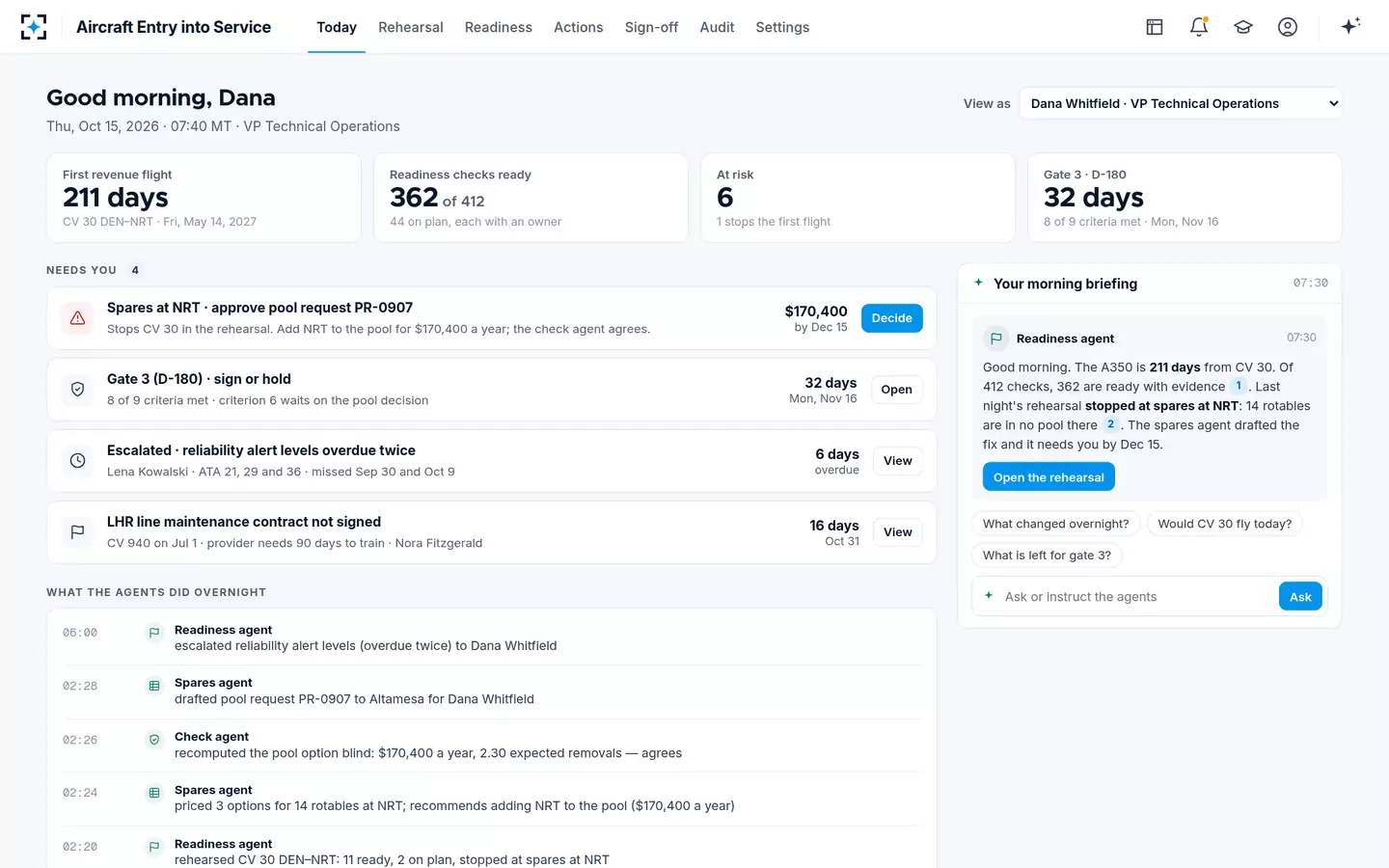

Dana Whitfield · VP Technical OperationsDana's morning starts with four numbers: 211 days to CV 30, 362 of 412 readiness checks ready, 6 at risk with 1 that stops the first flight, and gate 3 in 32 days with 8 of 9 criteria met. Four items need her, at the top a pool request for spares at NRT. Below is what the agents did overnight, and the readiness agent's briefing, which she can ask questions of in plain words.
Briefing: “Last night's rehearsal stopped at spares at NRT: 14 rotables are in no pool there. The spares agent drafted the fix and it needs you by Dec 15.”
- 0202:20, overnight
The first revenue flight, rehearsed moment by moment
Readiness agentThe readiness agent walked CV 30 through its 14 moments, from crew sign-in at 09:05 to the records after arrival. Each moment reads its records: two captains and two first officers typed and current, OpSpec B342 for ETOPS in FAA review on Nov 19, performance data for N351CV, ETOPS alternates ANC and CTS. Eleven were ready and two on plan. It stopped at step 12, spares at NRT.
“CV 30 would not fly as planned today: 11 ready, 2 on plan, 1 not ready.”
- 03Step 12
Fourteen rotables in no pool at Narita
Spares agentThe NRT station kit lists 41 parts, and 27 are covered by initial provisioning, shipping to the NRT bonded store by Apr 20. The other 14 rotables are in no pool there: pool agreement PA-2024-118 covers DEN, SEA and LHR. It was signed for the London launch. Schedule change SC-0412 moved the launch to Narita on Aug 27, and Materials was not on its distribution. The check agent read the same sources blind and got the same result.
“If CV 30 landed at NRT and a rotable failed on the turn, there would be no spare at NRT, and CV 31 back to DEN would cancel.”
- 0402:24 to 02:28

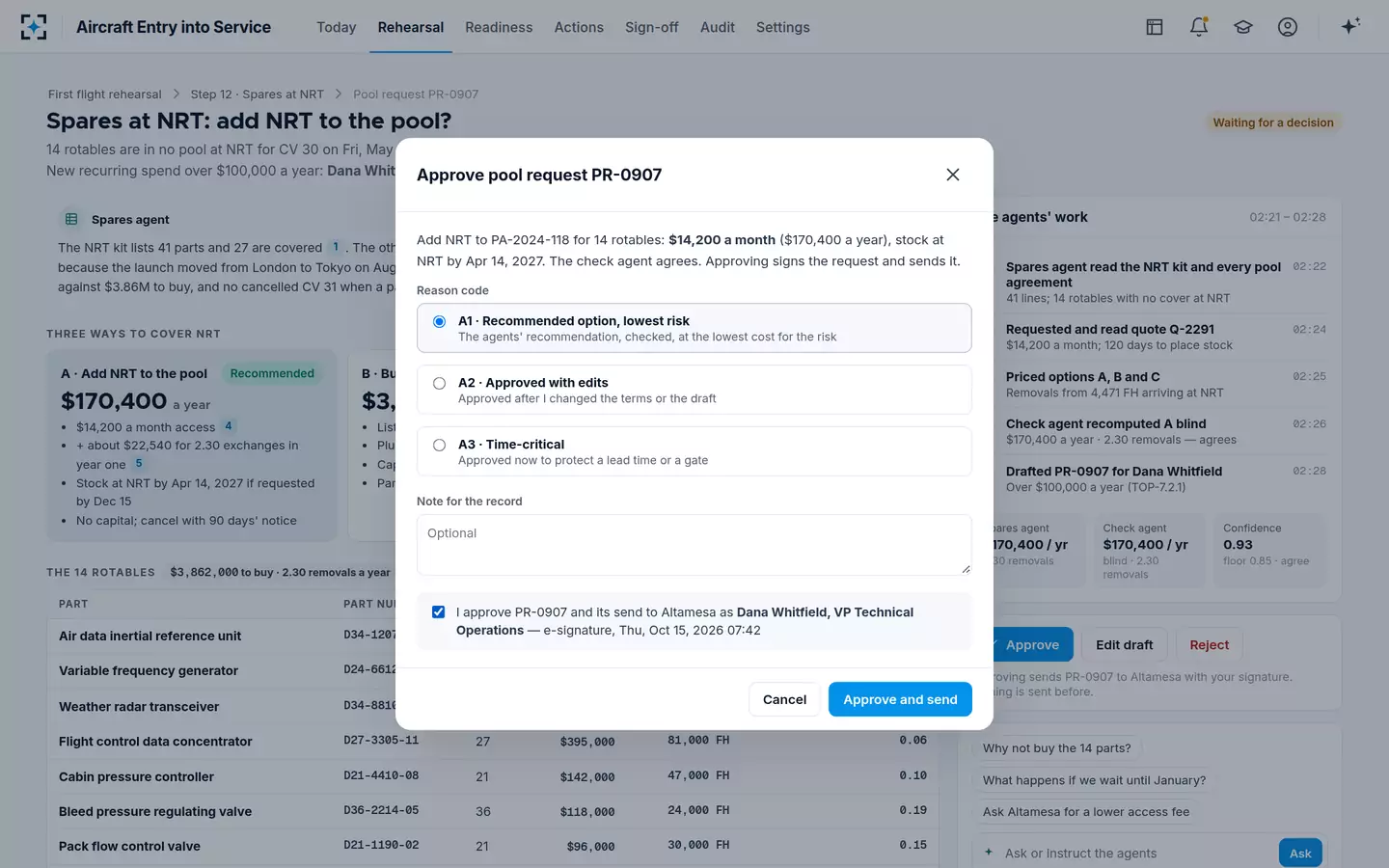

Three fixes, priced, and a second reading
Spares agent · Check agentThe spares agent priced three ways to cover NRT. A: add NRT to the pool for $14,200 a month, $170,400 a year, with about $22,540 of exchanges, stocked by Apr 14 if requested by Dec 15. B: buy and stock the 14 rotables for $3,862,000 of capital. C: fly parts in from DEN, about $1.1M of exposure with each event canceling CV 31. The check agent recomputed option A blind, at $170,400 a year and 2.30 expected removals, and agrees at confidence 0.93.
“I recommend A: about $192,940 in year one against $3.86M to buy, and no canceled CV 31 when a part fails at NRT.”
- 0507:42
She approves with a reason code and her signature
Dana Whitfield · VP Technical OperationsNew recurring spend over $100,000 a year needs the VP Technical Operations, so the drafted pool request PR-0907 waits for Dana. She picks reason code A1, recommended option, lowest risk, and signs. Only then is the request sent to Altamesa Component Services with her signature. She could have edited the draft, asked for a lower access fee, or rejected it with a reason.
“I approve PR-0907 and its send to Altamesa as Dana Whitfield, VP Technical Operations — e-signature.”
- 06Rehearsed again
Every step of CV 30 is now ready or on plan
Readiness agentThe rehearsal runs again from the systems of record: 11 ready, 3 on plan, 0 not ready. Spares at NRT is on plan, with the 14 rotables at NRT by Apr 14, 2027 and Teresa Alvarez as owner. Readiness check SP-041 moves to on plan, and gate 3's criterion 6, a spares plan for every first-route station, is met.
“12 · Spares at NRT — on plan: Pool request PR-0907 approved; the 14 rotables are at NRT by Apr 14, 2027.”
- 07Readiness
A self-reported green that does not count
Check agentA check counts as ready only when its record proves it and the check agent agrees. On RA-031, the APU back-to-birth sheets for N352CV, the owner marked it ready and the maintenance program agent read 46 sheets in the delivery records index. The check agent read the sheets themselves and found 2 missing, for the turbine wheel and the compressor impeller. The check stays at risk and blocks gate 4 until both readings agree, and the owner has the action to get the 2 sheets from the manufacturer by Nov 30.
“The agents disagree, so this check is not ready.”
- 08Maintenance program

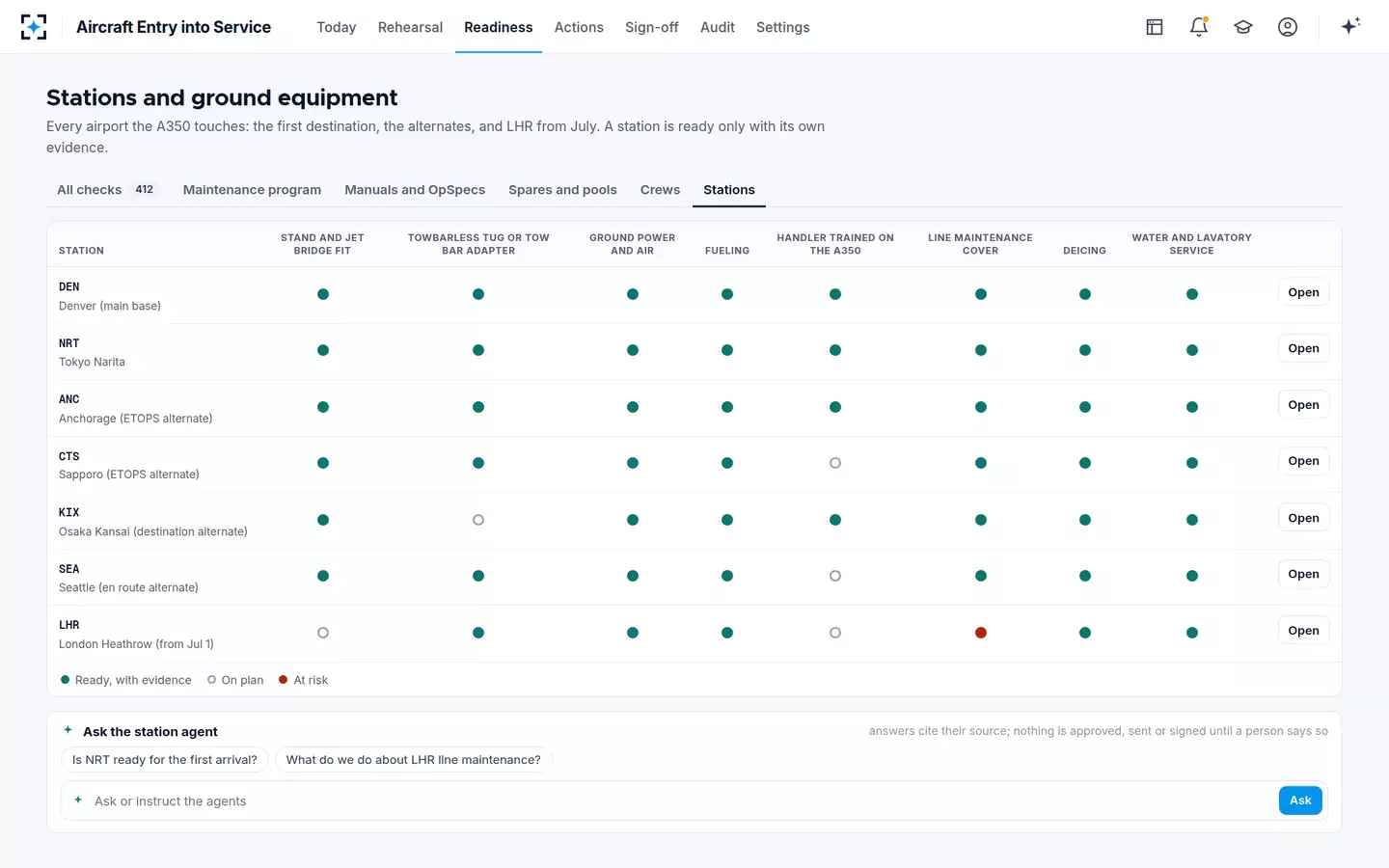

Every planning task mapped, every AD accounted for
Lena Kowalski · Maintenance Program EngineerThe maintenance program agent mapped 2,890 of the manufacturer's 2,914 planning tasks into Corvane's program, by ATA chapter, and lists the 24 task cards still to write by Jan 29. It read AD applicability for MSN 6412: 41 of 41 ADs accounted for, 3 of them recurring in the program. Lena's reliability alert levels for ATA 21, 29 and 36 are overdue, and the agents escalated them.
- 09FAA approvals
OpSpecs and proving tests, off the critical path

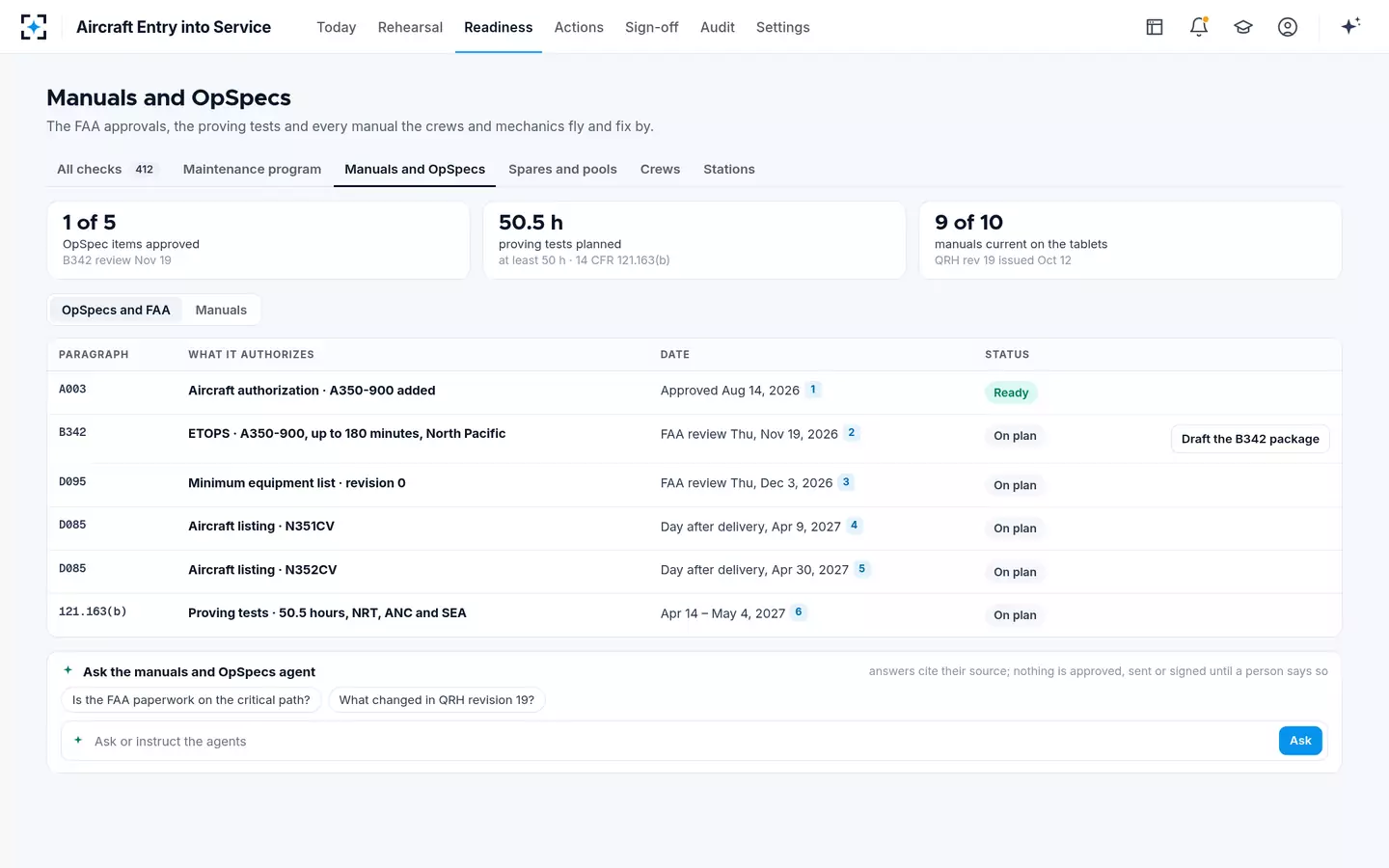

Manuals and OpSpecs agentOpSpec A003 for the A350-900 was approved Aug 14, 2026. B342, the ETOPS approval for the A350-900 up to 180 minutes over the North Pacific under Appendix P to Part 121, is in FAA review on Nov 19, and D095, MEL revision 0, on Dec 3. D085 adds each tail the day after delivery. The proving test plan under 14 CFR 121.163(b) is 50.5 hours, Apr 14 to May 4, 2027, at NRT, ANC and SEA. The agent drafts the B342 package; a person submits it.
Asked whether the FAA paperwork is on the critical path: “No, by 5 months.”

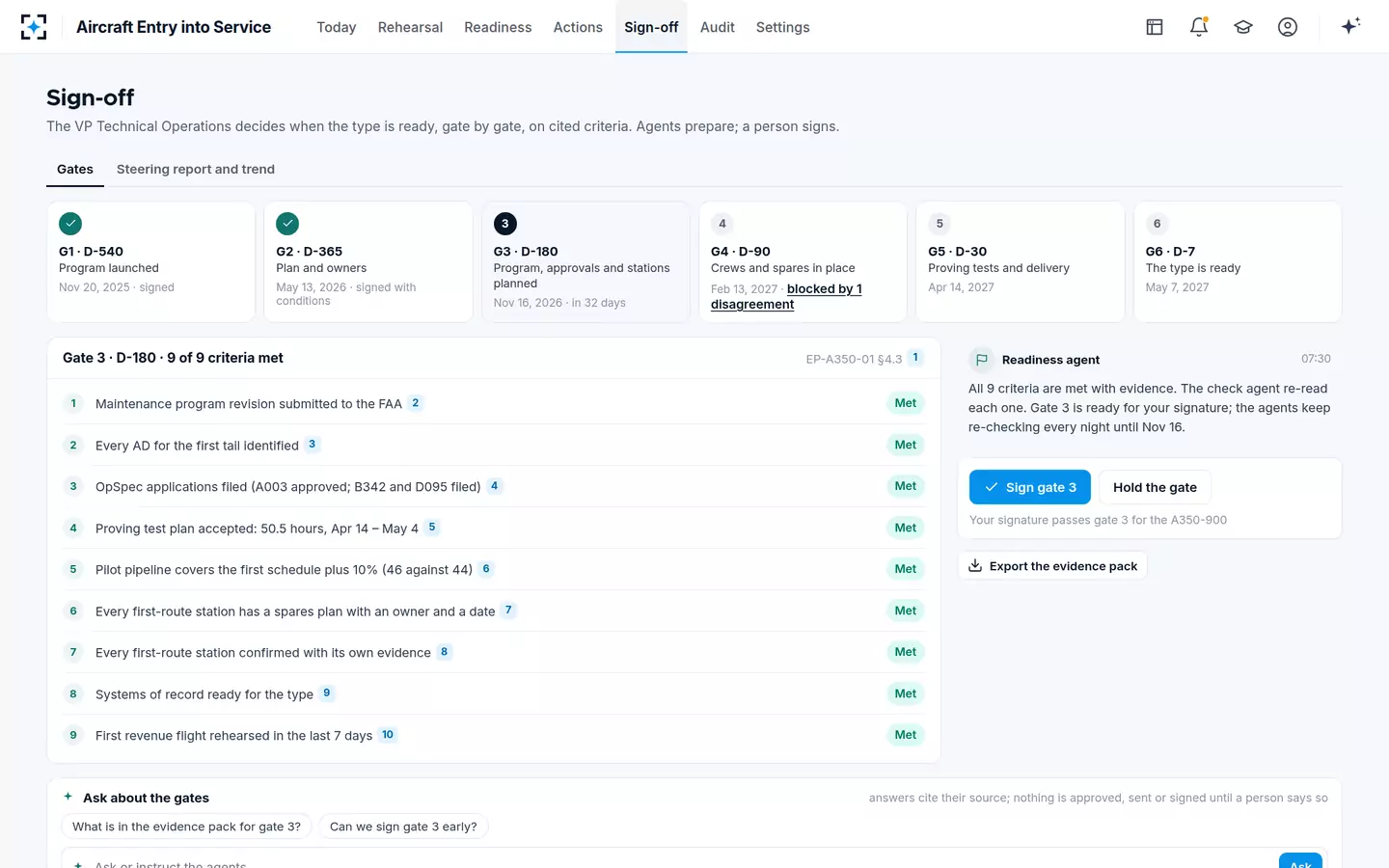

- 10Gate 3 · D-180
Nine criteria met, each with its source
Dana Whitfield · VP Technical OperationsGate 3 now shows all 9 criteria met, from the maintenance program revision submitted to the FAA to a first revenue flight rehearsed in the last 7 days, each with its source. The readiness agent says the gate is ready for her signature. She can sign or hold it with a reason, and export the evidence pack for the FAA principal inspectors.
“All 9 criteria are met with evidence. The check agent re-read each one.”
