- Before
- Runs nine phase-ins from spreadsheets and e-mail, and needs to know on Monday what will stop a jet flying on the 2nd — not find out on the 1st.
- Now
- Starts from the hangar and one note per bay saying what blocks service entry, then approves the drafted work orders and requests with a reason and his signature.

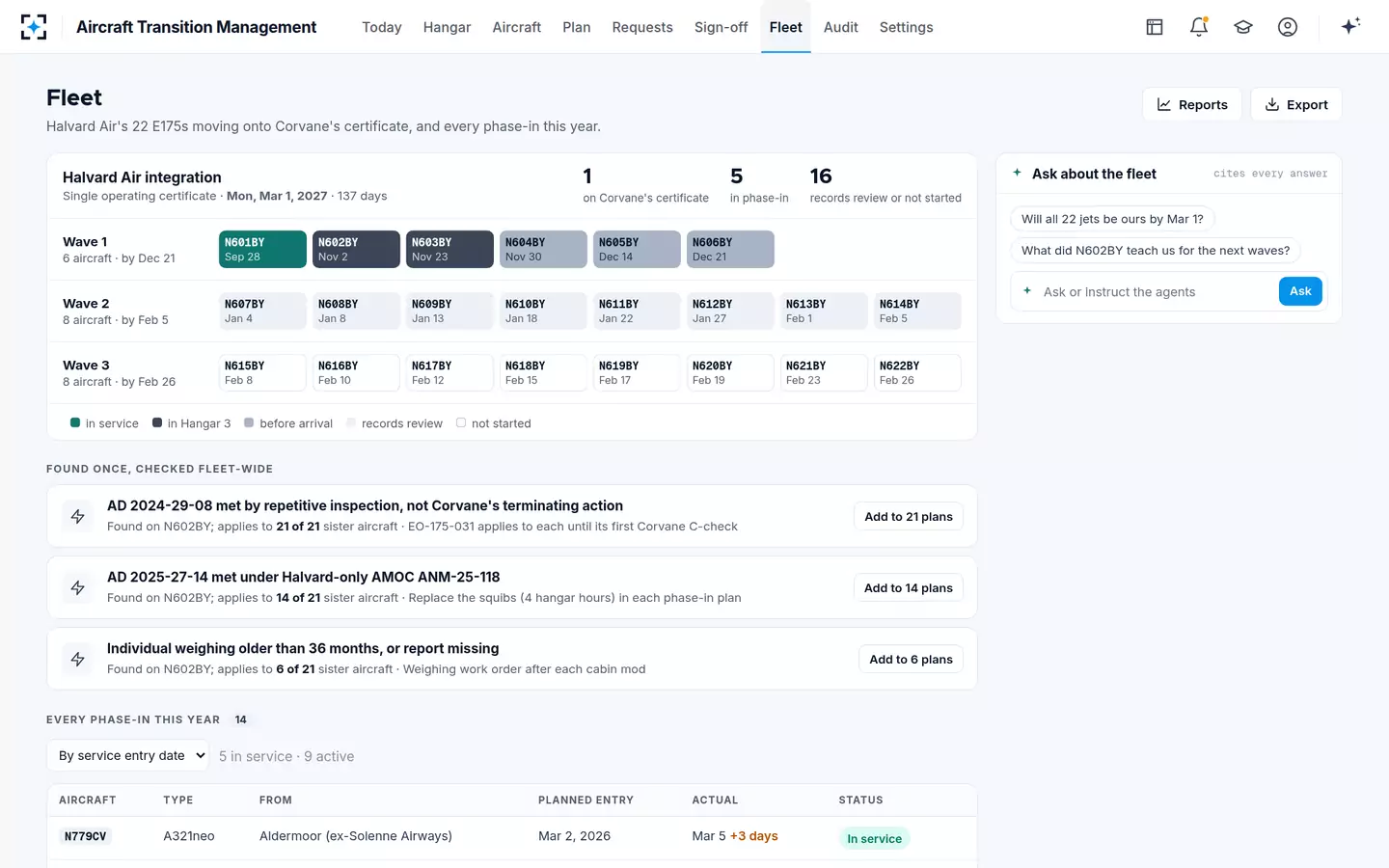

One aircraft phase-in: an acquired E175 from records boxes to its first revenue flight
Corvane Airways is folding the regional airline it acquired, Halvard Air, onto its certificate: 22 E175s in three waves. N602BY arrived in Bay 1 of Hangar 3 at DEN on Monday, Oct 12, and must fly CV4402 DEN–COS on Monday, Nov 2. Here is the aircraft transition, screen by screen, in the working solution.
- 01Thursday, 08:10
The agents' briefing, before the first coffee

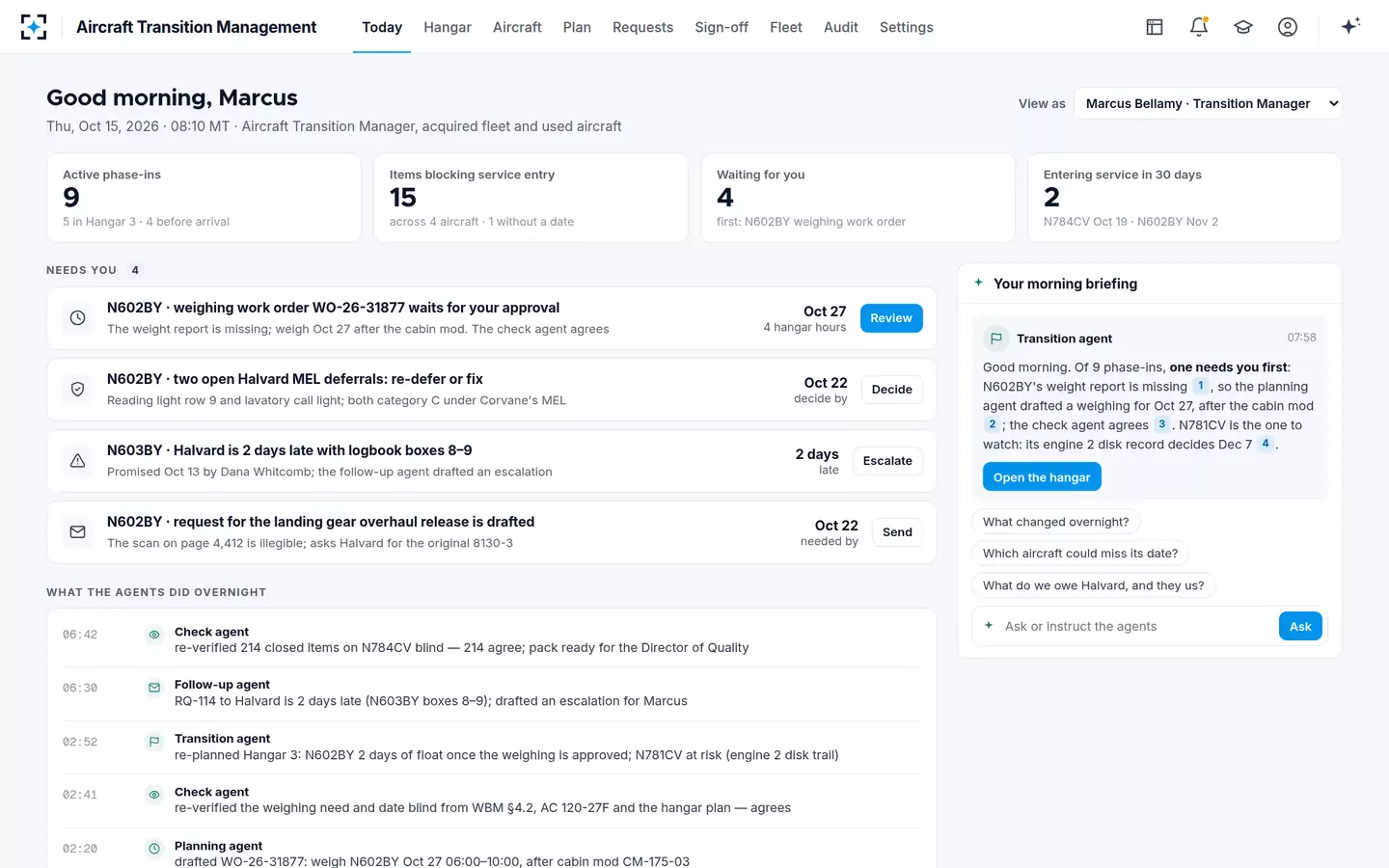

Marcus Bellamy · Aircraft Transition ManagerMarcus runs 9 active phase-ins, 5 in Hangar 3 and 4 before arrival. His morning screen shows 15 items blocking service entry across 4 aircraft and 4 decisions waiting for him. The transition agent's briefing names the one to take first, and every claim in it carries a numbered citation he can open.
“Of 9 phase-ins, one needs you first: N602BY's weight report is missing, so the planning agent drafted a weighing for Oct 27, after the cabin mod; the check agent agrees.”
- 02The hangar

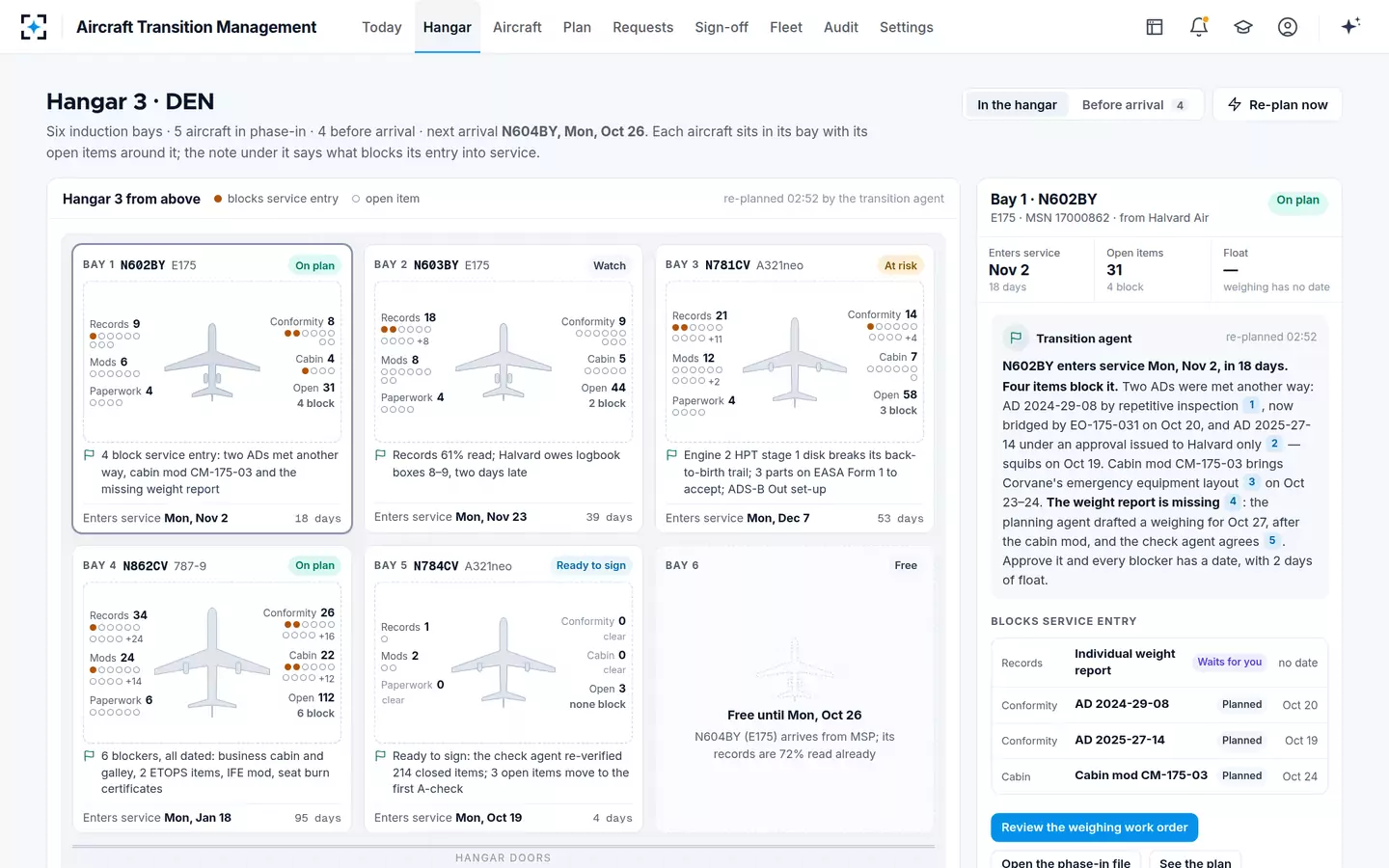

Every incoming aircraft in its bay, with what blocks it
Marcus Bellamy · Aircraft Transition ManagerHangar 3 is drawn from above: six induction bays, each aircraft with its open items grouped around it — records, conformity, mods, cabin, paperwork — and a filled dot for each blocker. N602BY in Bay 1 has 31 open items and 4 blockers. N781CV, an A321neo, is at risk on an engine 2 disk back-to-birth trail; N784CV is ready to sign. Bay 1's panel lists its blockers beside the transition agent's note.
“Approve it and every blocker has a date, with 2 days of float.” — the transition agent's note on Bay 1
- 03Overnight
14,206 pages read and indexed
Records agentOvernight the records agent read Halvard's 9 boxes and its records export, indexed to ATA Spec 2500 and the 121.380 list. The conformity agent checked 412 Corvane standards: 404 meet. The phase-in file sorts the 31 open items blockers first, each with an owner, a date and the agent's confidence, so Marcus can filter, assign or ask about any of them.

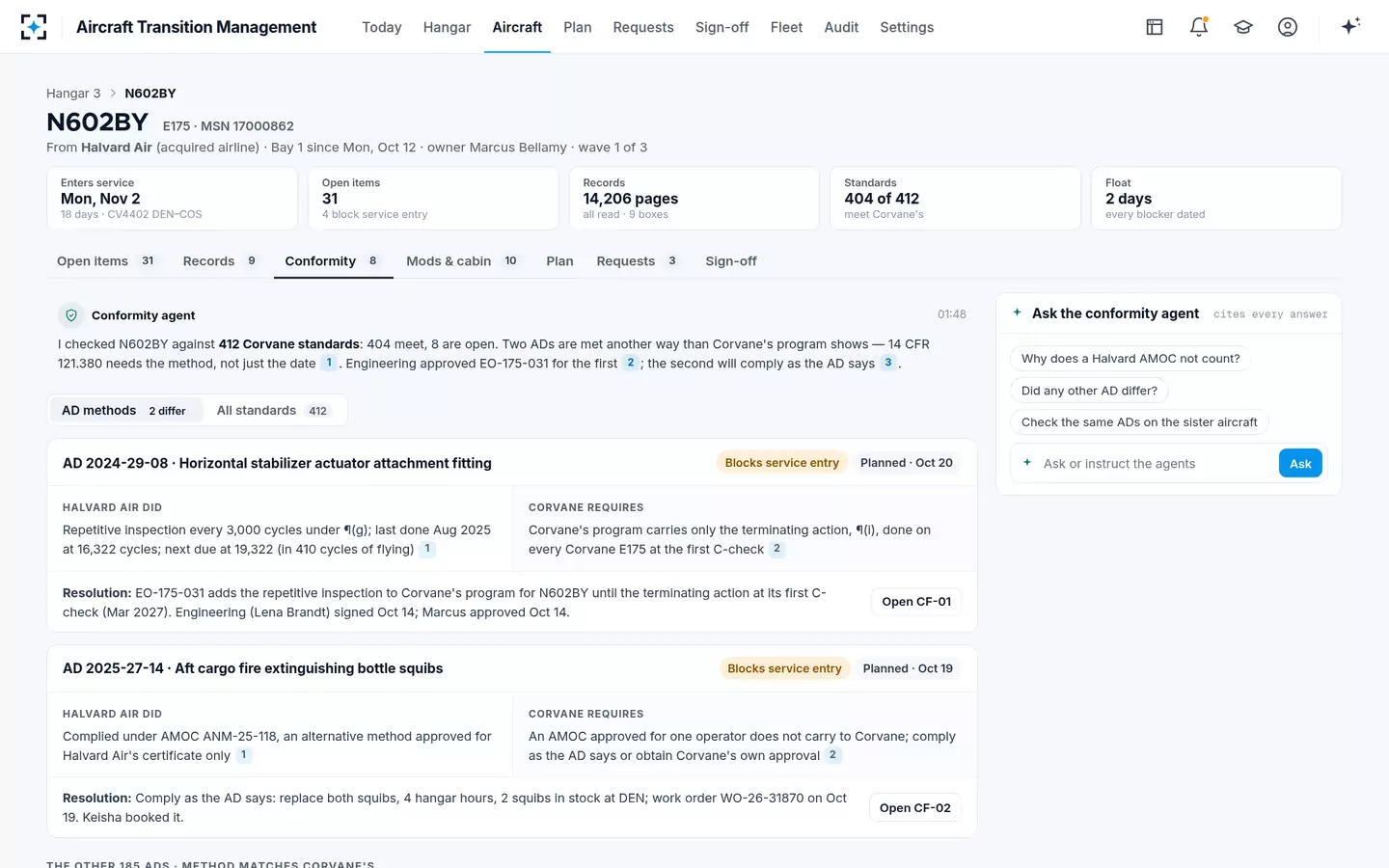

- 04AD methods
Two directives met another way
Conformity agentHalvard met AD 2024-29-08 by repetitive inspection every 3,000 cycles, under ¶(g); Corvane's program carries only the terminating action, ¶(i). Engineering order EO-175-031 bridges it until the first C-check, and Marcus approved it on Oct 14. AD 2025-27-14 was met under AMOC ANM-25-118, approved for Halvard Air only, so the cargo fire bottle squibs are replaced as the AD says: 4 hangar hours on Oct 19.
“An AMOC approved for one operator does not carry to Corvane; comply as the AD says or obtain Corvane's own approval.”
- 05Cabin
Corvane's emergency equipment layout
Mods & cabin agentTo reach Corvane's configuration N602BY needs 6 engineering orders and 4 cabin items, 35 hangar hours. One blocks service entry: cabin mod CM-175-03 moves the AED, smoke hoods and first-aid kits to where Corvane's cabin crew are trained to find them. The cabin is shown from above, Halvard today against Corvane's standard.
“Every part is in stock or on order with a date; I order nothing — stores do.”
- 06The missing report
“Not there” — and every place it looked
Records agentHalvard's technical log records a weighing on Jul 14, 2022, report HW-22-0614, but the report is in none of the 9 boxes or the export, and Halvard's archive replied “Not found”. Corvane weighs every aircraft before it enters service unless a weighing within 36 months is on file, and Jul 2022 is past 36 months anyway. The screen lists the five places the agents looked — three boxes with their page ranges, the export and the archive's reply.

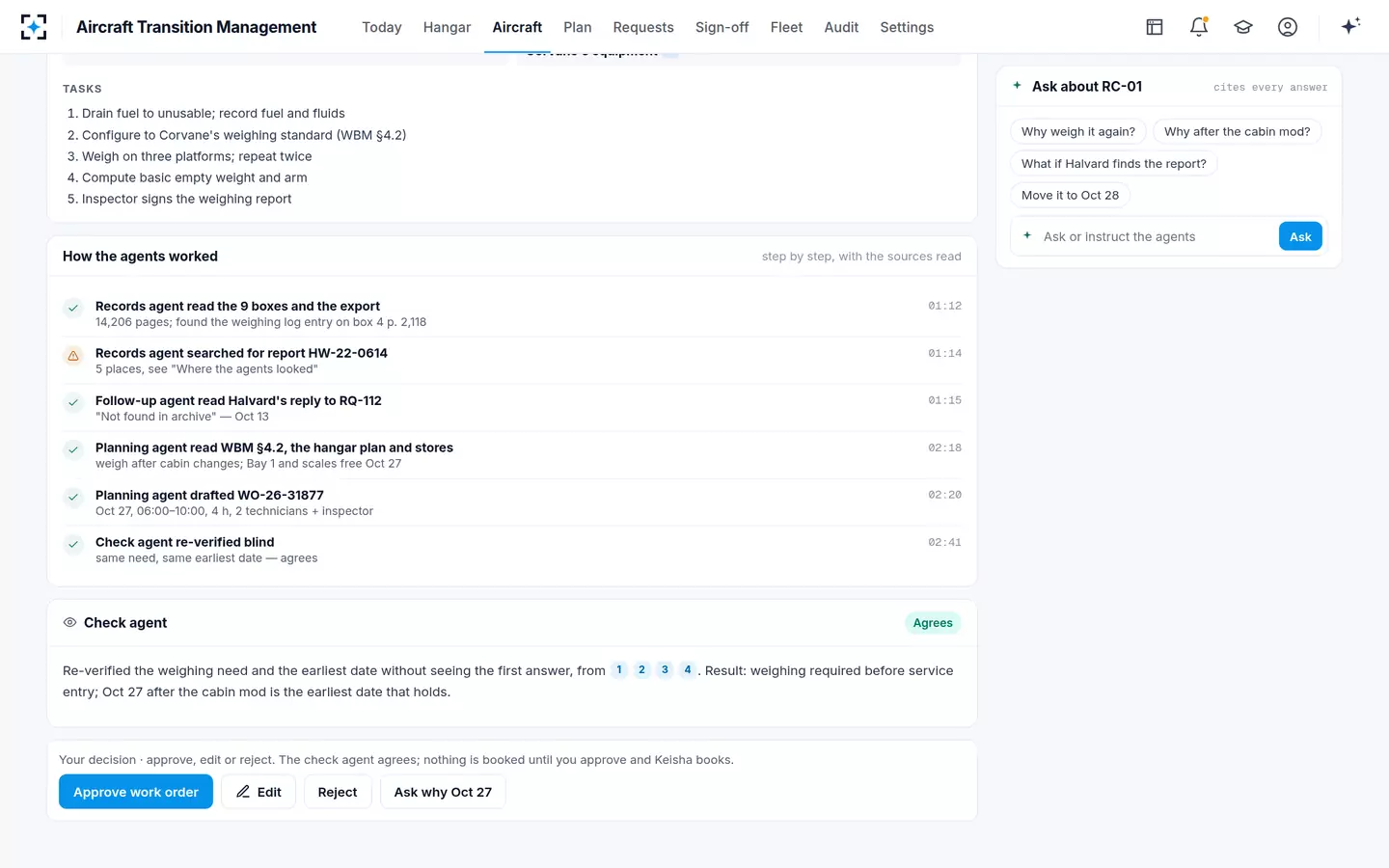

- 07Drafted at 02:20
A weighing in the order the work can be done
Planning agent and check agentThe planning agent drafted work order WO-26-31877: weigh N602BY in Bay 1 on Tue, Oct 27, 06:00–10:00 — after the cabin mod, so the weight includes Corvane's equipment — with 2 technicians, 1 inspector and platform scales SC-4410, calibrated to Jan 12, 2027. The check agent re-verified the need and the date blind, without seeing the first answer, and agrees.
“The check agent agrees; nothing is booked until you approve and Keisha books.”

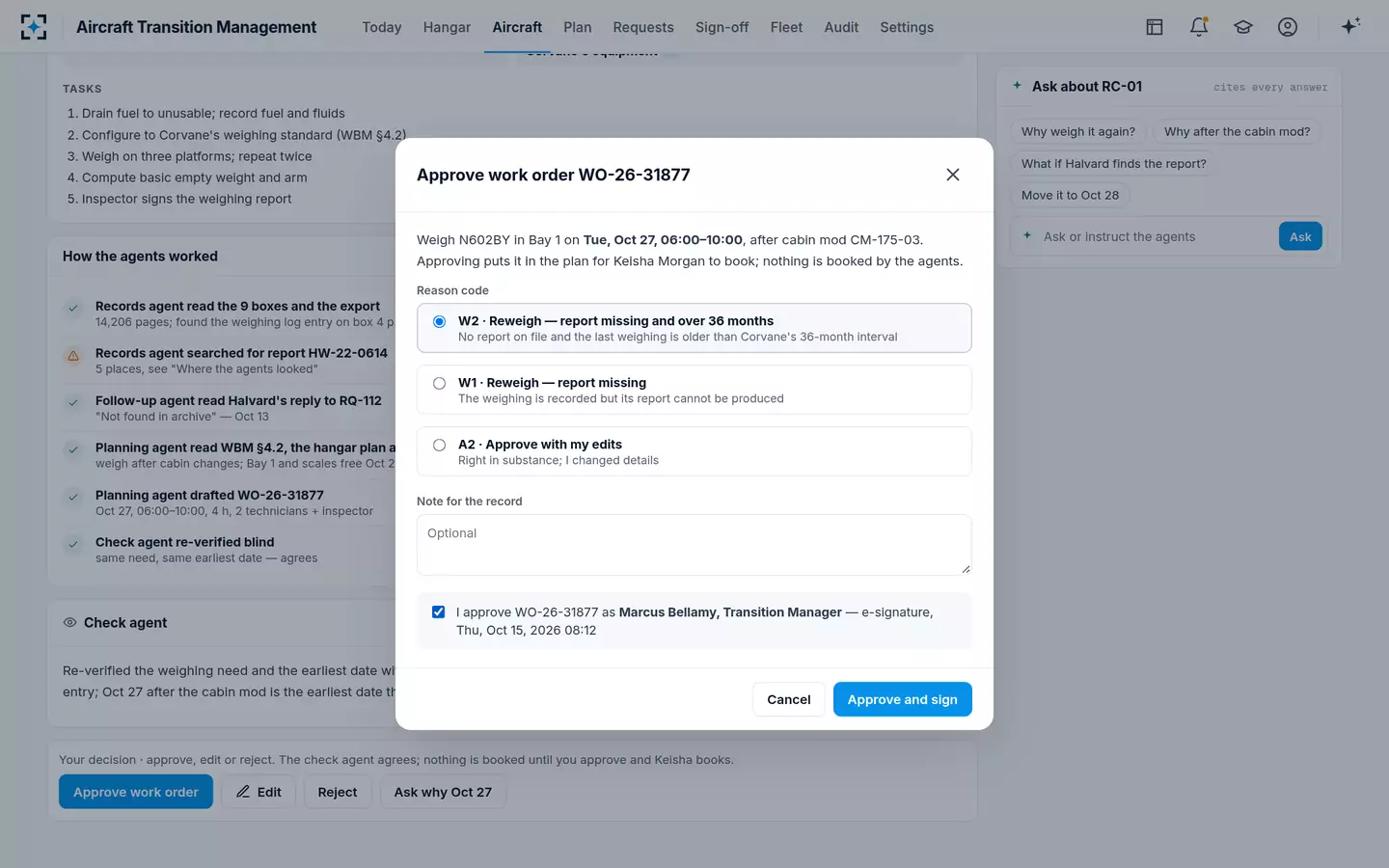

- 0808:12
He approves with a reason and his signature
Marcus Bellamy · Aircraft Transition ManagerMarcus picks reason code W2 — reweigh, report missing and over 36 months — adds a note if he wants one, and signs. Approving puts the work order in the plan for Keisha Morgan, the maintenance planner, to book; nothing is booked by the agents.
“I approve WO-26-31877 as Marcus Bellamy, Transition Manager — e-signature, Thu, Oct 15, 2026 08:12.”

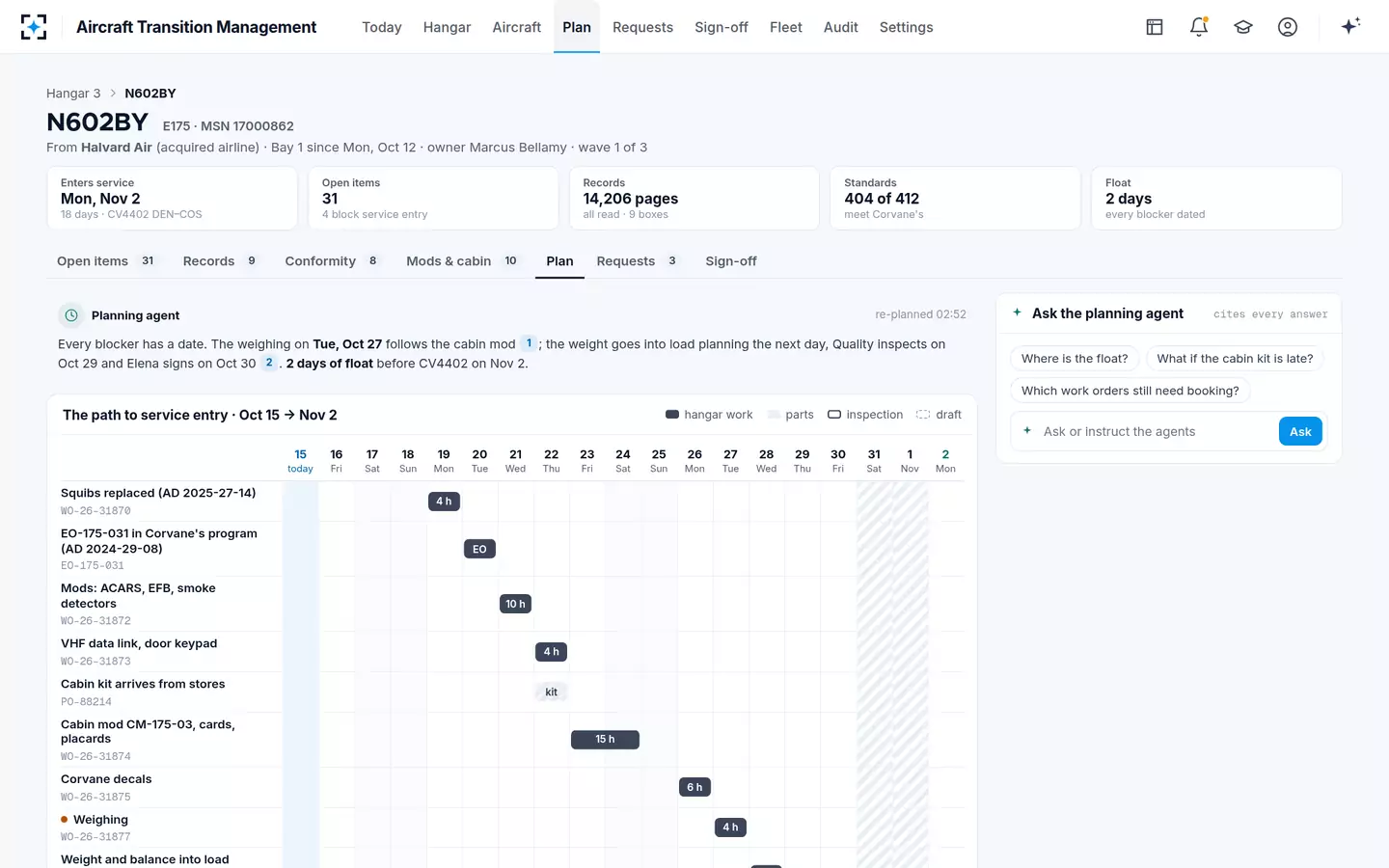

- 09Every blocker dated
The path to service entry, with 2 days of float
Planning agentThe plan now runs day by day from Oct 15 to Nov 2: squibs on Oct 19, the cabin kit from stores and cabin mod CM-175-03, decals, the weighing on Oct 27, weight and balance into load planning the next day, Quality's conformity inspection on Oct 29 and the Director of Quality's signature on Oct 30. Two days of float remain before CV4402. Moving the service entry date would need Helen Strand, VP Fleet.

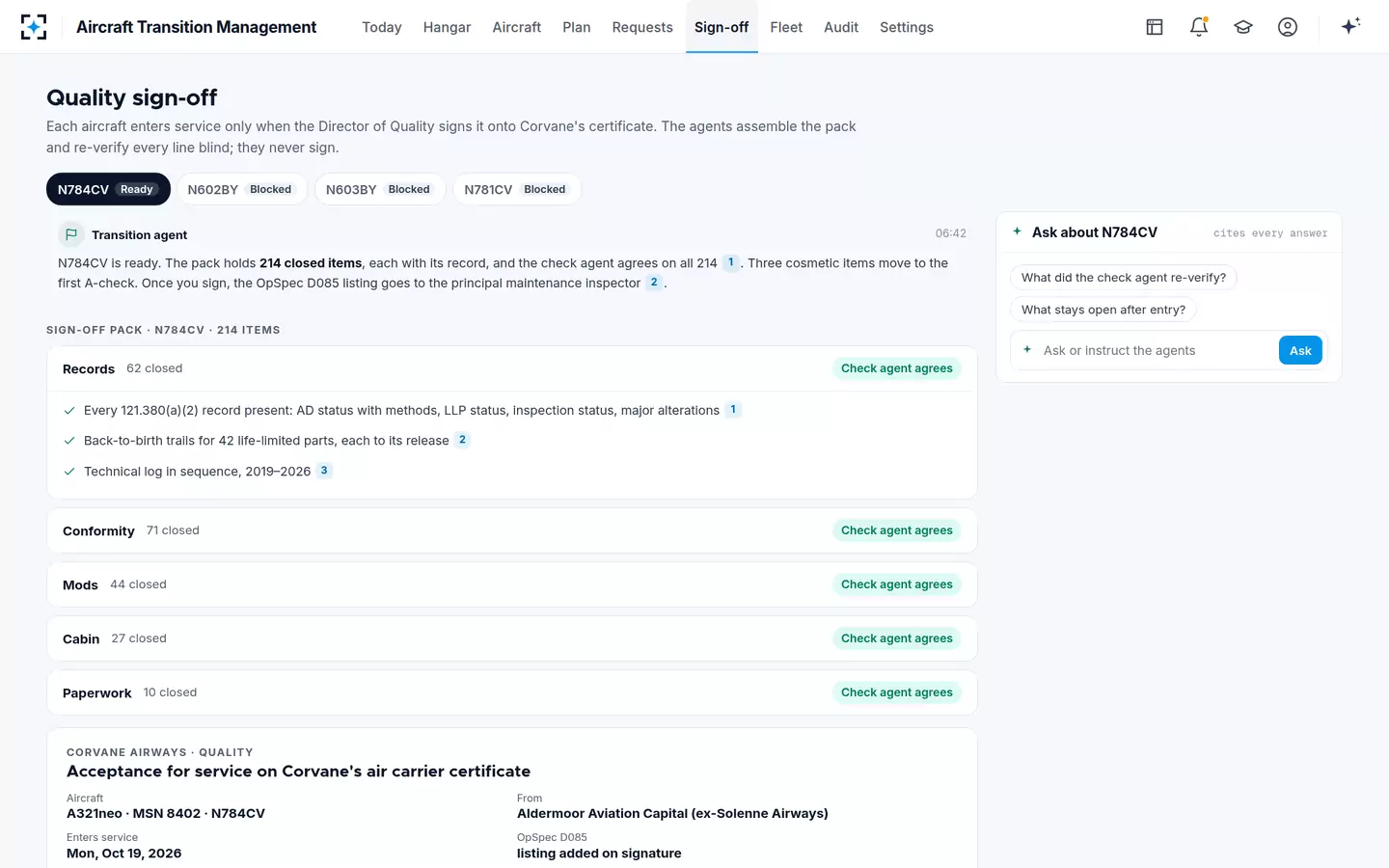

- 10Ready to sign
Only Quality signs an aircraft onto the certificate
Elena Varga · Director of QualityIn Bay 5, N784CV — an A321neo from Aldermoor Aviation Capital, ex-Solenne Airways — is ready. Its sign-off pack holds 214 closed items, each with its record: every 121.380(a)(2) record, back-to-birth trails for 42 life-limited parts, the technical log in sequence. The check agent agrees on all 214. Elena signs, or returns the pack with a reason; on her signature the OpSpec D085 listing goes to the principal maintenance inspector.
“The agents assemble the pack and re-verify every line blind; they never sign.”
