- Before
- Runs 12 OT negotiations at once and forwards every redline to counsel. “I can't tell counsel's markup from the vendor's by round three.”
- Now
- Opens each redline already checked against all 16 clauses, accepts the preferred wording herself and sends the round once the approvals are in.
One vendor redline, from 07:40 to round 3 sent
Lumina Utilities is buying RTUs and gateways for 38 substations from Halvorsen Grid Automation AS, with five years of remote support: contract LU-OT-2026-114, $4,860,000, to be signed by 30 Oct to hold the Q1 2027 substation outage windows. On Tue 13 Oct at 07:40, Halvorsen's round-2 redline arrives. Here is what happens next, screen by screen, in the working solution.
- 0107:40

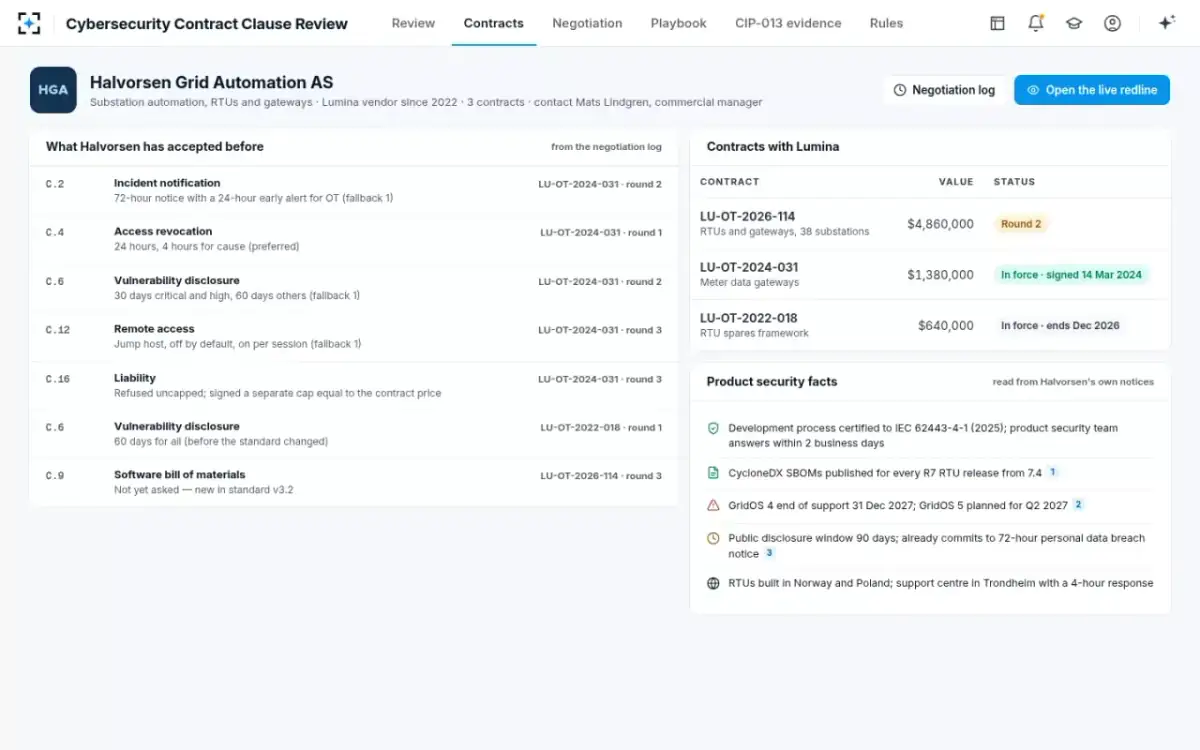

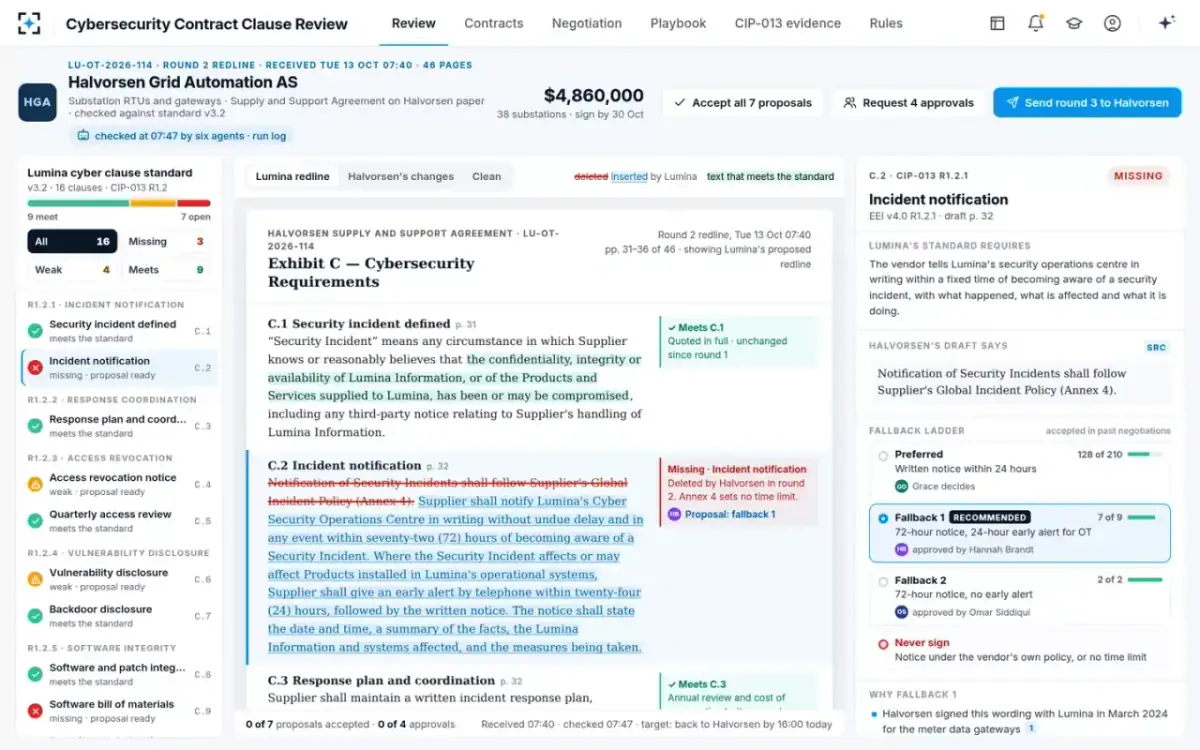

The contract opens as a document, not a ticket
Grace Okafor · Senior procurement officerHalvorsen sent back 46 pages on its own Supply and Support Agreement. Grace opens Exhibit C — Cybersecurity Requirements with Lumina's cyber clause standard v3.2 beside it: 16 clauses grouped by CIP-013 control, 9 meet, 4 weak, 3 missing. Halvorsen's changes are struck through, Lumina's redline is written in, and each clause has a margin note.
C.2 Incident notification — “Missing · Deleted by Halvorsen in round 2. Annex 4 sets no time limit.”
- 0207:40–07:47

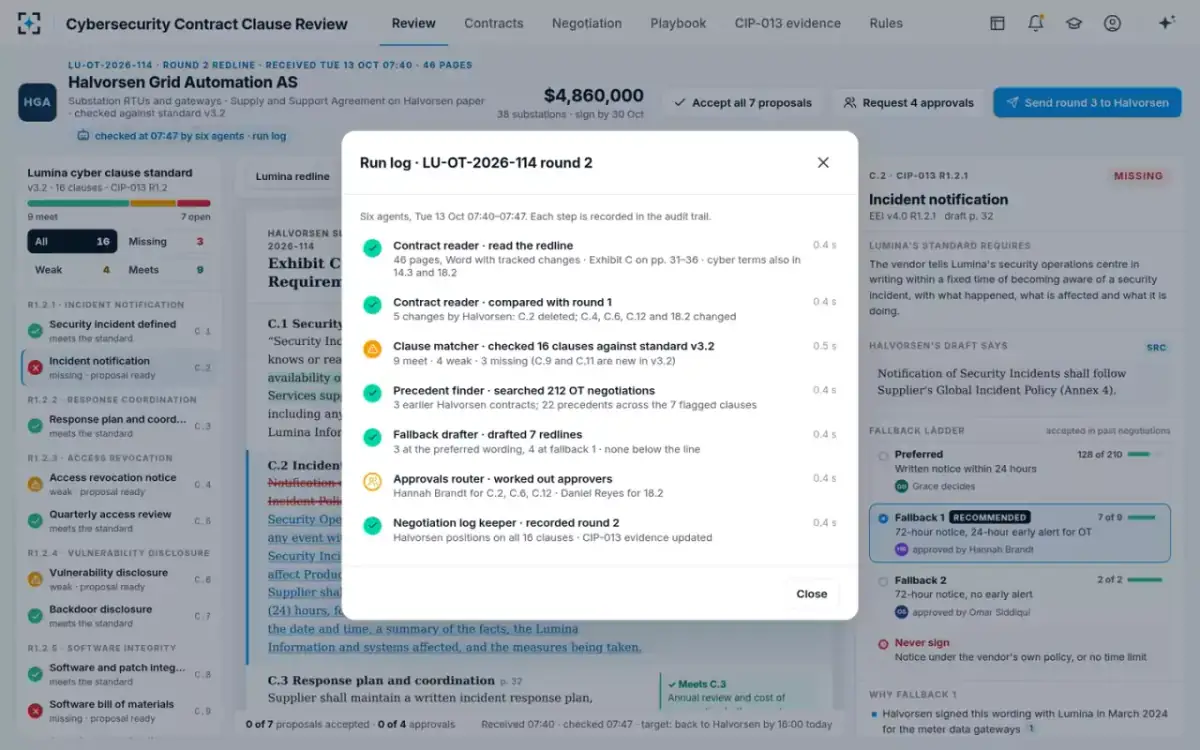

Every clause checked, every change found
Six agentsThe contract reader reads the redline — Word with tracked changes, Exhibit C on pp. 31–36, cyber terms also in clauses 14.3 and 18.2 — and compares it with round 1: C.2 deleted; C.4, C.6, C.12 and 18.2 changed. The clause matcher checks the 16 clauses against standard v3.2. The precedent finder searches 212 OT negotiations, the fallback drafter writes 7 redlines, and the approvals router works out who must sign off.
“Fallback drafter · drafted 7 redlines — 3 at the preferred wording, 4 at fallback 1 · none below the line”
- 03The deleted clause

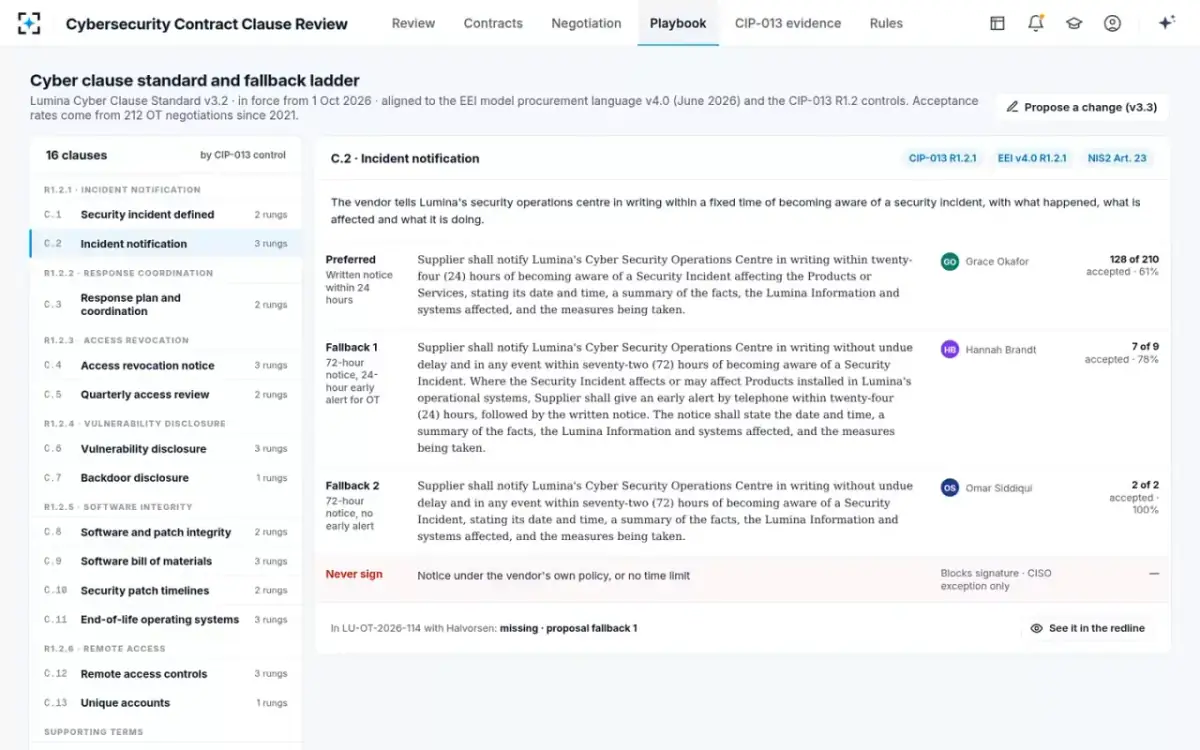

72 hours, with a 24-hour early alert for OT

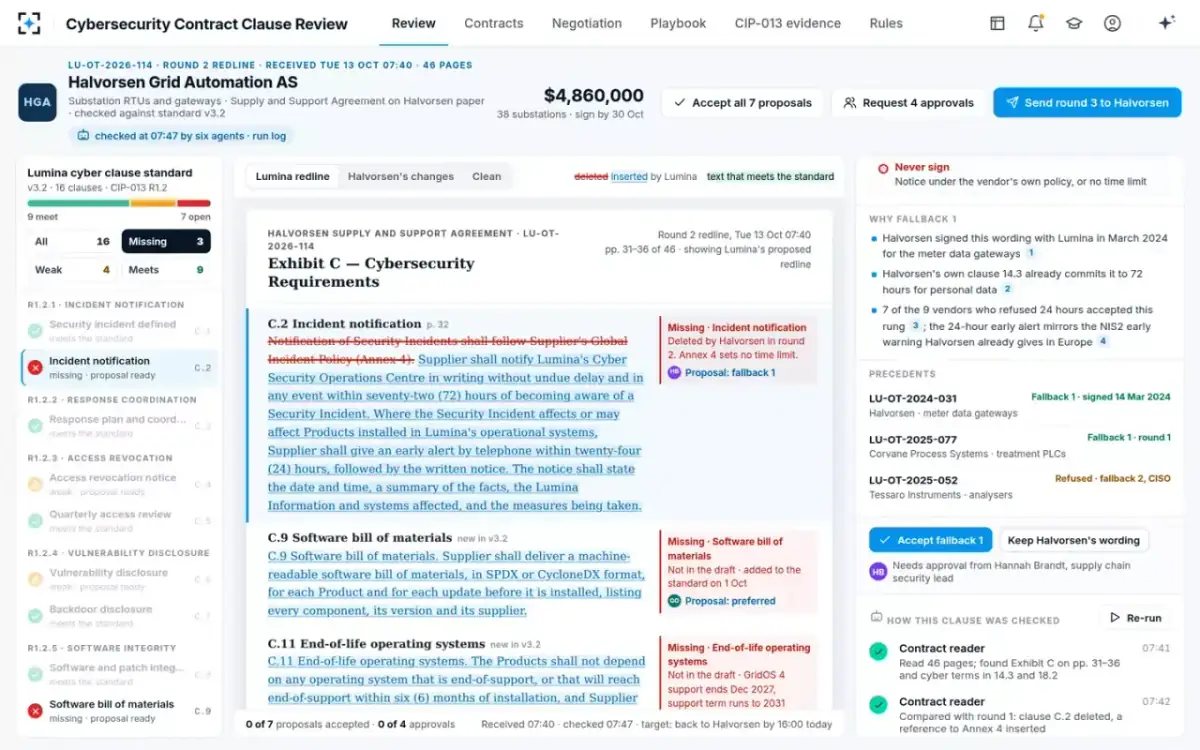

Fallback drafter and Precedent finderHalvorsen replaced the 24-hour notice with “Notification of Security Incidents shall follow Supplier's Global Incident Policy (Annex 4)”. The ladder shows the preferred 24-hour wording, accepted in 128 of 210 negotiations, and recommends fallback 1: written notice within 72 hours, an early alert by telephone within 24 hours when products in Lumina's operational systems may be affected. Halvorsen signed that wording in March 2024 for the meter data gateways, and 7 of the 9 vendors who refused 24 hours accepted it.
Never sign: “Notice under the vendor's own policy, or no time limit” — blocks signature, CISO exception only.
- 04Remote access

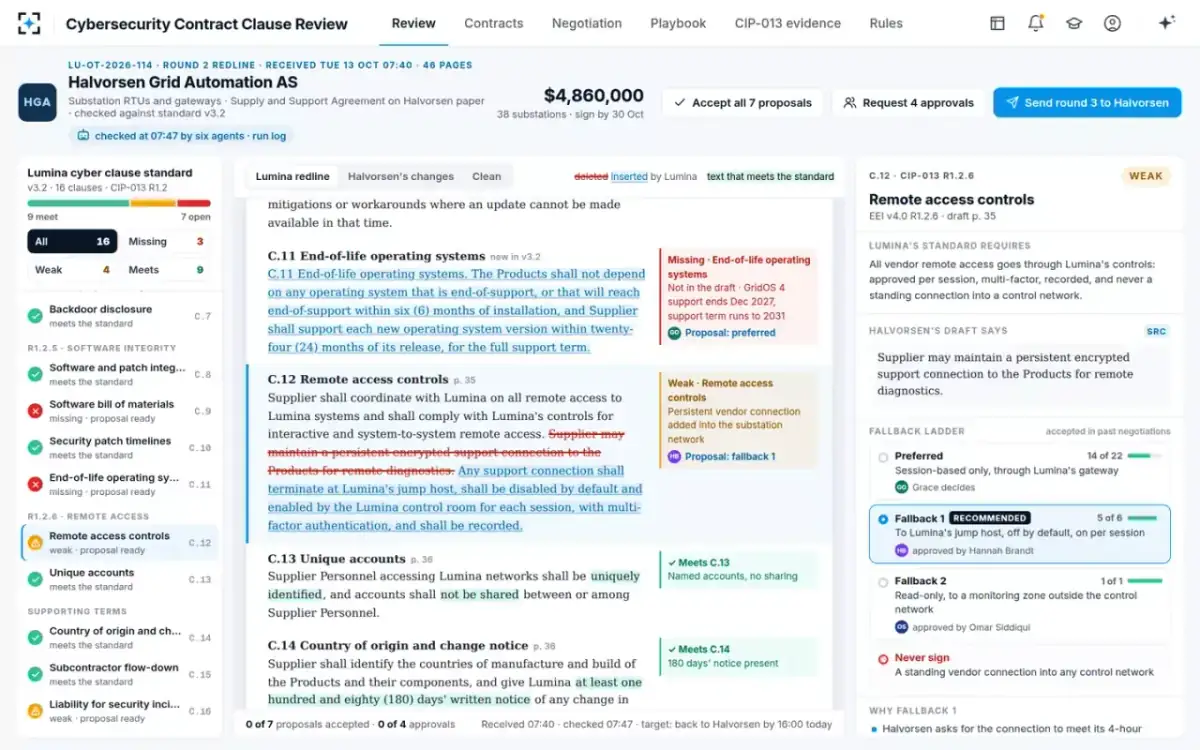

No standing vendor tunnel into a substation
Clause matcherIn C.12 Halvorsen added one sentence: “Supplier may maintain a persistent encrypted support connection to the Products for remote diagnostics.” The matcher marks it weak at 0.97 confidence. Fallback 1 deletes the sentence: any support connection ends at Lumina's jump host, is off by default, is switched on by the Lumina control room for each session, with multi-factor authentication, and is recorded. 5 of 6 automation vendors accepted it.
Halvorsen asks for the connection to meet its 4-hour response time; a jump host switched on by the control room meets that time.
- 05Outside the exhibit
A $312,000 cap against a $4.83M average breach

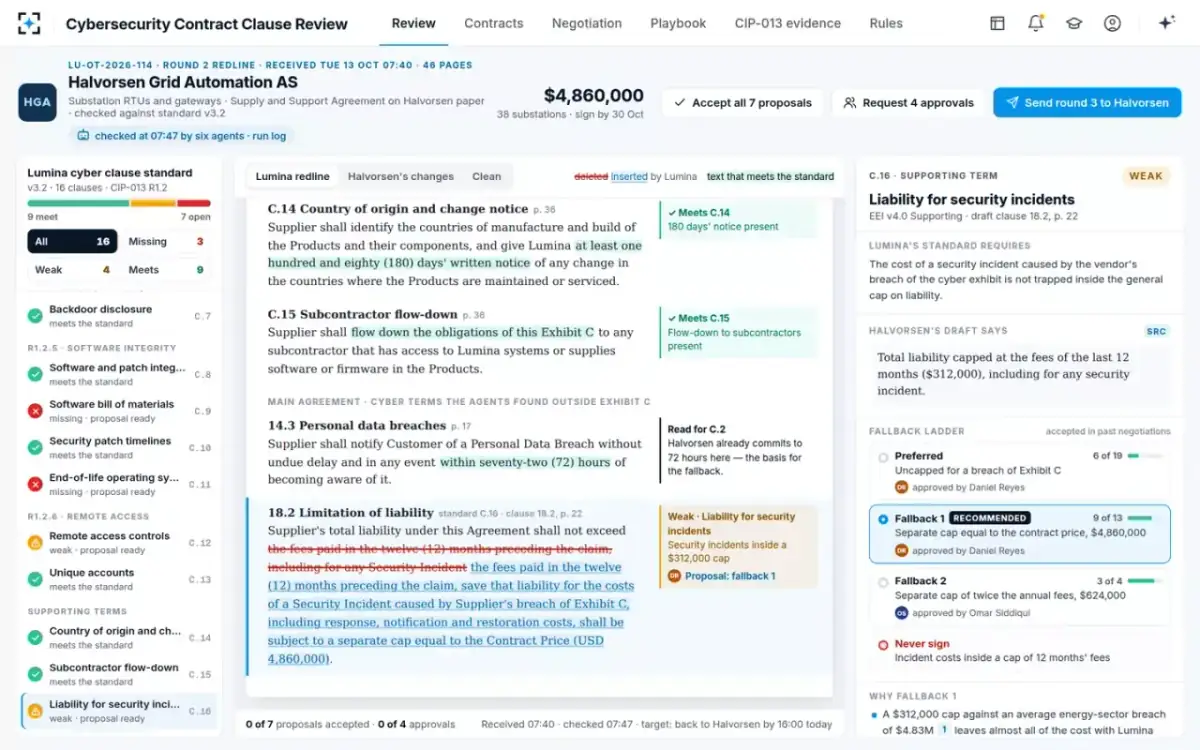

Contract readerThe reader also finds clause 18.2 in the main agreement: total liability capped at the fees of the last 12 months, $312,000, including for any security incident. Halvorsen refused an uncapped clause in 2024 but signed a separate cap equal to the contract price, so the drafter proposes fallback 1: security-incident costs, including response, notification and restoration, under their own cap of $4,860,000.
“Liability is counsel's call at every rung: Daniel Reyes approves.”
- 0610:02–10:19
Seven proposals accepted, four approvals in

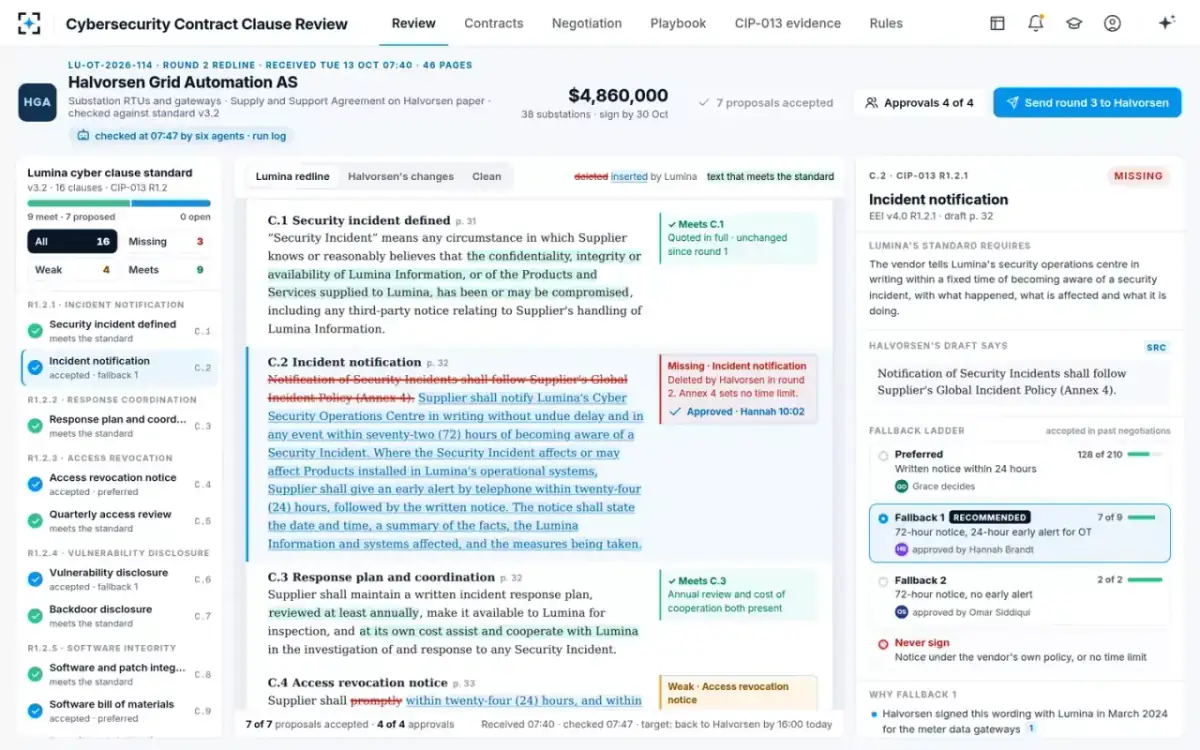

Grace Okafor, Hannah Brandt, Daniel ReyesGrace accepts the seven proposals — 3 at the preferred wording, which are hers to accept, and 4 at fallback 1. The approvals router asks the right people: Hannah Brandt, supply chain security, approves the fallbacks for C.2, C.6 and C.12 at 10:02, 10:09 and 10:15; Daniel Reyes, contracts counsel, approves the 18.2 liability cap at 10:19. Send stays locked until every approval is in.
C.2 · “Approved · Hannah 10:02”

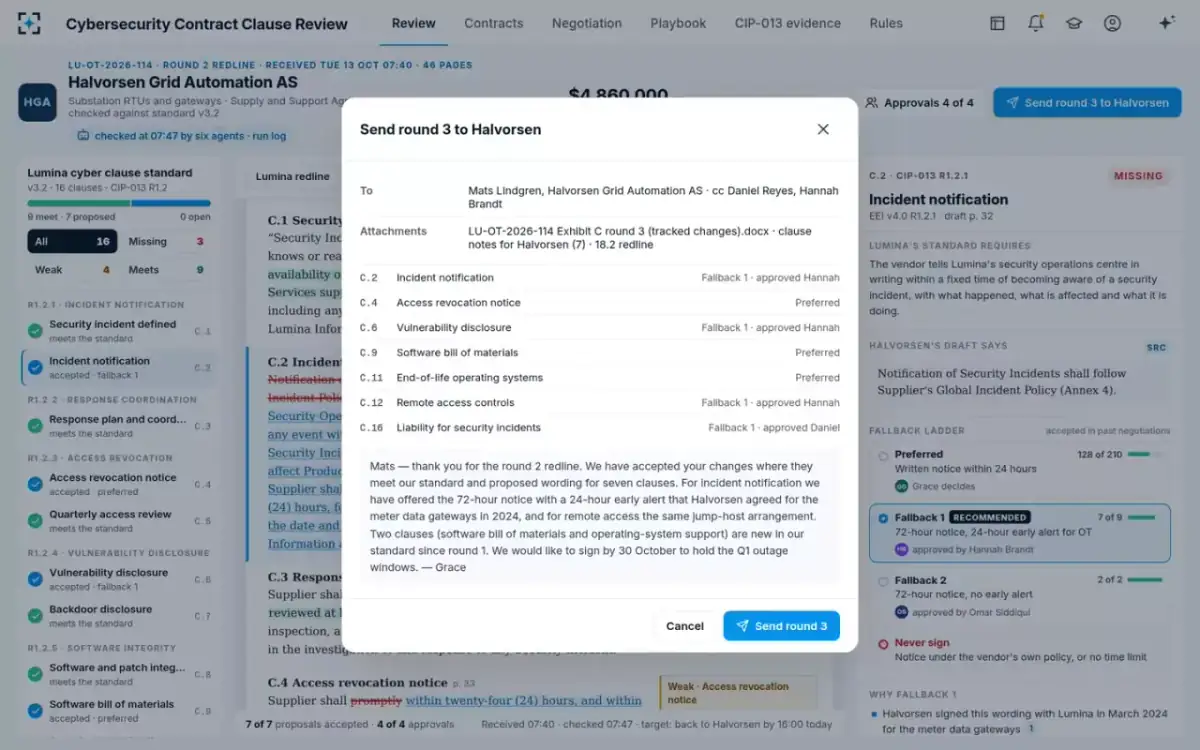

- 0710:24
Round 3 goes back the same morning
Grace Okafor · Senior procurement officerGrace sends round 3 to Mats Lindgren at Halvorsen, copying Daniel and Hannah, with Exhibit C in tracked changes, clause notes for the seven clauses and the 18.2 redline. Her cover note offers the 72-hour notice with the 24-hour early alert Halvorsen agreed in 2024, the same jump-host arrangement, and explains that the software bill of materials and operating-system clauses are new in Lumina's standard since round 1.
“Round 3 sent to Mats Lindgren at 10:24 · same day as the redline · logged as CIP-013 evidence”

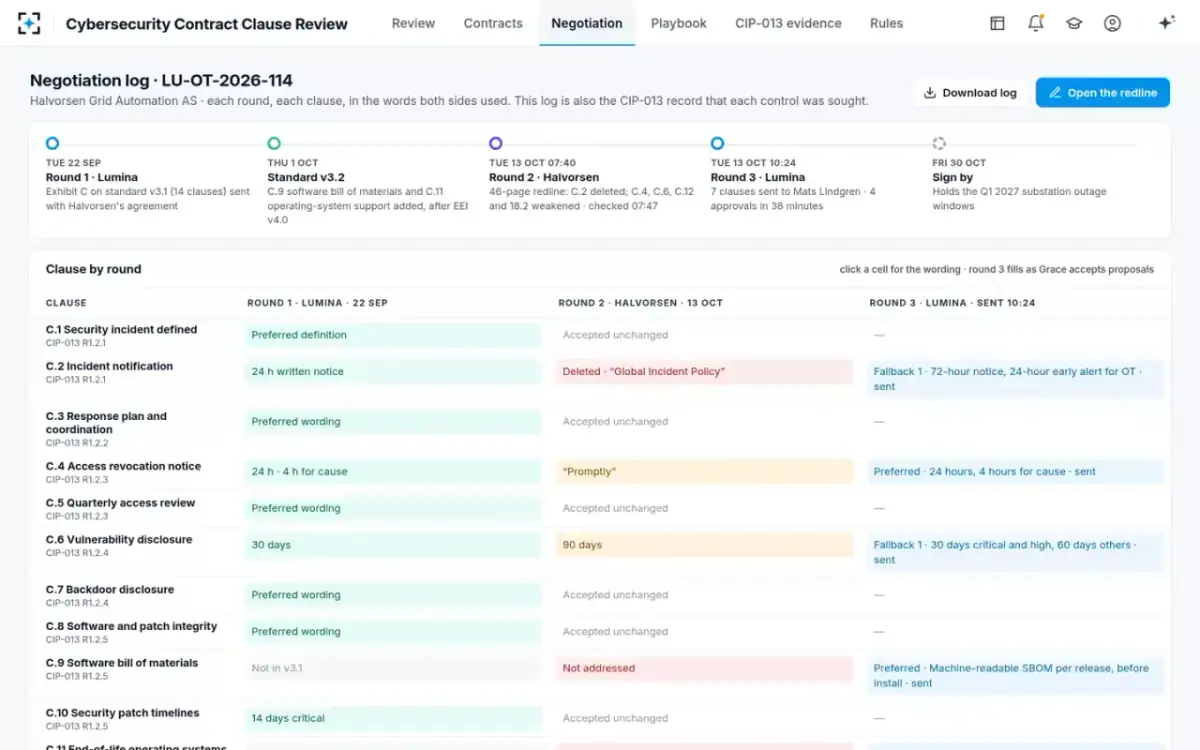

- 08Logged
Each round, each clause, in both sides' words
Negotiation log keeperThe negotiation log shows the timeline — round 1 on standard v3.1 on 22 Sep, standard v3.2 on 1 Oct, Halvorsen's round 2 on 13 Oct, round 3 sent at 10:24, sign by 30 Oct — and a clause-by-round grid: C.2 from “24 h written notice” to “Deleted · Global Incident Policy” to fallback 1, sent. Round 3 went out with 4 approvals in 38 minutes.
“This log is also the CIP-013 record that each control was sought.”
- 09For the auditor
CIP-013 evidence, control by control

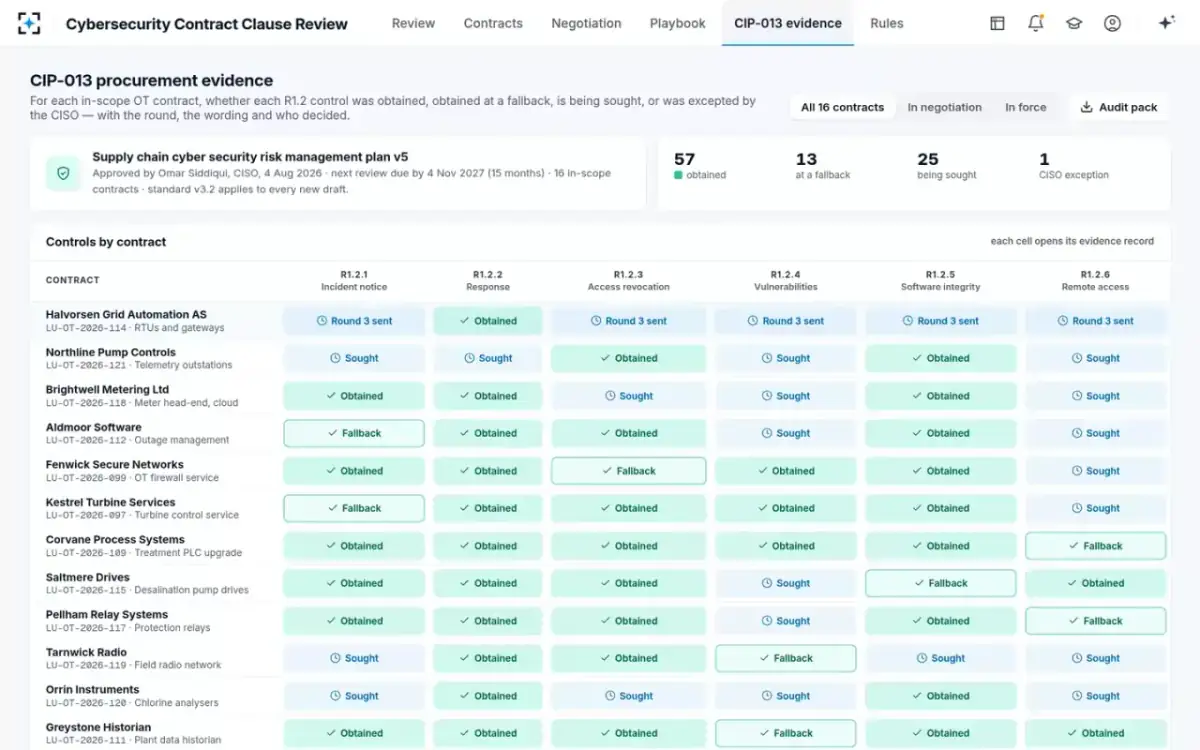

Hannah Brandt · Supply chain security leadAcross 16 in-scope contracts, the six R1.2 controls are obtained in 57 places, at an approved fallback in 13, being sought in 25, and excepted once — Tessaro's remote access, where the CISO had remote access disabled at the plant instead. The Halvorsen row now reads “Round 3 sent” on five controls, each cell opening its evidence record with the round, the wording and who decided.
Supply chain cyber security risk management plan v5 · approved by Omar Siddiqui, CISO, 4 Aug 2026

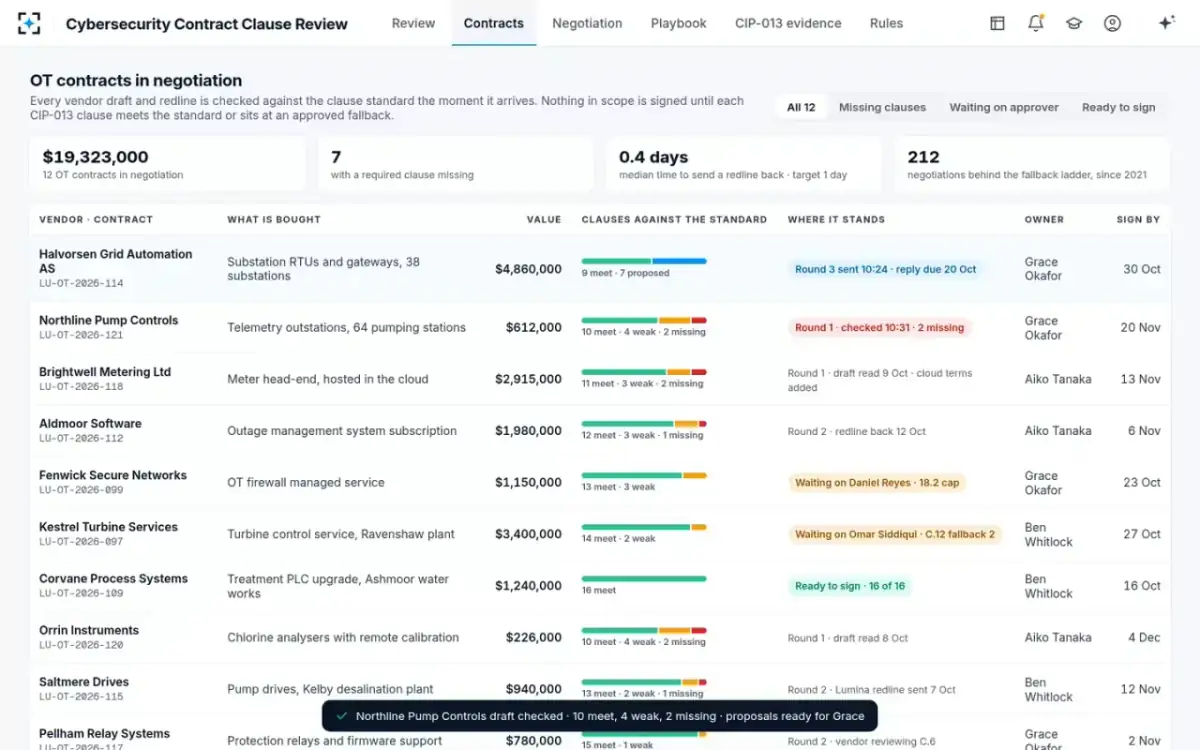

- 1010:31
The next draft is already checked
Clause matcherTwelve OT contracts worth $19,323,000 are in negotiation, seven with a required clause missing. While the approvals were coming in, Northline Pump Controls' draft for 64 pumping-station telemetry outstations arrived at 10:12; by 10:31 it is checked — 10 meet, 4 weak, 2 missing — with proposals ready for Grace.
“0.4 days · median time to send a redline back · target 1 day”
