One ETF launch: a rejected basket file at 6:42 p.m., first NAV held by 9:08 a.m.
Quillfield Short Duration Muni ETF (QSDM) is an actively managed, transparent ETF in Quillfield ETF Trust, relying on Rule 6c-11. First NAV is set for Tuesday, March 16, 2027, with $25.0 million of seed. On the evening of February 22 the custodian rejects its basket test file. Here is what happens next, screen by screen, in the working solution.
- 01Tuesday, 9:05 a.m.

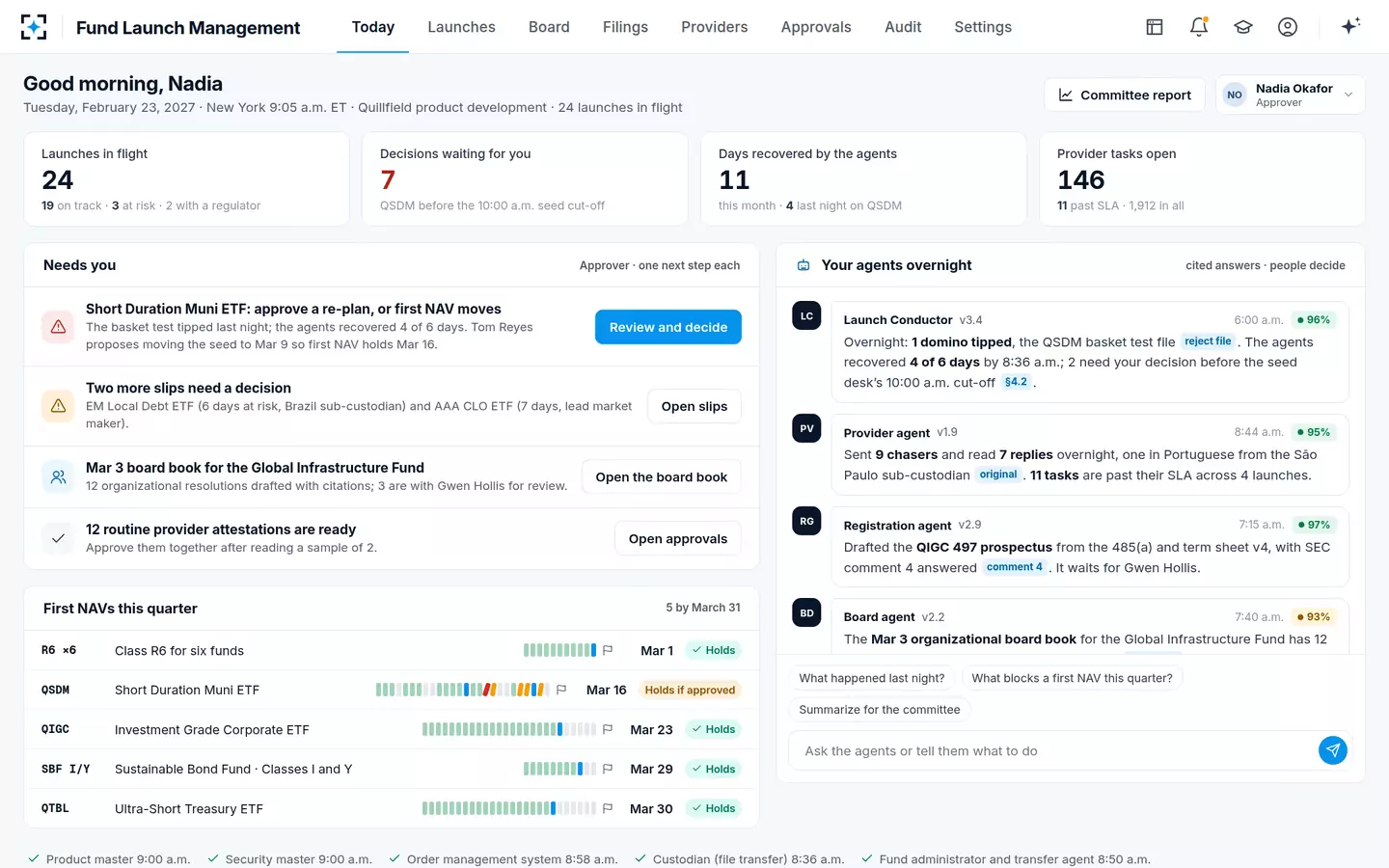

Four numbers, what needs her, and the agents' night
Nadia Okafor · Head of Product DevelopmentNadia's Today screen shows 24 launches in flight — 19 on track, 3 at risk, 2 with a regulator — 7 decisions waiting for her, 11 days recovered by the agents this month and 146 provider tasks open, 11 past SLA. First under “Needs you”: the Short Duration Muni ETF, approve a re-plan or first NAV moves. Beside it, each agent's overnight work in plain words, with its version, its confidence and a link to its source.
Launch Conductor: “Overnight: 1 domino tipped, the QSDM basket test file. The agents recovered 4 of 6 days by 8:36 a.m.; 2 need your decision before the seed desk's 10:00 a.m. cut-off.”
- 02Last night, 6:51 p.m.
A domino tips, and shows what it knocks over

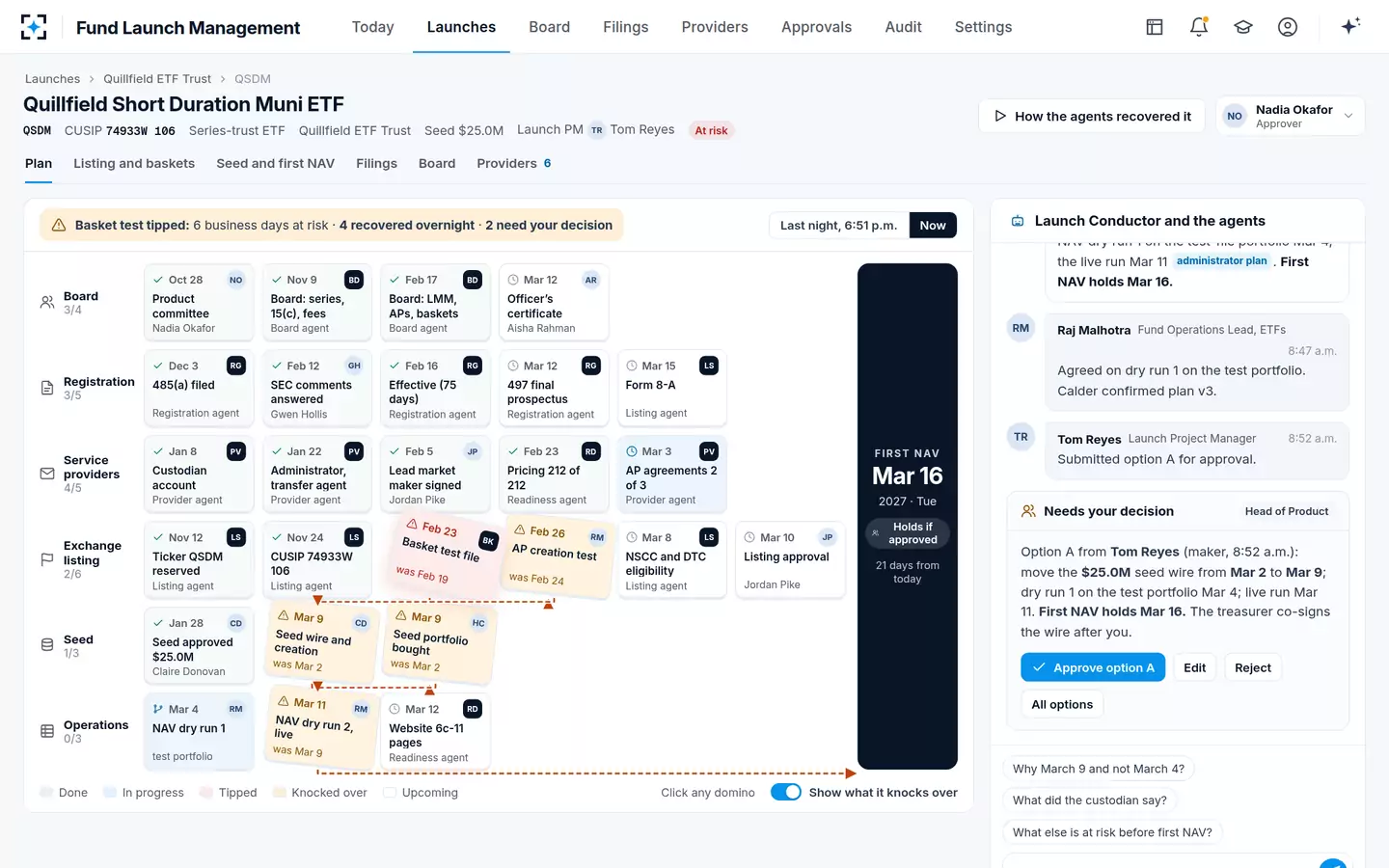

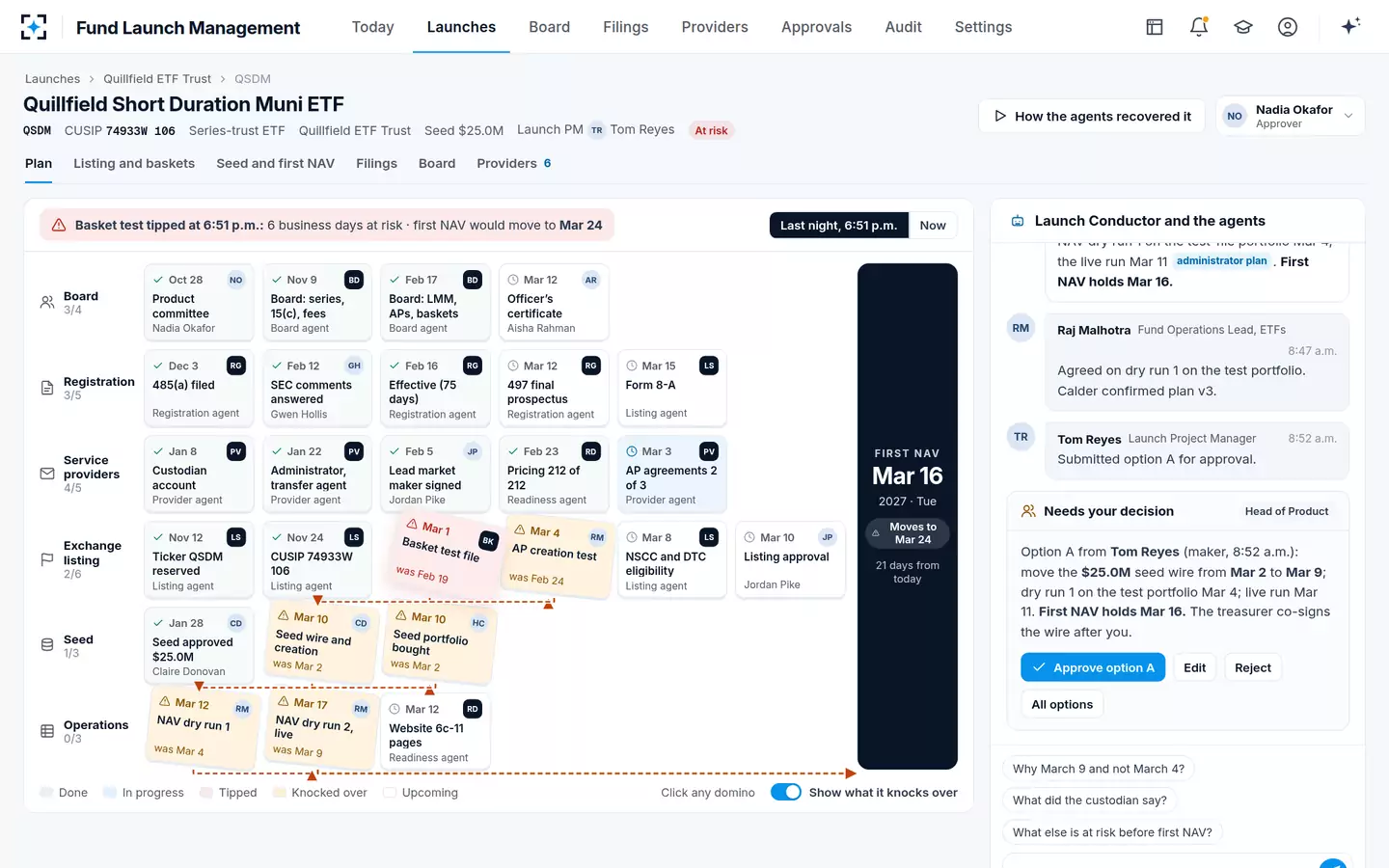

Launch ConductorThe launch is one row of dominoes in six bands — Board, Registration, Service providers, Exchange listing, Seed, Operations — running to a fixed First NAV. Each names its owner, an agent or a person, and its date. When the basket test file failed, the Conductor tipped it and leaned every domino it knocks over with its new date: the AP creation test from Feb 24 to Mar 4, the seed wire and seed portfolio from Mar 2 to Mar 10, both NAV dry runs, and first NAV from Mar 16 to Mar 24.
“Basket test tipped at 6:51 p.m.: 6 business days at risk · first NAV would move to Mar 24.”

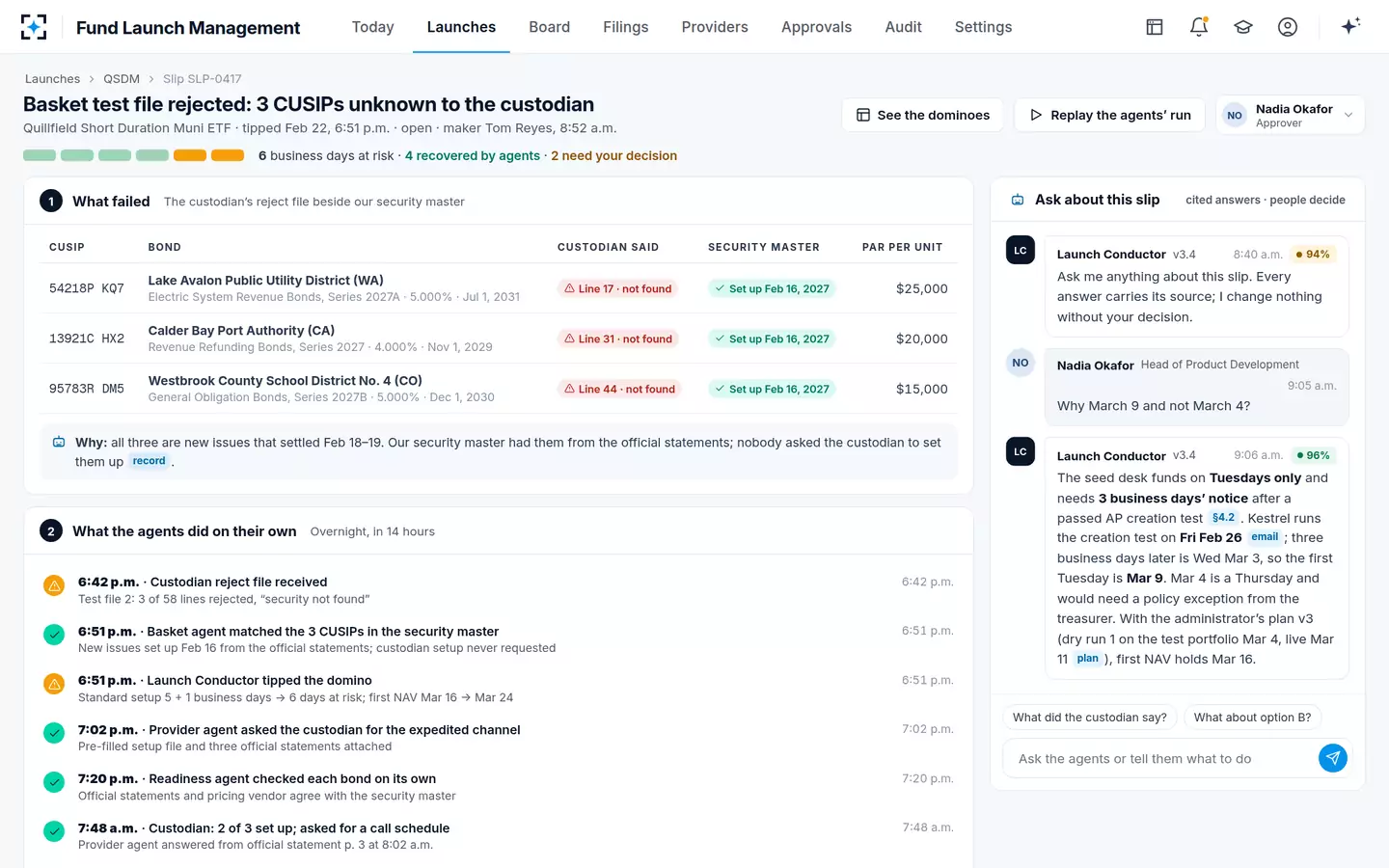

- 03What failed

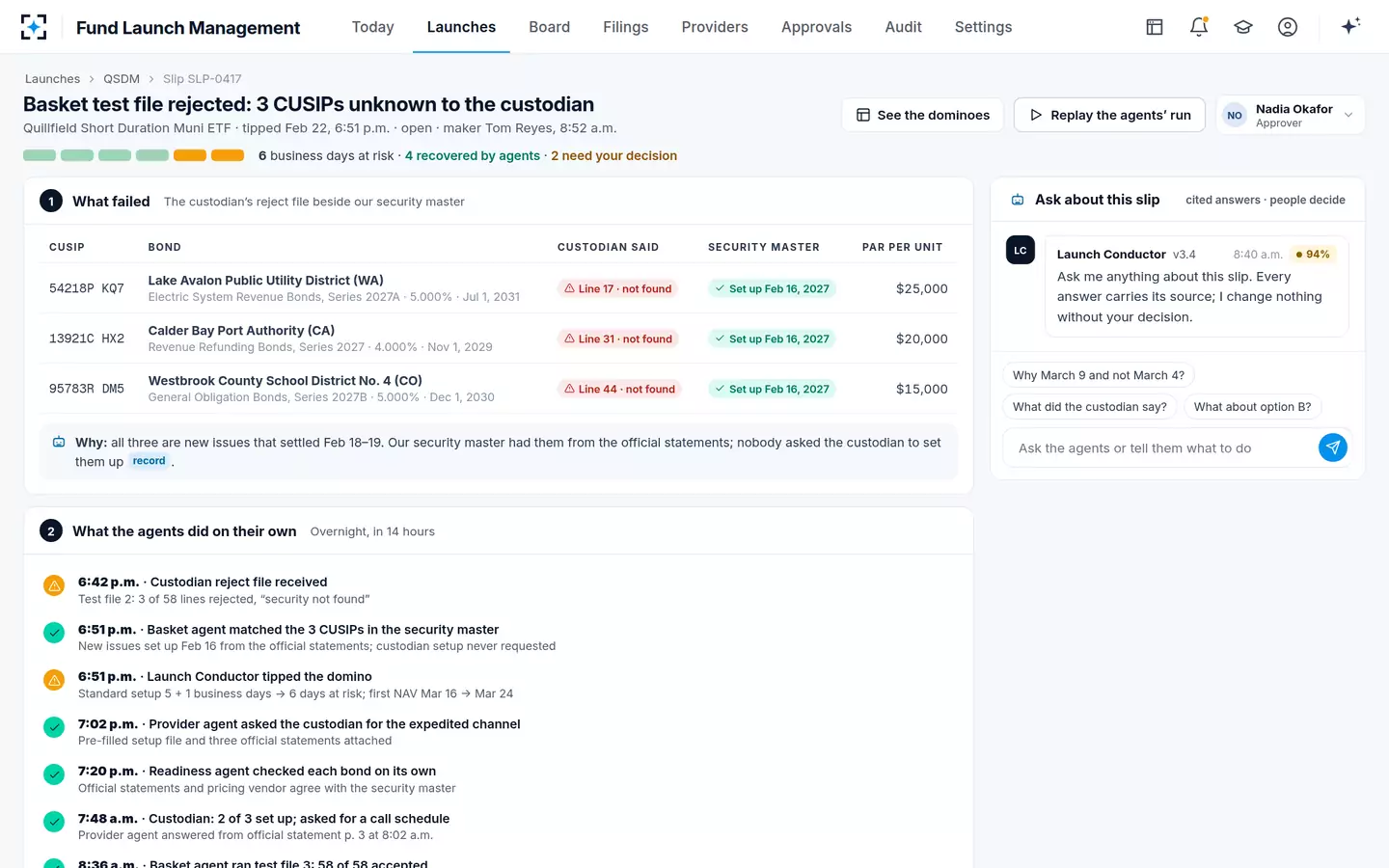

The custodian's reject file beside the security master
Basket agentThe custodian rejected 3 of 58 lines in test file 2, “security not found”: Lake Avalon Public Utility District 2027A, Calder Bay Port Authority 2027 and Westbrook County School District No. 4 2027B. The Basket agent found all three in Quillfield's security master, set up on Feb 16 from the official statements. They are new issues that settled Feb 18–19, and nobody had asked the custodian to set them up.
The Basket agent never changes the basket's composition; cash in lieu needs the portfolio manager.
- 04Overnight, in 14 hours

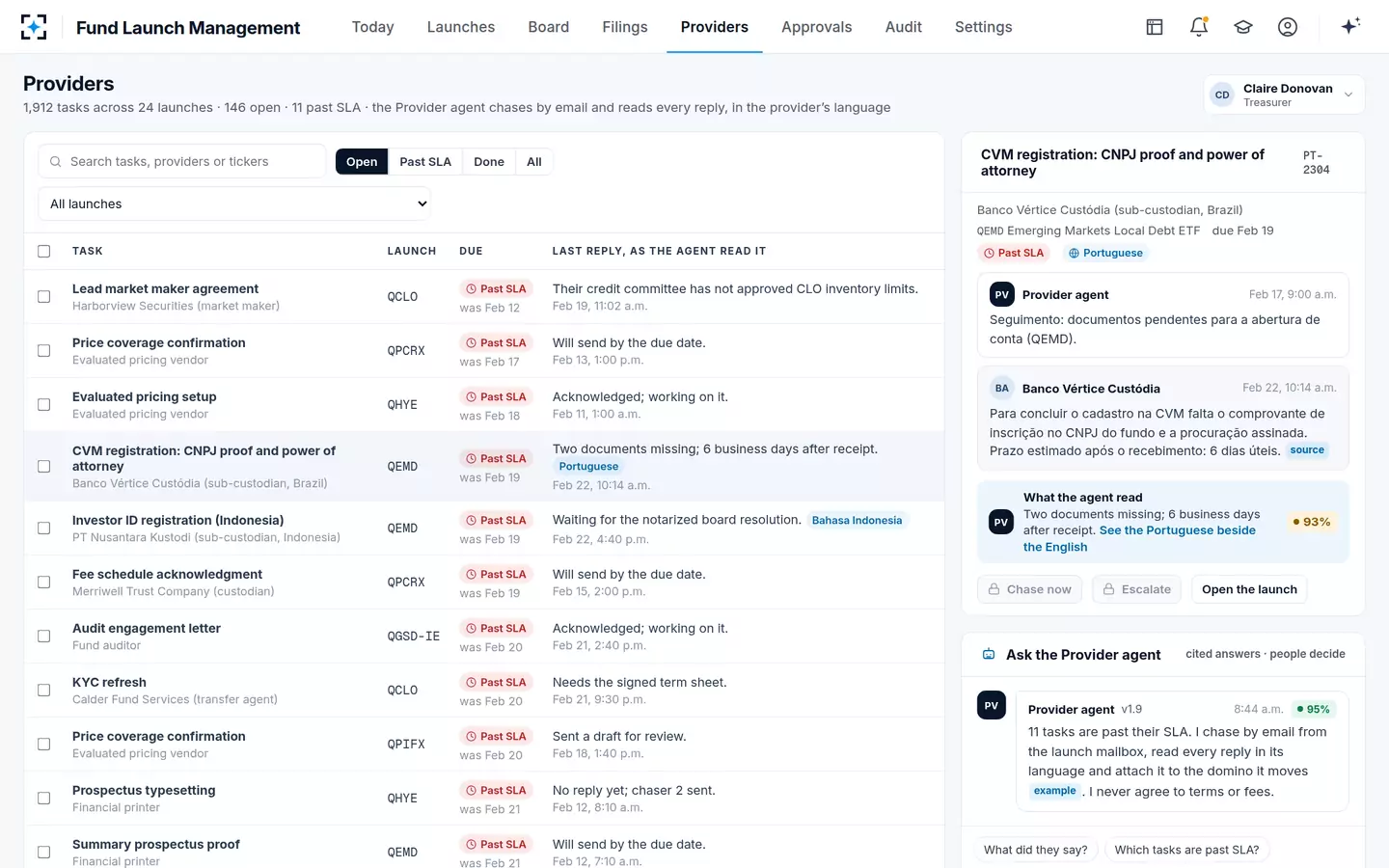

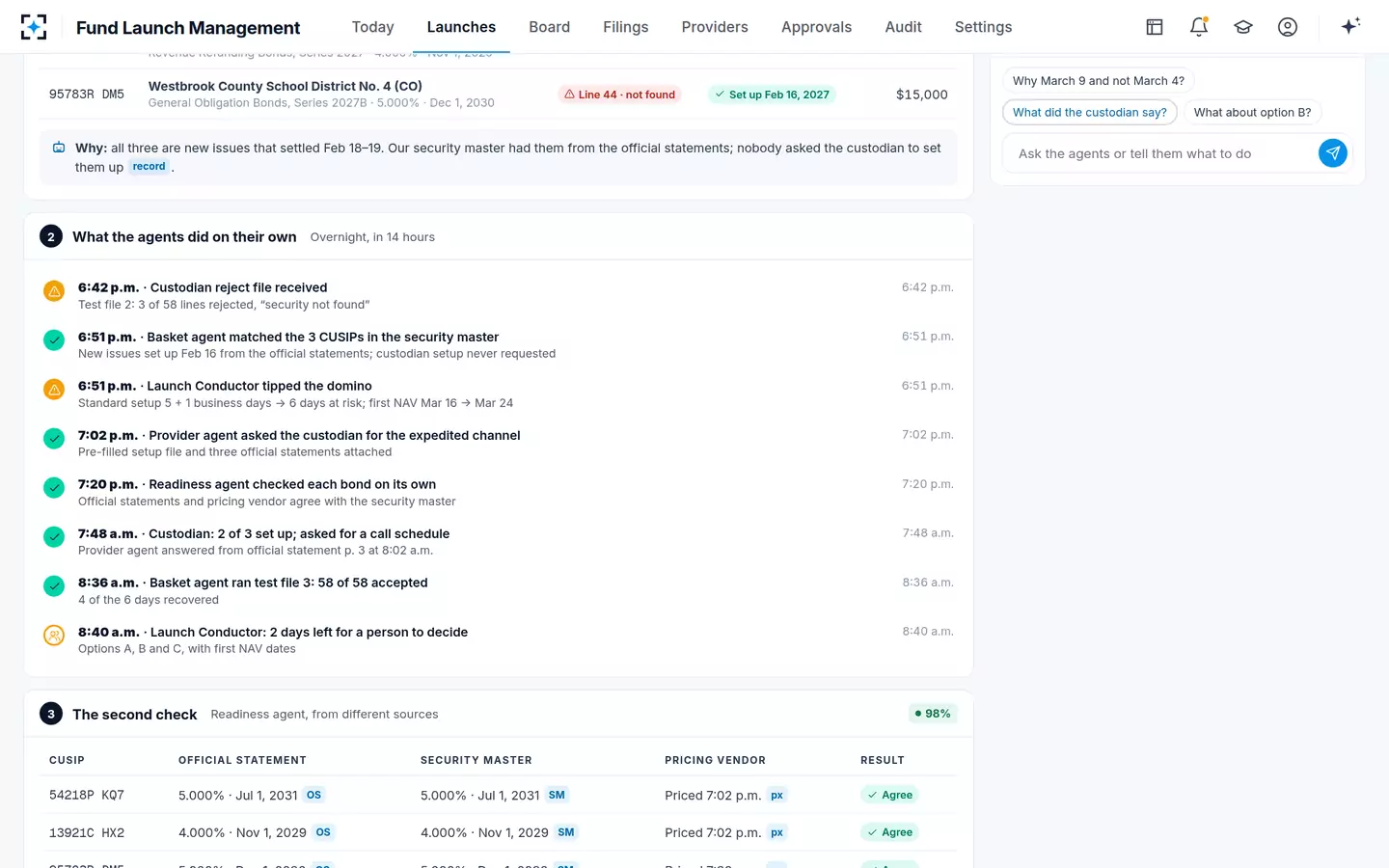

Three agents recover four of the six days
Provider agent · Readiness agent · Basket agentAt 7:02 p.m. the Provider agent emailed the custodian's ETF services team a pre-filled setup file with the three official statements, asking for the expedited channel. At 7:48 a.m. the custodian had set up two and asked for a call schedule; the agent answered from official statement page 3, and the third was set up by 8:31. At 8:36 a.m. the Basket agent ran test file 3: 58 of 58 accepted.
Every step of the agents' run is on the slip, with its time and its source — and can be replayed.
- 058:40 a.m.
A second agent checks the fix; the Conductor lays out the options

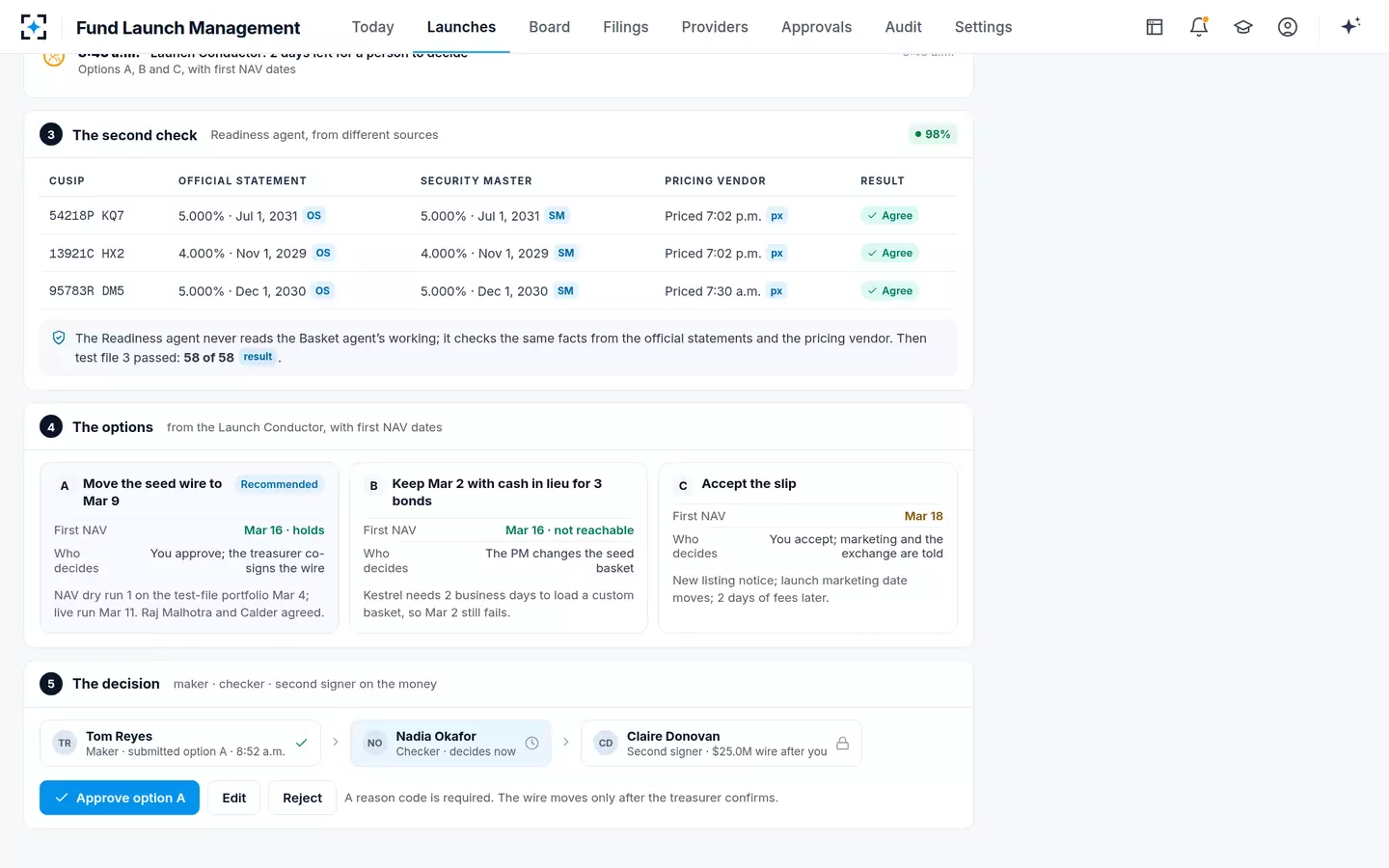

Readiness agent · Launch ConductorAt 7:20 p.m. the night before, the Readiness agent had checked each bond on its own against the official statements and the evaluated pricing vendor: all three agree with the security master. With test file 3 passed, 2 business days are still at risk. Option A, recommended: move the seed wire from Mar 2 to Mar 9 and run NAV dry run 1 on the test-file portfolio on Mar 4, the live run on Mar 11 — first NAV holds Mar 16. Option B, cash in lieu for the three bonds, gains nothing. Option C accepts the slip to Mar 18.
“The Readiness agent never reads the Basket agent's working; it checks the same facts from the official statements and the pricing vendor.”
- 068:52 a.m.
The launch PM proposes; the decision lands beside the dominoes
Tom Reyes · Launch Project ManagerRaj Malhotra, fund operations lead, agreed in the thread to run dry run 1 on the test portfolio, and the administrator confirmed its plan v3. Tom submitted option A as the maker. When Nadia opens “Review and decide” she sees the dominoes as they stand this morning — 4 recovered overnight, 2 need her decision — and the decision card from Tom beside them: move the $25.0M seed wire to Mar 9; first NAV holds Mar 16; the treasurer co-signs the wire after her.
Tom cannot approve his own re-plan: “You submitted this re-plan (maker). The Head of Product approves it.”
- 07Just after 9:00 a.m.
She asks why March 9, and gets a cited answer
Nadia Okafor · Head of Product DevelopmentNadia asks the agents in plain words: “Why March 9 and not March 4?” The Launch Conductor answers from the treasury seed capital policy and the authorized participant's email: the seed desk funds on Tuesdays only and needs 3 business days' notice after a passed AP creation test; Kestrel Markets runs the creation test on Friday, Feb 26; three business days later is Wednesday, Mar 3, so the first Tuesday is Mar 9. Mar 4 is a Thursday and would need a policy exception from the treasurer.
“Every answer carries its source; I change nothing without your decision.” — Launch Conductor
- 089:07 a.m.
She approves with a reason code and signs

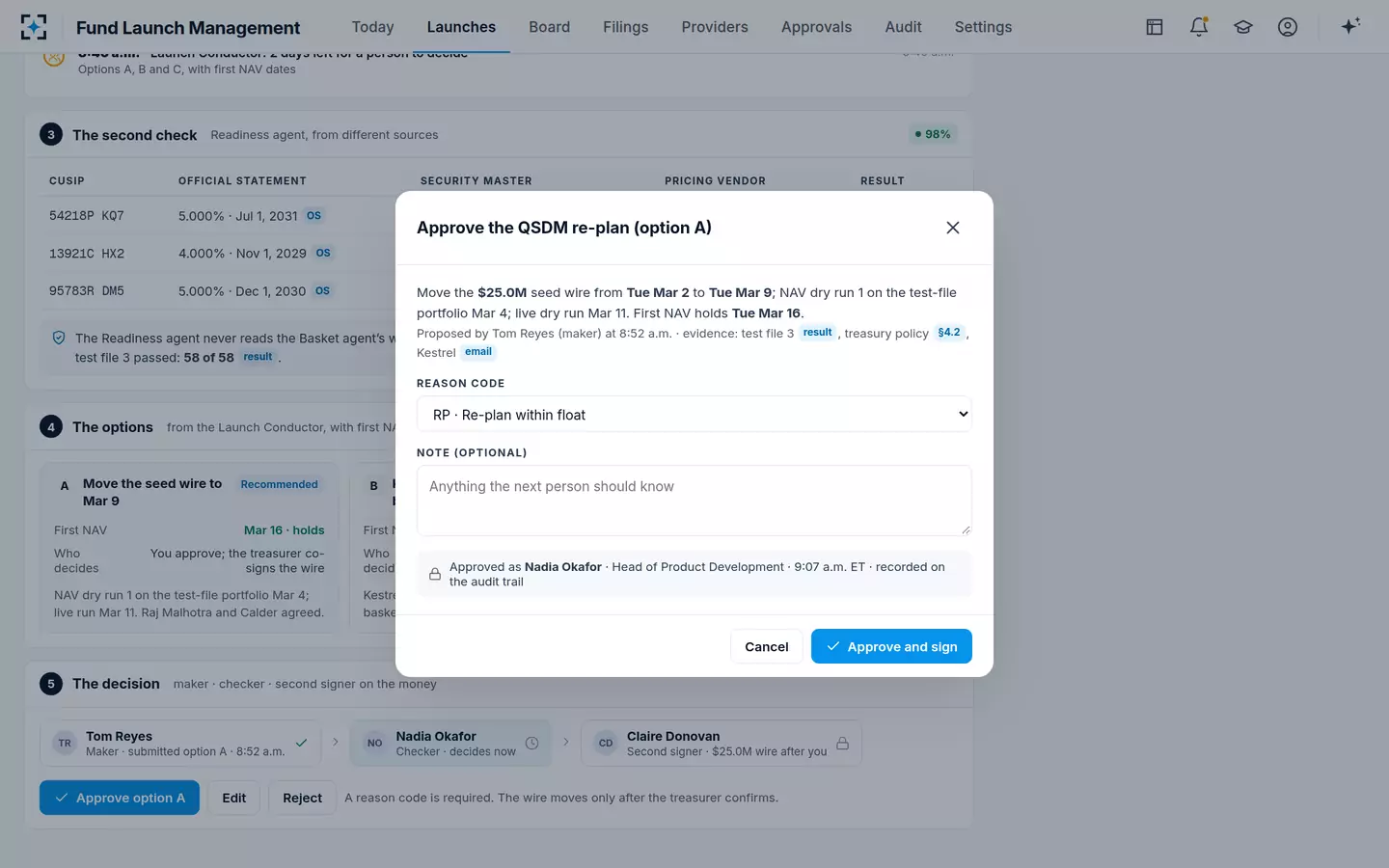

Nadia Okafor · Head of Product DevelopmentThe approval shows what she is signing — move the $25.0M seed wire from Tue Mar 2 to Tue Mar 9, dry runs Mar 4 and Mar 11, first NAV holds Tue Mar 16 — who proposed it and the evidence: test file 3, treasury policy §4.2 and Kestrel's email. She picks reason code RP · Re-plan within float and approves and signs. The dominoes stand up again.

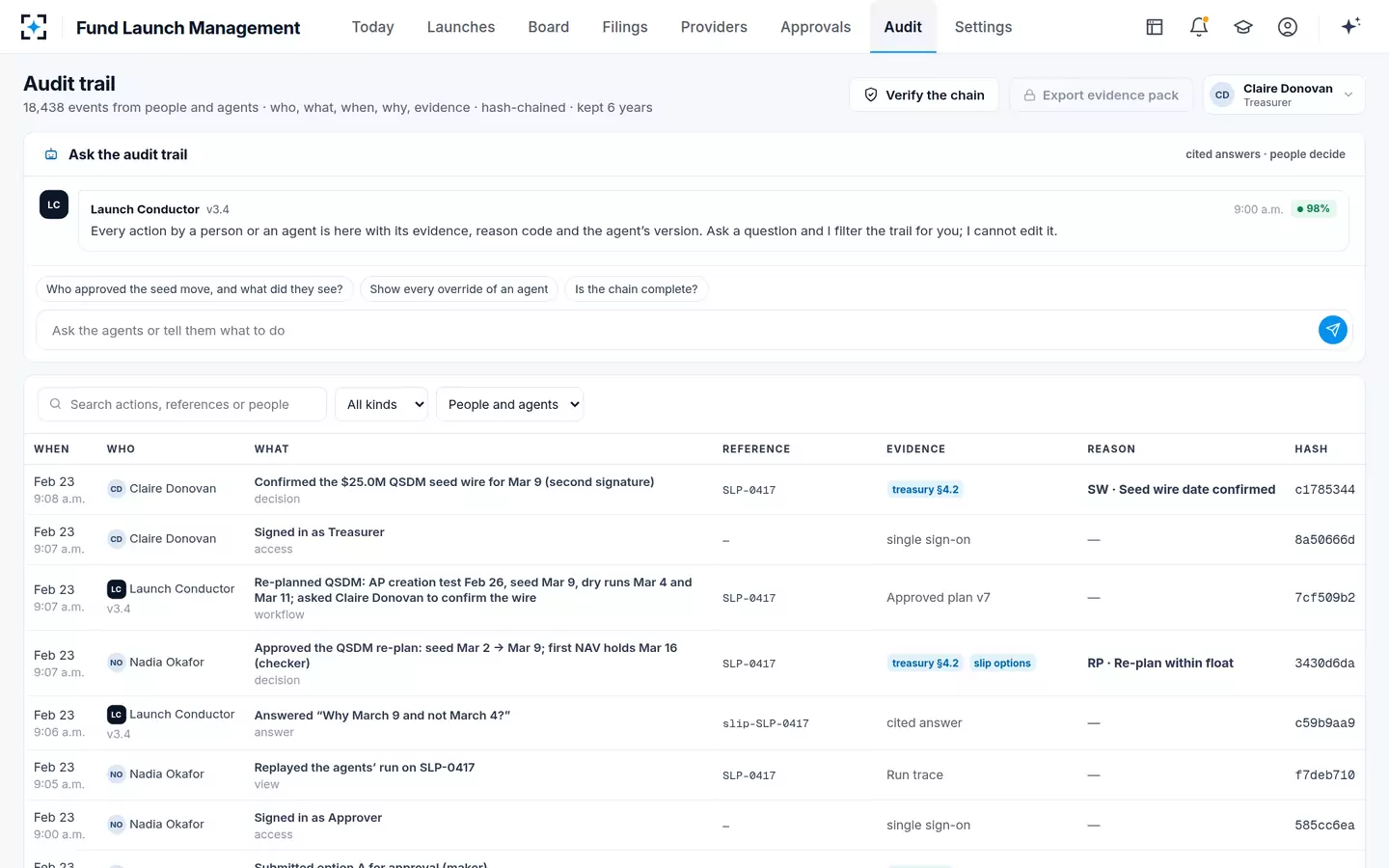

“Approved as Nadia Okafor · Head of Product Development · 9:07 a.m. ET · recorded on the audit trail.”
- 099:08 a.m.

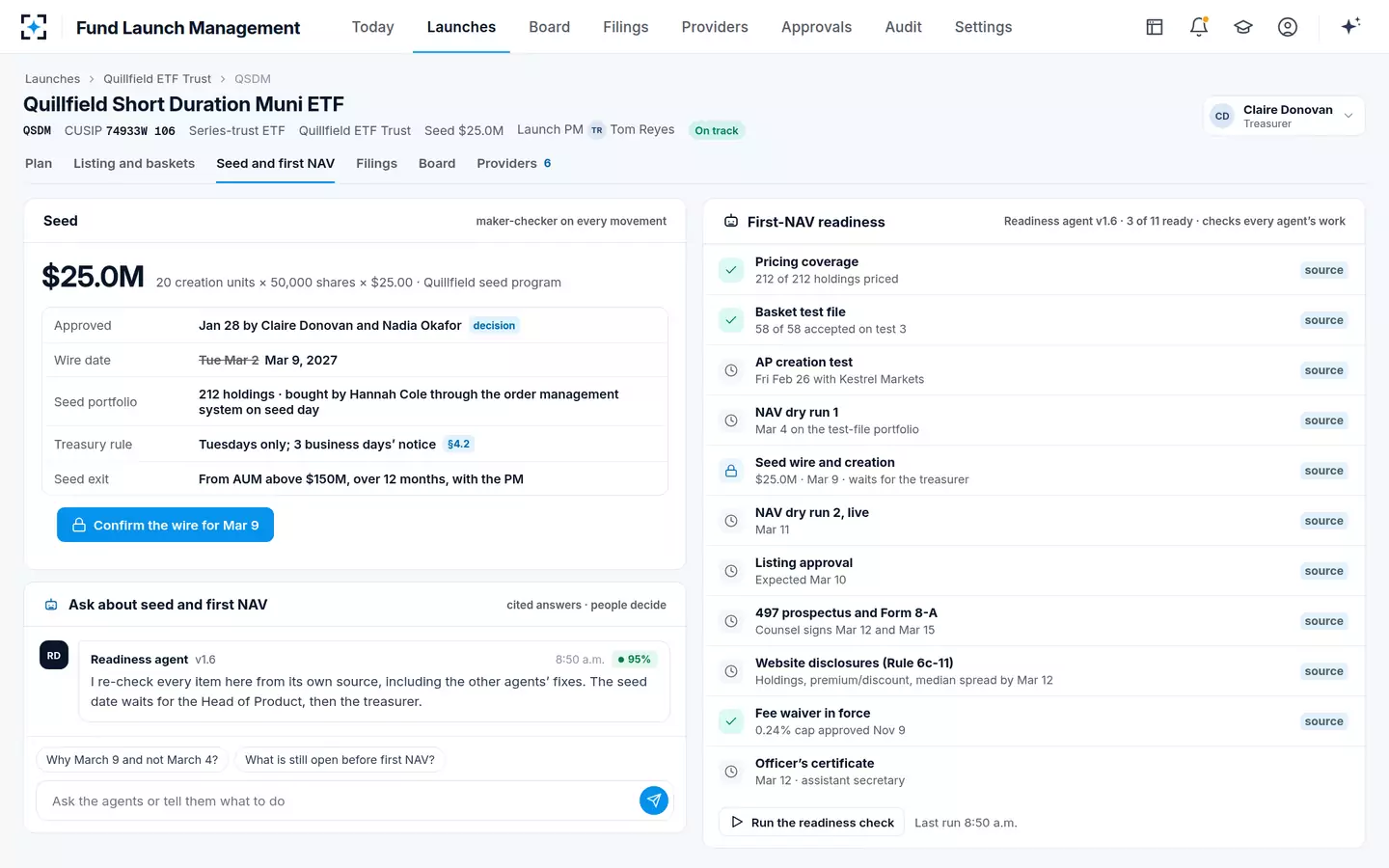

The treasurer co-signs the seed capital wire
Claire Donovan · Fund TreasurerSeed is money, so it takes two signatures. Claire's screen shows the $25.0M seed — 20 creation units of 50,000 shares at $25.00 — the wire date moved from Mar 2 to Mar 9, 2027, and the treasury rule: Tuesdays only, 3 business days' notice. Beside it, the Readiness agent's first-NAV checklist, each check with its source: pricing coverage 212 of 212, basket test file 58 of 58, fee waiver in force. Only the treasurer can press “Confirm the wire for Mar 9”.
Treasury policy §4.2(c): “Any change to a scheduled seed wire needs the fund treasurer's confirmation.”

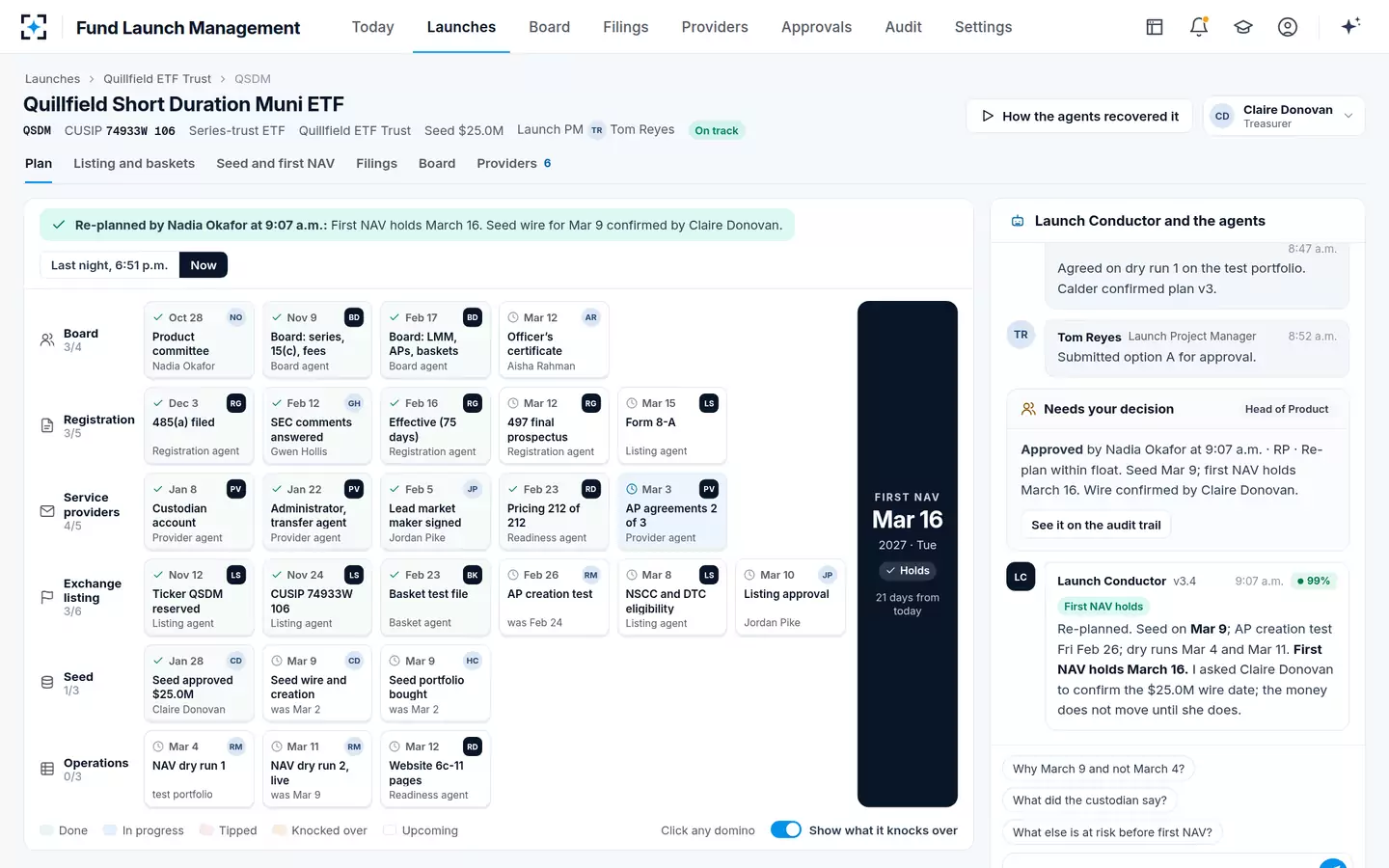

- 10First NAV holds
The plan stands, and the next launch learns from it
Launch ConductorThe banner over the dominoes reads “Re-planned by Nadia Okafor at 9:07 a.m.: First NAV holds March 16. Seed wire for Mar 9 confirmed by Claire Donovan.” The AP creation test is Feb 26, the seed Mar 9, dry runs Mar 4 and Mar 11. Then the Conductor proposes a change to the series-trust ETF playbook — custodian setup for new-issue municipal bonds from 3 to 6 business days — so the next muni launch asks a week earlier. It goes to Nadia as a change request.
The Launch Conductor never moves a date, a seed wire or a gate on its own; it proposes.
