One service bulletin evaluation, from the manufacturer's portal to a released EO
Corvane Airways flies about 300 aircraft of eight types out of its ORD hub. On Oct 1, Revision 1 of SB 787-21-0098 arrives from the airframe manufacturer's portal — the cabin air compressor inlet seal, now raised from Optional to Recommended. Here is that one SB evaluation, screen by screen, in the working solution.

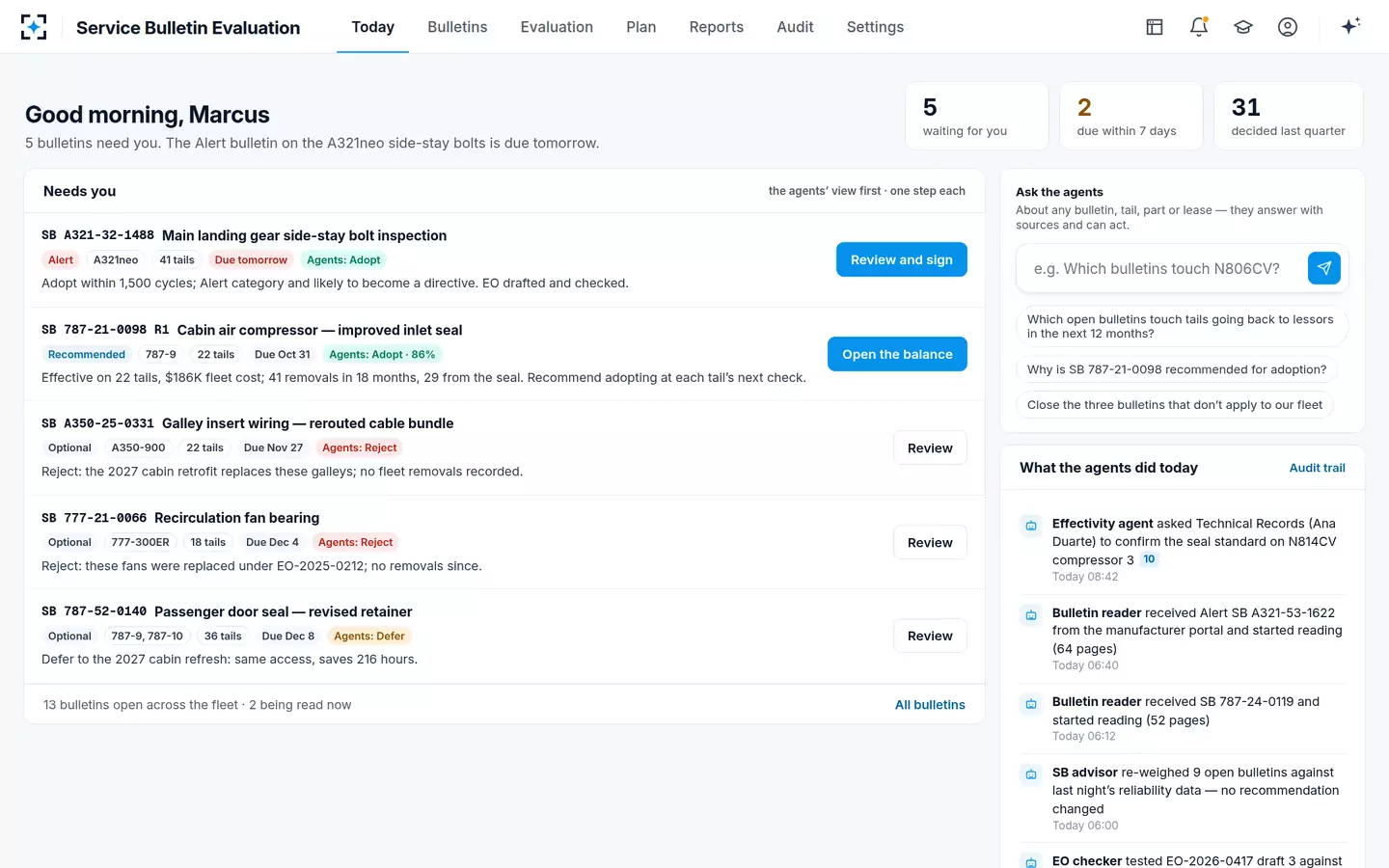

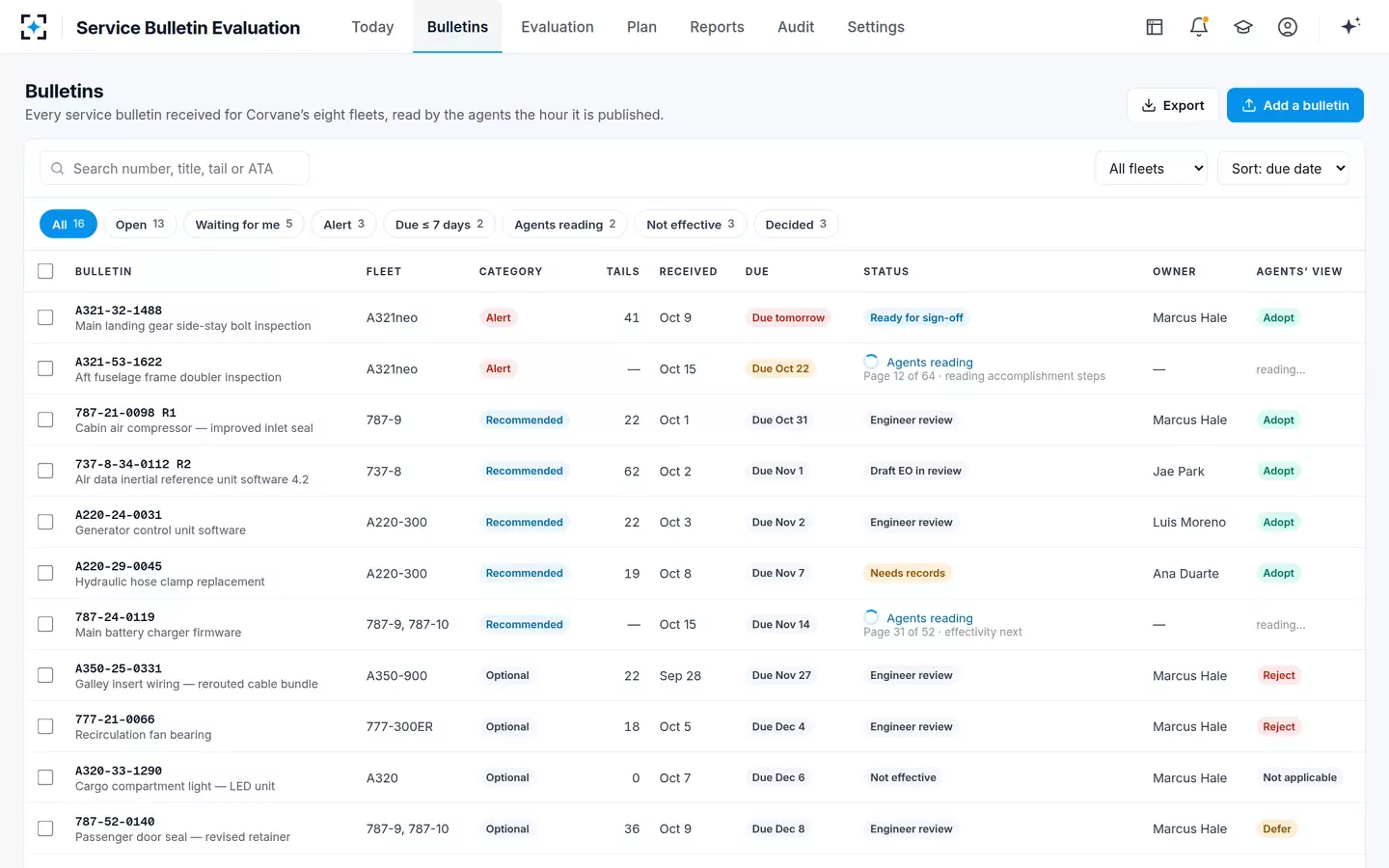

- 01Oct 15, morning
Five bulletins need him, each with the agents' view first
Marcus Hale · Powerplant and Systems EngineerMarcus owns ATA 21 and 36 for the 787 and 777 fleets. His Today screen shows 5 bulletins waiting for him, 2 due within 7 days and 31 decided last quarter. The Alert bulletin on the A321neo main landing gear side-stay bolts is due tomorrow, its EO already drafted and checked. Below it sits the compressor seal bulletin: effective on 22 tails, $186K fleet cost, 41 removals in 18 months, 29 from the seal.
What the agents did today: “Effectivity agent asked Technical Records (Ana Duarte) to confirm the seal standard on N814CV compressor 3.”

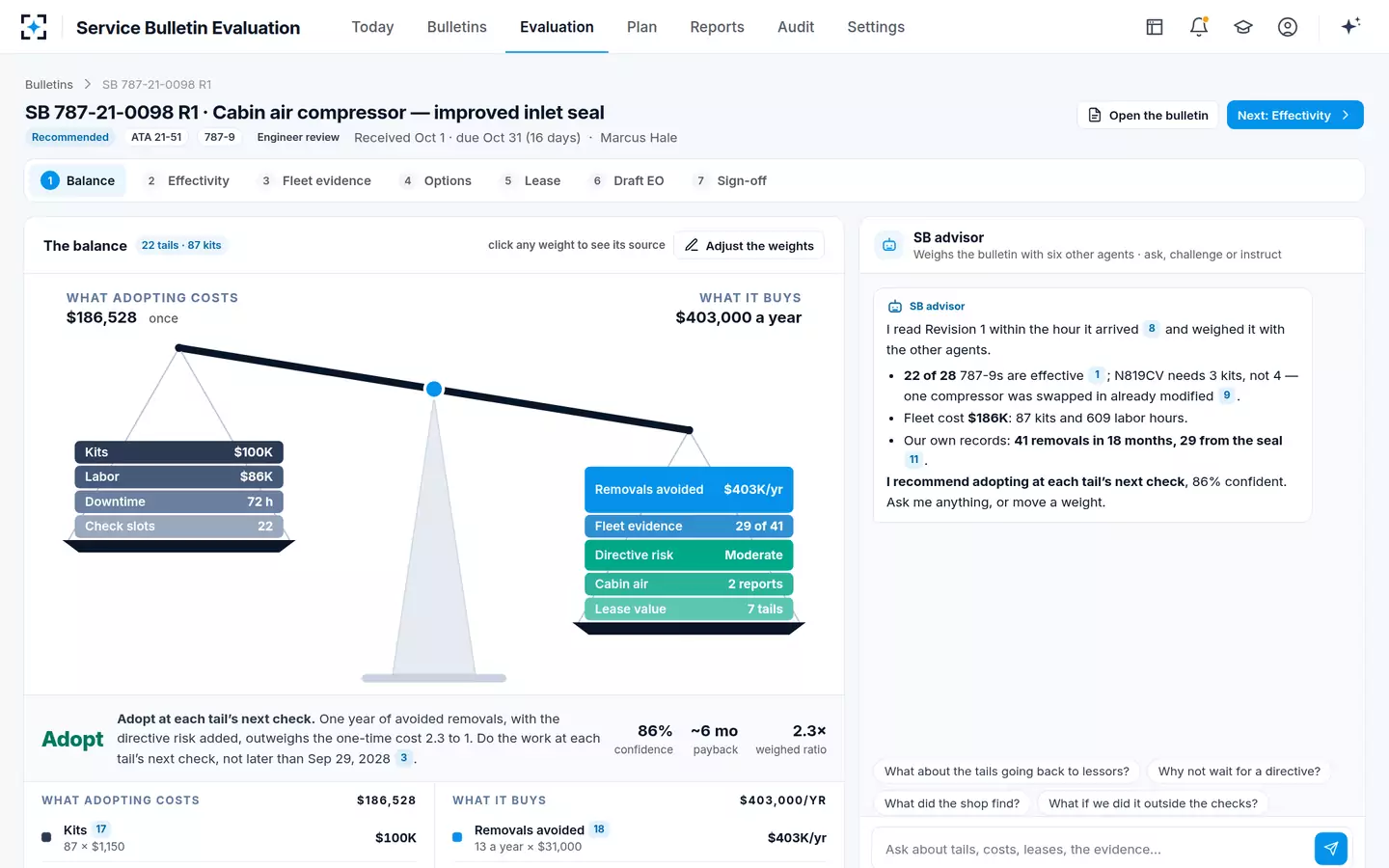

- 02Oct 1, 09:12 to 09:52
The bulletin laid out on a balance

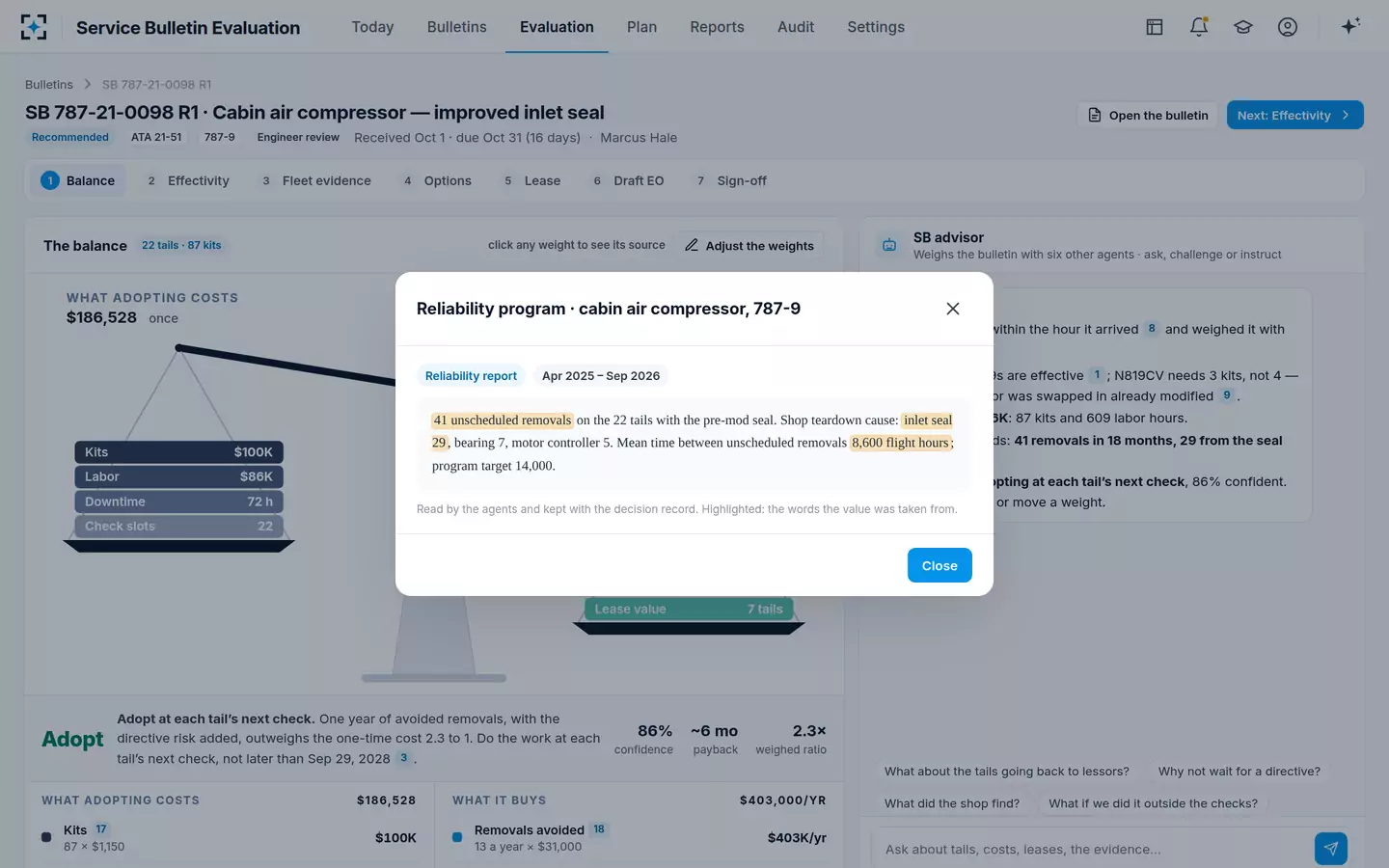

SB advisorThe bulletin reader received the 48-page revision at 09:12 and extracted 112 values. By 09:52 the other agents had weighed it. On the left, what adopting costs: 87 kits at $1,150, 609 labor hours at $142, 72 overnight hours inside A-check windows and 22 check slots — $186,528 once. On the right, what it buys: 13 removals a year avoided at $31,000 each, $403,000 a year. The verdict under the beam: Adopt at each tail's next check, 86% confident, about 6 months to pay back.
“I recommend adopting at each tail’s next check, 86% confident. Ask me anything, or move a weight.”
- 03One click
Every weight opens the record behind it
Fleet evidence agentMarcus clicks the fleet evidence weight. The reliability program passage opens with the words the value was taken from highlighted: 41 unscheduled removals on the 22 tails with the pre-mod seal, 29 traced to the inlet seal by shop teardown, 7 to the bearing and 5 to the motor controller. Mean time between unscheduled removals is 8,600 flight hours against a program target of 14,000.
“Read by the agents and kept with the decision record. Highlighted: the words the value was taken from.”

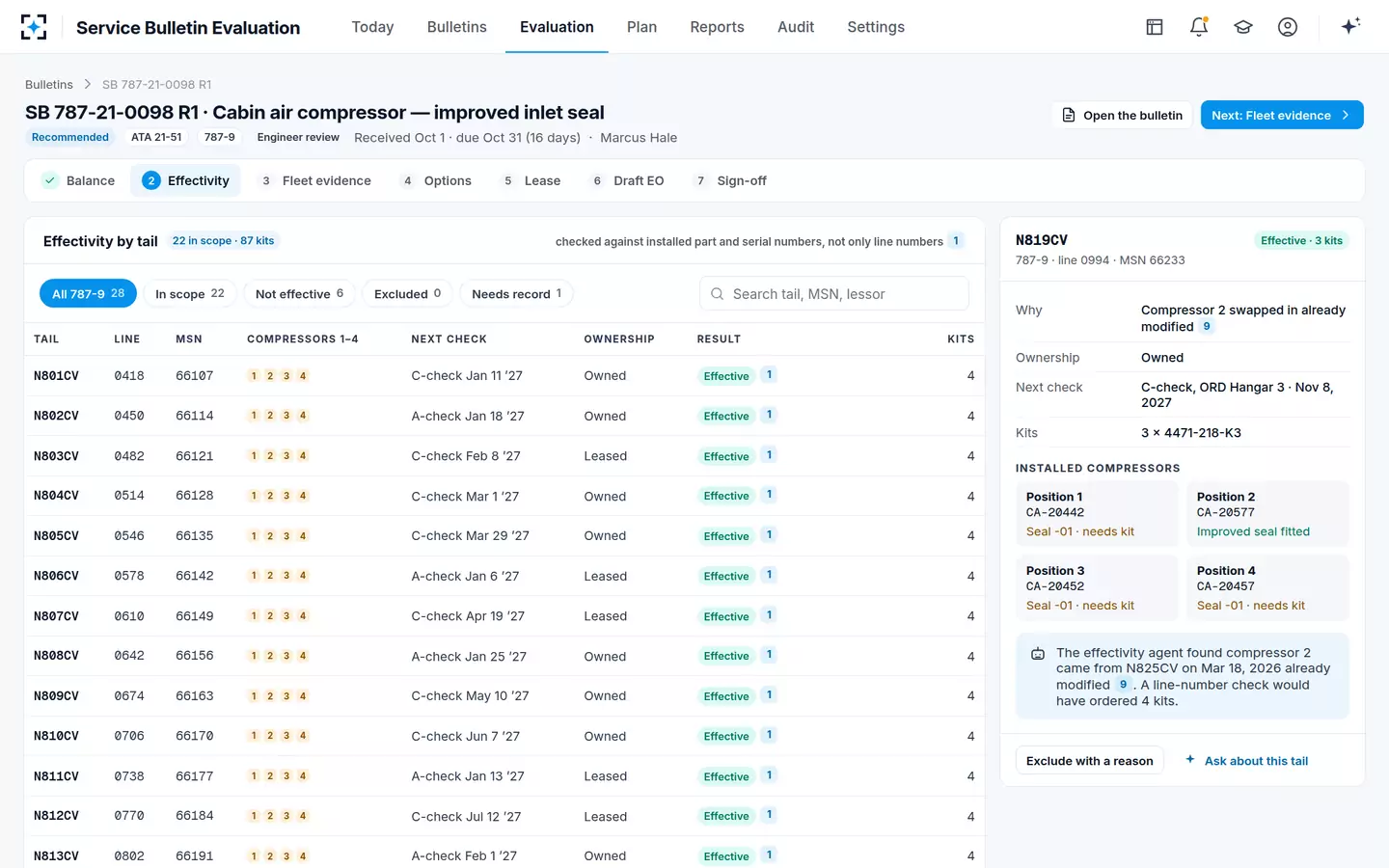

- 04Effectivity
22 of 28 tails — and N819CV needs 3 kits, not 4
Effectivity agentThe bulletin applies to 787-9 line numbers 0412 through 1103 with compressor 4471-200-07 and seal 4471-218-01. The effectivity agent checked every tail's installed part and serial numbers, not only its line number. Compressor 2 on N819CV, S/N CA-20577, came from N825CV on Mar 18, 2026 already modified. N814CV's compressor 3 came back from a shop visit without its seal standard recorded, so it counts as needing a kit until Technical Records confirms.
“A line-number check would have ordered 4 kits.”

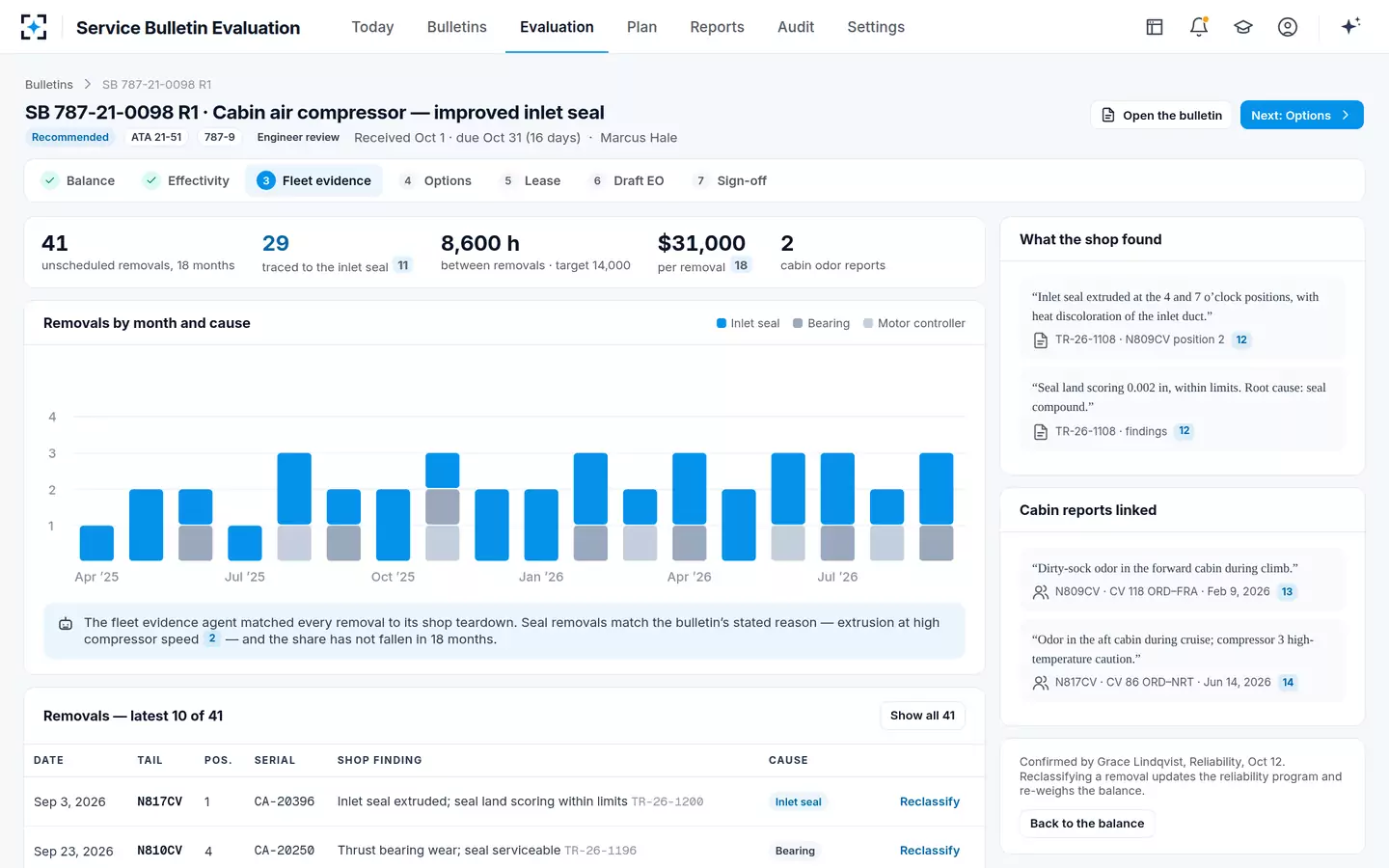

- 05The fleet's own evidence
Removals by month and cause, tied to the bulletin's reason
Grace Lindqvist · Reliability EngineerEighteen months of removals, stacked by cause, with every one matched to its shop teardown. The seal removals match the reason in the bulletin — extrusion at high compressor speed — and their share has not fallen. Teardown TR-26-1108 on N809CV reads “Inlet seal extruded at the 4 and 7 o’clock positions, with heat discoloration of the inlet duct.” Two cabin odor reports are linked: flight CV 118 ORD–FRA and CV 86 ORD–NRT. Grace confirmed the causes on Oct 12. It is the kind of removal and teardown data a US carrier's continuing analysis and surveillance system (CASS) under 14 CFR 121.373 typically draws on.
The fleet evidence agent never reclassifies a removal — the reliability engineer does, and the balance re-weighs.
- 06He argues back

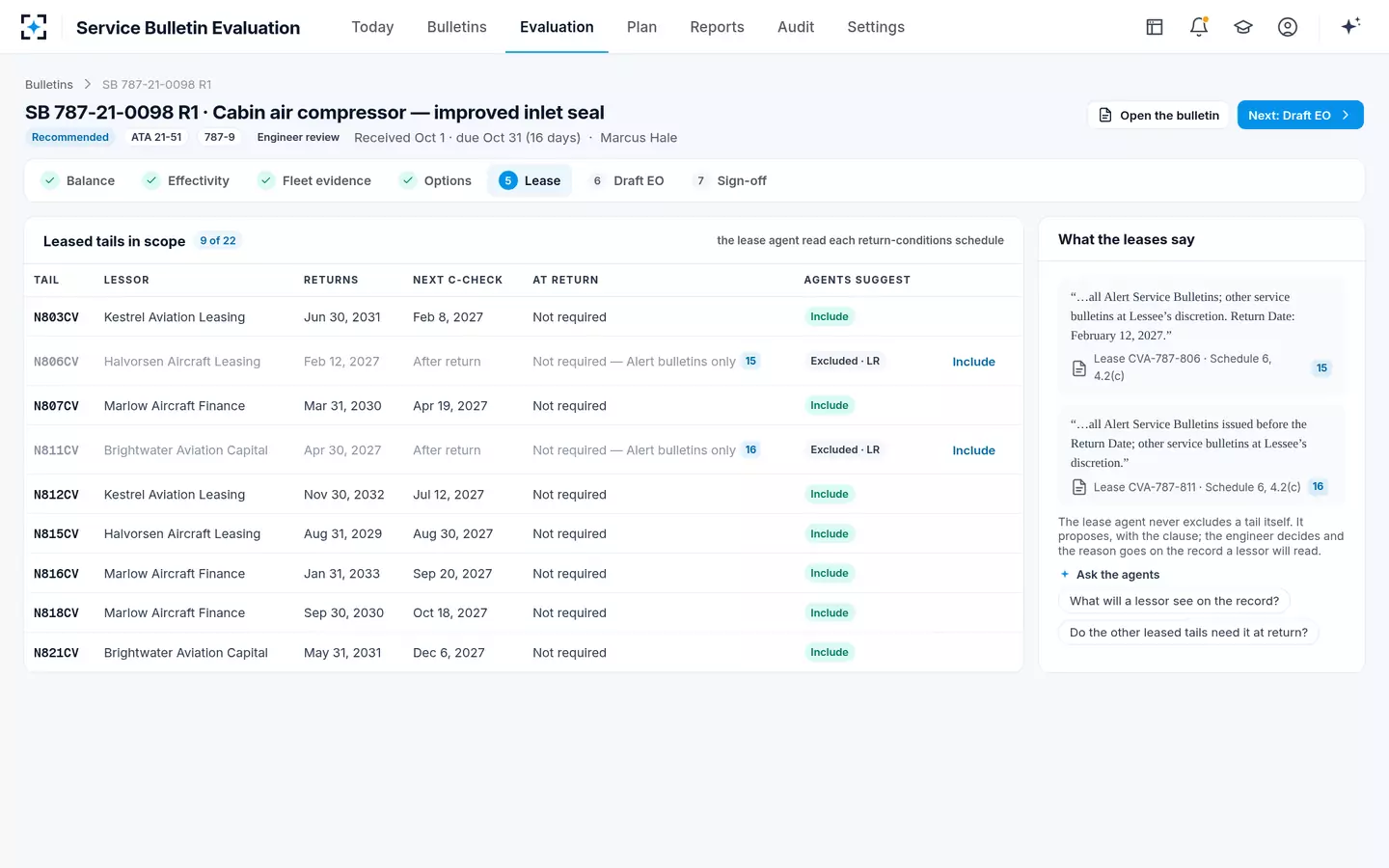

“What about the tails going back to lessors?”
Marcus Hale · Powerplant and Systems EngineerThe advisor answers with the clauses. N806CV goes back to Halvorsen Aircraft Leasing on Feb 12, 2027 and N811CV to Brightwater Aviation Capital on Apr 30, 2027, both before their next C-check. Both leases require directives and Alert bulletins only; this one is Recommended, so it is Corvane's choice. Doing both would cost $17,152 — 8 kits, 56 hours — with no return credit. It suggests excluding both with reason LR.
“The lease agent never excludes a tail itself. It proposes, with the clause; the engineer decides and the reason goes on the record a lessor will read.”

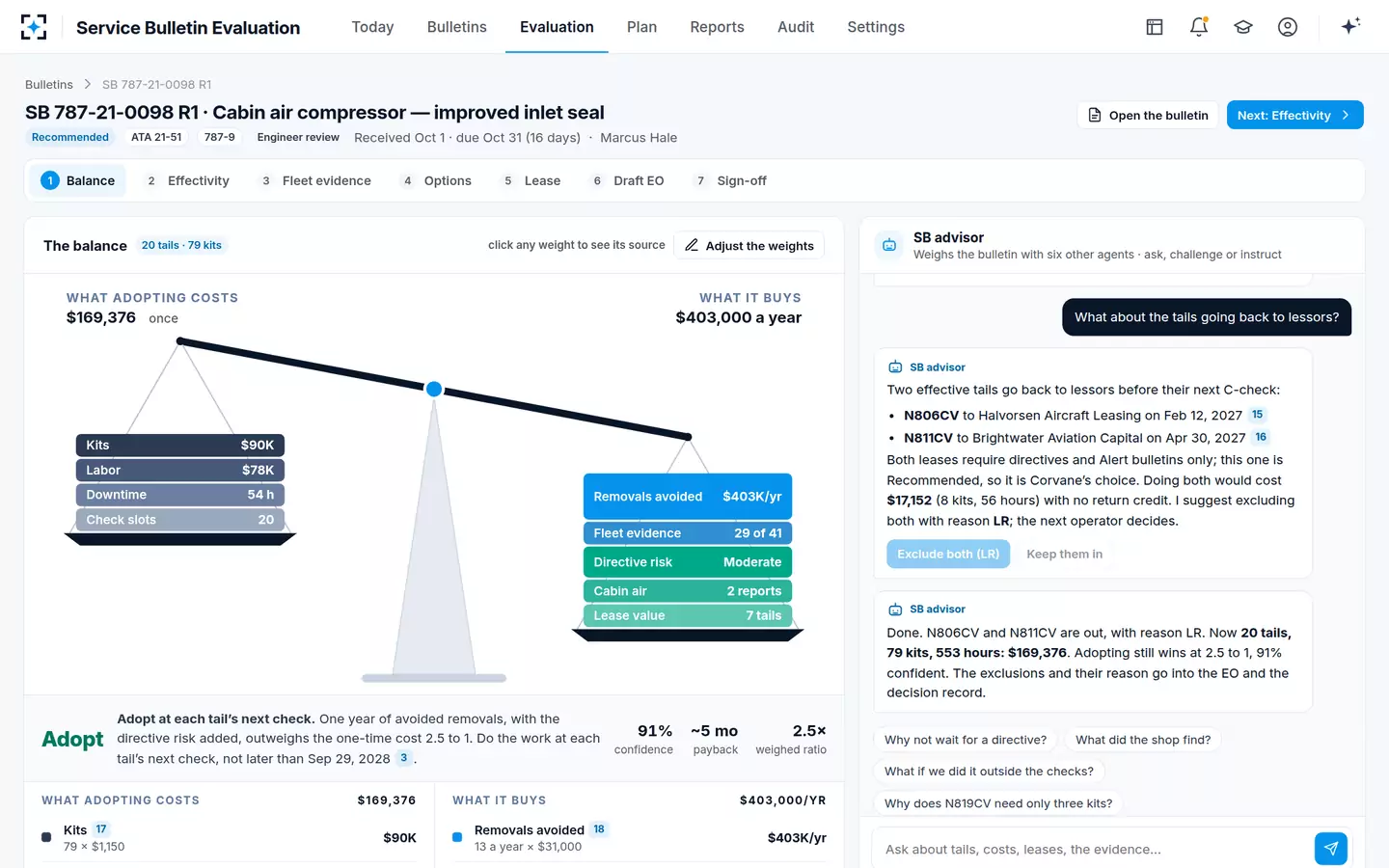

- 07Re-weighed
Two tails out with a reason — still Adopt
SB advisorMarcus excludes both, reason LR, lease return before embodiment. The balance re-weighs at once: 20 tails, 79 kits, 553 hours, $169,376. Adopting still wins at 2.5 to 1, now 91% confident, with payback in about 5 months. On the lease view both tails now read Excluded · LR beside the clause that justifies it, and the reason goes into the EO and the decision record a lessor or an inspector will read. Asked what a lessor will see, the agents answer: at return the records show SB 787-21-0098 R1 as “evaluated, not embodied, at Lessee’s discretion” — what Schedule 6, 4.2(c) allows.
Advisor: “Done. N806CV and N811CV are out, with reason LR. Now 20 tails, 79 kits, 553 hours: $169,376.”

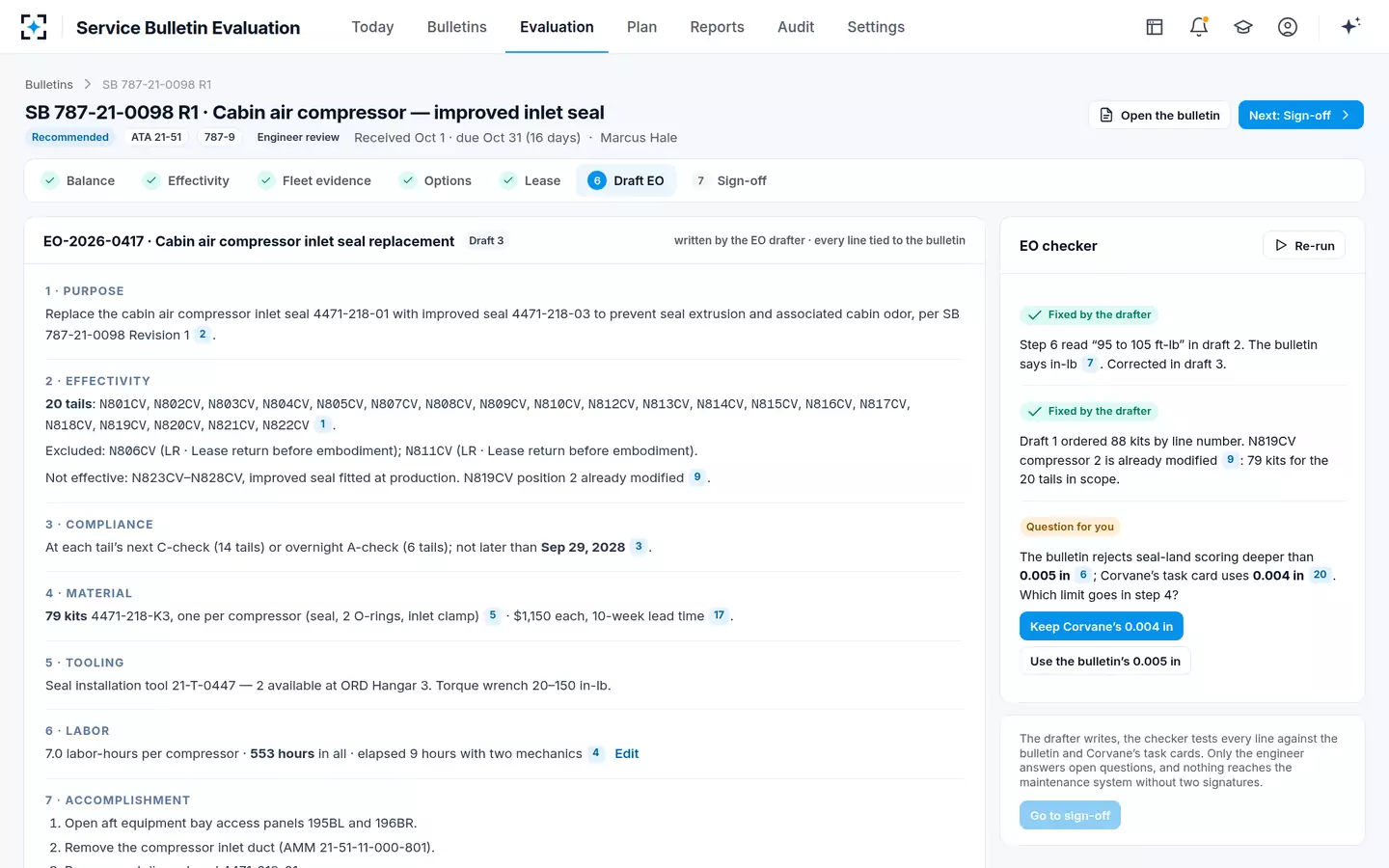

- 08Draft 3
An engineering order written from the bulletin, then tested line by line
EO drafter and checkerThe drafter writes EO-2026-0417 in nine sections — purpose, effectivity, compliance, material, tooling, labor, accomplishment, records, references — every line tied to the bulletin. The checker tested it against the bulletin and Corvane's task cards. It caught step 6 reading 95 to 105 ft-lb where the bulletin says in-lb, and draft 1 ordering 88 kits by line number; the drafter fixed both. One real question is left for Marcus: the bulletin's seal-land limit is 0.005 in, Corvane's task card uses 0.004 in. He keeps Corvane's 0.004 in.
“Only the engineer answers open questions, and nothing reaches the maintenance system without two signatures.”

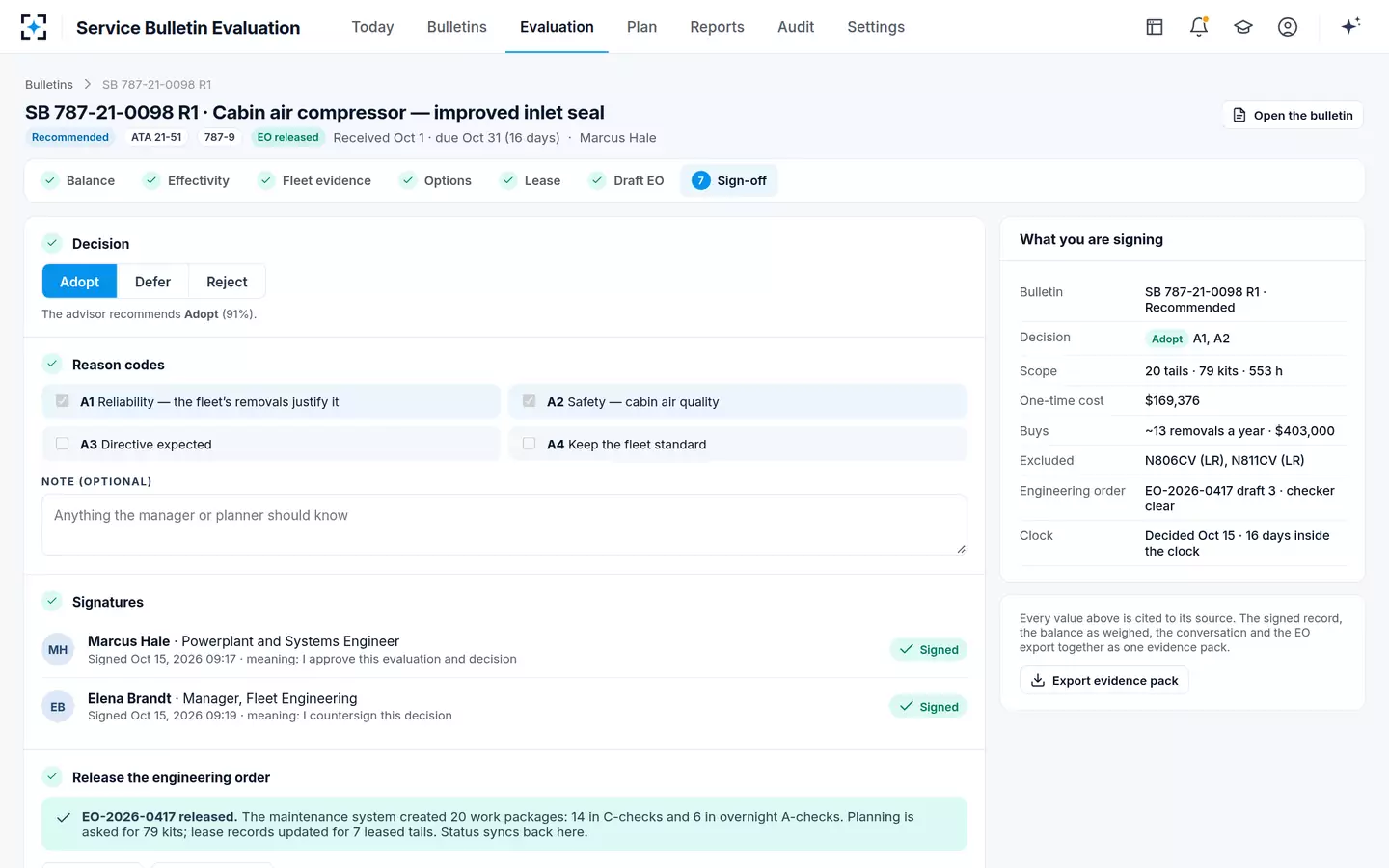

- 09Signed · Oct 15
He signs Adopt; his manager countersigns; the EO is released
Marcus Hale and Elena BrandtMarcus signs Adopt with reason codes A1, reliability, and A2, cabin air quality — the meaning recorded with his name and the time. Elena Brandt, Manager, Fleet Engineering, adds the second signature. Released to the maintenance system, EO-2026-0417 becomes 20 work packages: 14 in C-checks and 6 in overnight A-checks, with 79 kits requested and lease records updated for 7 leased tails — 16 days inside the clock.
“Your signature records your name, the time and its meaning. It cannot be edited afterwards.”

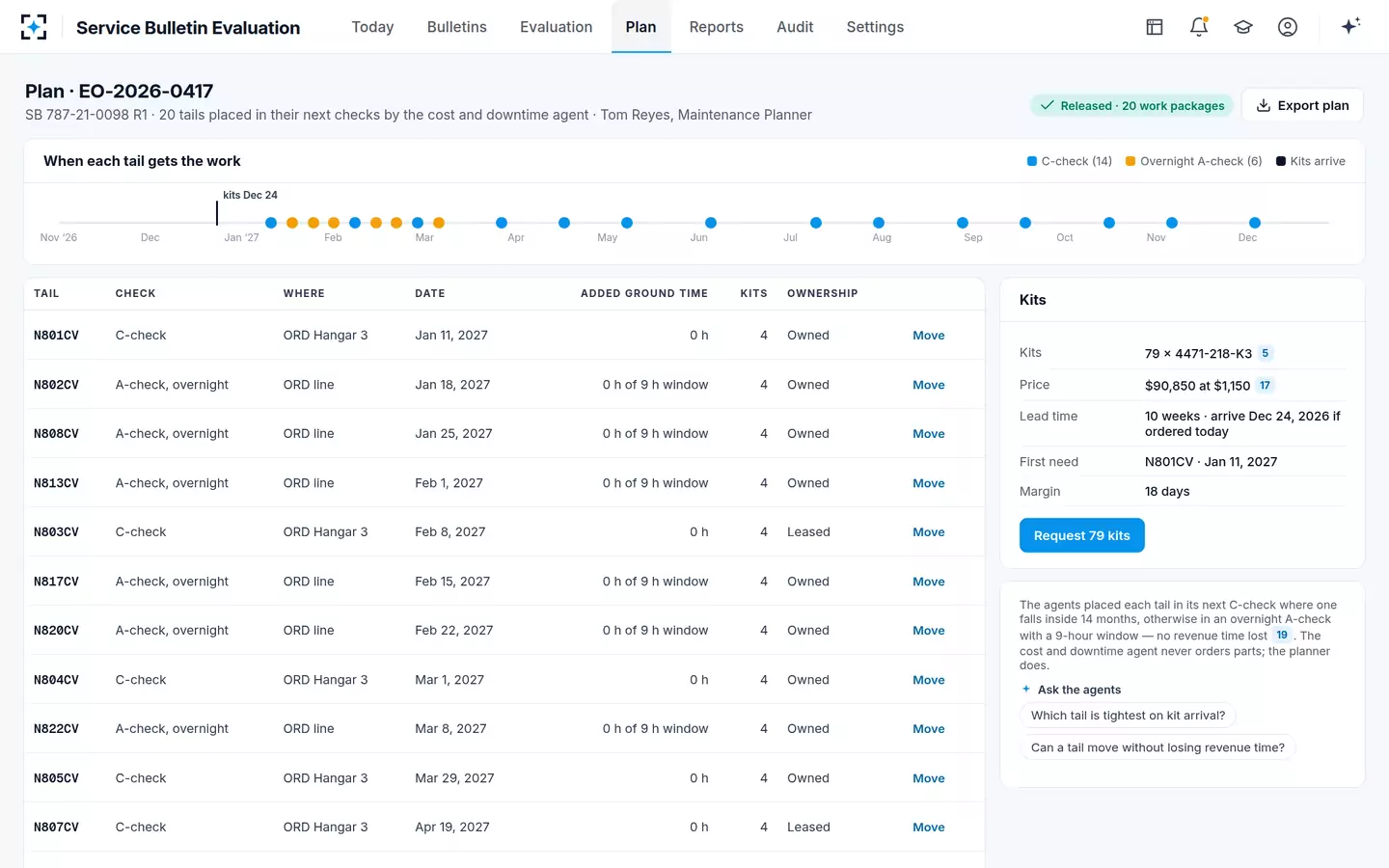

- 10The plan
Every tail in a slot it already has
Tom Reyes · Maintenance PlannerThe cost and downtime agent placed each tail in its next C-check where one falls inside 14 months, otherwise in an overnight A-check with a 9-hour window — no revenue time lost. Tom sees 79 kits at $90,850 with a 10-week lead time, arriving Dec 24, 2026 if ordered today, against a first need on N801CV on Jan 11, 2027: 18 days of margin. He asks which tail is tightest on kit arrival; the answer is N801CV, and if the order goes later than Nov 2, move it to its next A-check. The kit request is his to send.
“The cost and downtime agent never orders parts; the planner does.”
