SystemPower Generation & Desalination

Electricity and Water Demand Forecasting

Electricity and water demand forecasting, hour by hour and together — see the summer peak, and what it does to your reservoirs, before it arrives

Plan for the summer peak before it arrives.

See one case, screen by screen ↓
demo46%Northgate reservoirs at midnight with the approved fix, against 34 % — under the 40 % minimum from 19:00 — on the heatwave day's original plan
estimated$72,700lessthan running peaker GT-11 on the one heatwave day, with 173 t less CO₂ — pre-filling through the north main costs $5,700
demo2.9% MAPEday-ahead power error on the 14 heat days of the summer, against 5.1 % for the previous model run in parallel
target1daywarning before a reservoir runs short in a heatwave, seen when the forecast is made
The problem

Why a heatwave can empty a reservoir that both forecasts said was fine

At a utility whose power stations also make drinking water, the load forecaster publishes the day-ahead hourly forecast by 10:00 for unit commitment and fuel nominations, and the water production planner forecasts water demand by zone in a spreadsheet to set the MSF units and RO trains. The dispatch centre then applies its standing rules — for example, curtail interruptible desalination load when the reserve margin at peak is under 10 % — with no check on the water side. When a new weather bulletin lands mid-morning, only the power model is re-run.

So nobody sees where the two collide. A heatwave pushes the 3 pm peak up, the reserve margin drops under the trigger, the rule cuts the RO trains that fill a reservoir, and the evening rise in water demand takes that reservoir under its minimum by midnight. Heat days, dust haze on rooftop solar, school terms and Ramadan — which moves every year with the lunar calendar — are where forecast error lives, and a monthly MAPE report averages that tail away.

typical$300K/yrper GW of peak for each point of short-term load forecast error (MAPE) — a published rule of thumb
typical2,164MWof demand (4.6 %) under-scheduled day-ahead in California's August 2020 rotating outages
typical15%less pumping energy cost when pumps and valves follow an hourly water demand forecast — a three-month Sydney Water / Data61 simulation
Where a heatwave day's forecasting hours goestimated
By hand12 days
With the solution1.8 days
  • Running the load model and publishing the day-ahead forecast3 → 0.5 d
  • Re-running after a revised weather bulletin1.5 → 0.2 d
  • Forecasting water demand by zone in a spreadsheet2 → 0.3 d
  • Working out what a dispatch rule does to each reservoir2.5 → 0.2 d
  • Pricing the fixes and getting the shift manager's decision2 → 0.5 d
  • Scoring accuracy against actuals1 → 0.1 d

Estimated split for one day with a revised weather bulletin, in hours across the forecasting, water and dispatch desks, by hand and with the solution.

How it works

How a forecast is made

Six agents forecast power and water together and check one against the other; the lead forecaster publishes and the shift manager approves.

What comes in
Data inweather, load, calendar, plants · bulletins, meters, SCADA, rules
Agents at work
Weather readerbands by zone
Calendar keeperRamadan, terms
Then
Power demand forecasterhourly, P10–P90
Water demand forecasterhourly, by zone
Then
Power–water balance checkerrules, reservoirs, options
Then
Accuracy trackerMAPE every night
A person decides
Lead forecaster and shift managerpublish; approve the plan
What comes out
Signed forecast
Plan to plants
Reservoirs held
One case, step by step

One heatwave bulletin, from 09:40 to a signed plan by 10:34

Lumina Utilities runs power stations that also make drinking water. On Wednesday 12 August 2026, Leila Farouk has already published Thursday's day-ahead forecast. Then the weather centre raises Thursday's maximum. Here is what happens next, screen by screen, in the working solution.

  1. 0109:40

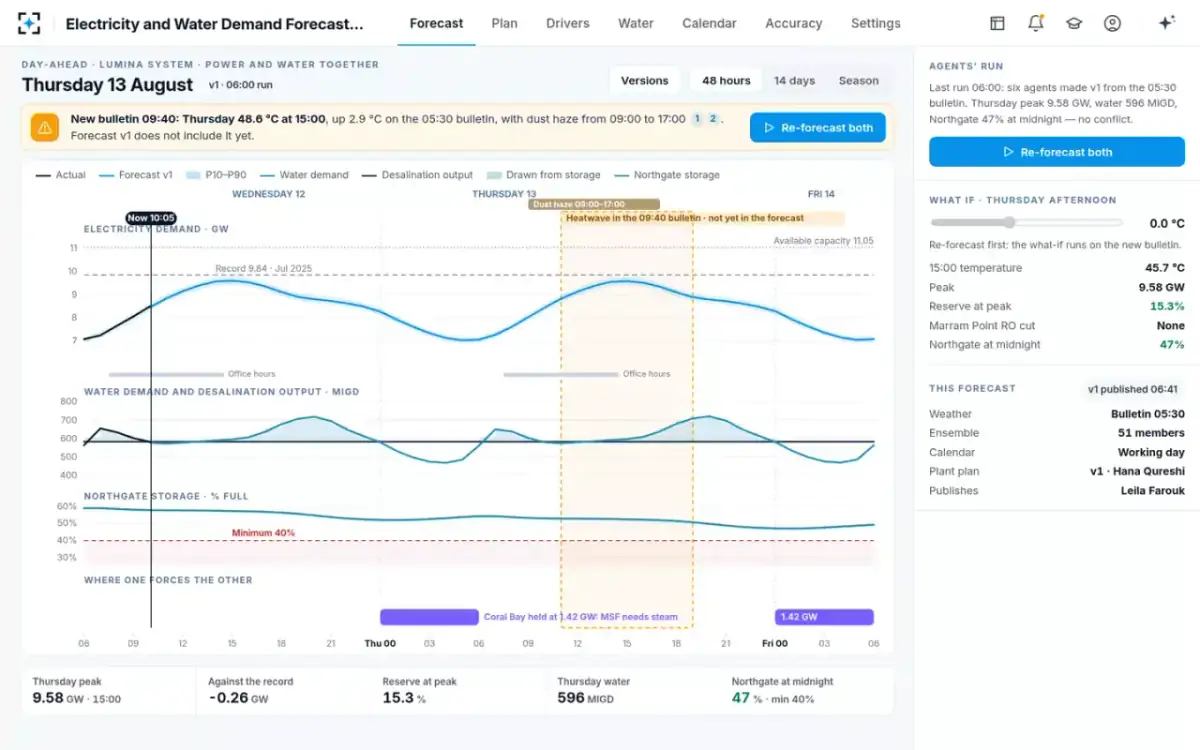

    A new bulletin: 48.6 °C at 15:00 Thursday

    Leila Farouk · lead load forecaster

    Leila's 06:00 run, published at 06:41, had Thursday's peak at 9.58 GW, water at 596 MIGD and the Northgate reservoirs at 47 % at midnight — no conflict. The 09:40 bulletin from the Lumina National Weather Centre puts Thursday at 48.6 °C at 15:00, up 2.9 °C on the 05:30 bulletin, with dust haze from 09:00 to 17:00. The heatwave band is drawn across all four lanes of the chart before anything is re-run.

    “Heatwave in the 09:40 bulletin · not yet in the forecast”

  2. 0210:11

    Re-forecast both: power and water on the same weather

    Six agents

    Leila presses Re-forecast both. The weather reader takes the bulletin and the 51-member ensemble (47.3–49.5 °C at 15:00). The calendar keeper confirms a working day on summer office hours, 07:30–14:30, with schools on holiday until Mon 24 Aug. Both forecasters then run on that one weather and calendar, and the run log fills in the side rail, step by step, with a time on each.

    Power demand forecaster: “Thursday 15:00: 9.58 → 10.12 GW (P10–P90 9.89–10.35); above the 9.84 GW record”

  3. 0310:12

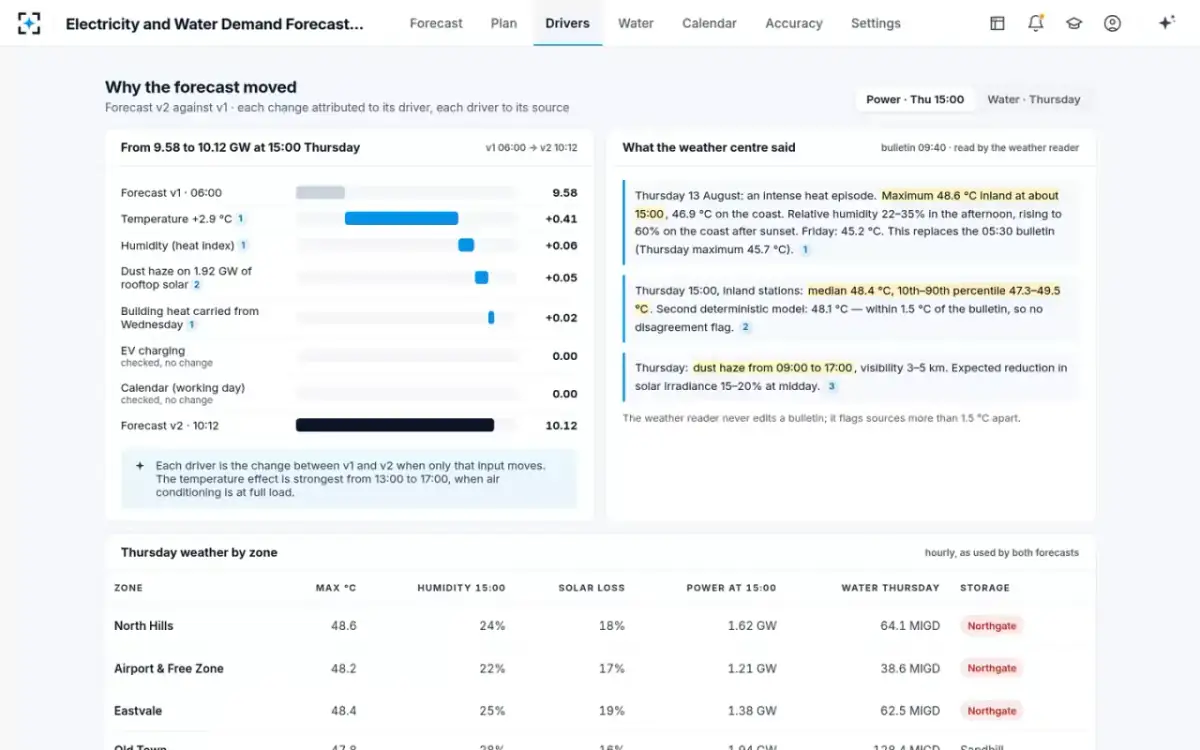

    Why the 15:00 peak moved, driver by driver

    Power demand forecaster

    Forecast v2 against v1, each change attributed to its driver: temperature +2.9 °C adds 0.41 GW, humidity 0.06, dust haze on 1.92 GW of rooftop solar 0.05, building heat carried from Wednesday 0.02. EV charging and the calendar were checked, no change. Beside the bars, the bulletin text the weather reader used, each line cited, and the weather by zone that both forecasts used.

    “The temperature effect is strongest from 13:00 to 17:00, when air conditioning is at full load.”

  4. 0410:12

    The collision: a dispatch rule empties Northgate

    Power–water balance checker

    At 10.12 GW the reserve margin at peak is 9.2 %, under the 10 % trigger, so rule DR-4 cuts Marram Point RO trains 5–8 — 76 MIGD and 61 MW — from 13:00 to 19:00. Water demand rises from 596 to 612 MIGD, most of it after 17:00, when people come home. Northgate, which feeds North Hills, Airport & Free Zone and Eastvale, reads 57.7 % on SCADA at 10:00 and falls to 34 % by midnight.

    “Northgate falls under 40 % at 19:00 and reaches 34 % at midnight. A power-only forecast would not have shown this.”

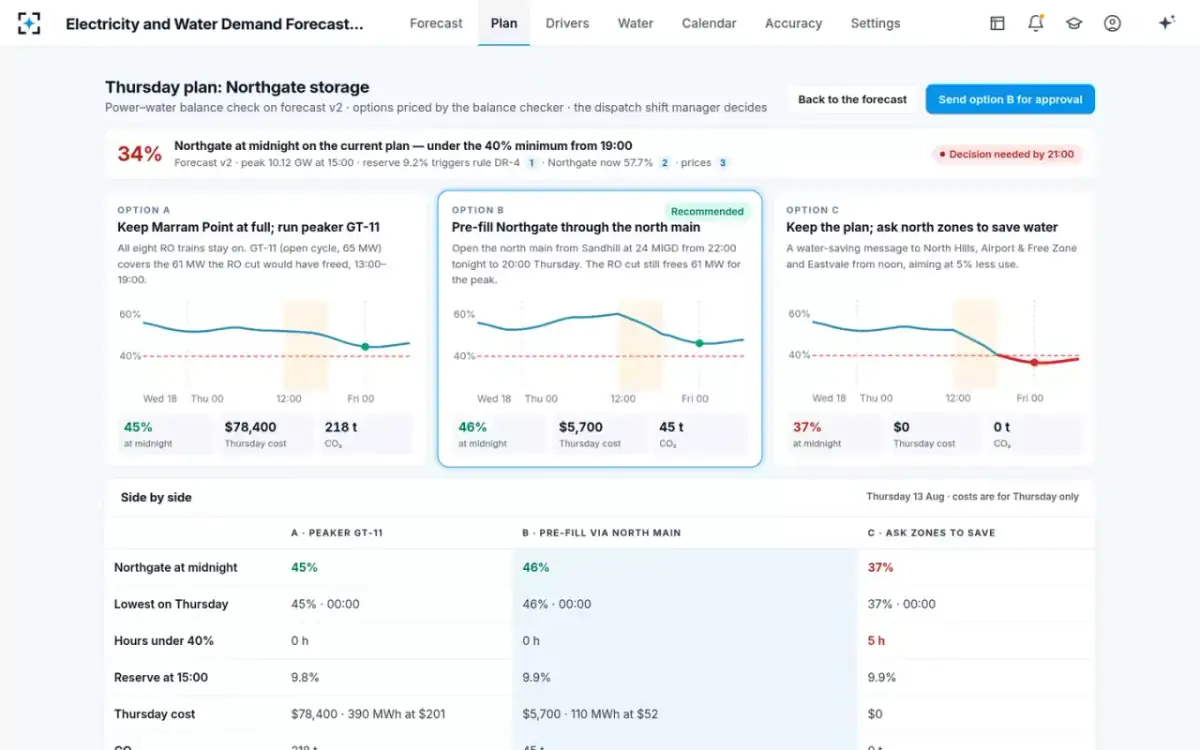

  5. 05Three fixes

    Every option priced in storage, reserve, cost and CO₂

    Power–water balance checker

    A: keep Marram Point at full and run peaker GT-11 — Northgate 45 %, $78,400, 218 t CO₂. B: pre-fill Northgate through the north main from Sandhill at 24 MIGD, 22:00 tonight to 20:00 Thursday — Northgate 46 %, $5,700, 45 t CO₂, and the RO cut still frees 61 MW for the peak. C: ask the north zones to save 5 % from noon — Northgate 37 %, five hours under the minimum. Each option shows its Northgate path and who acts.

    Option B is recommended. The balance checker proposes options only — it never changes a plant schedule or sends a dispatch instruction.

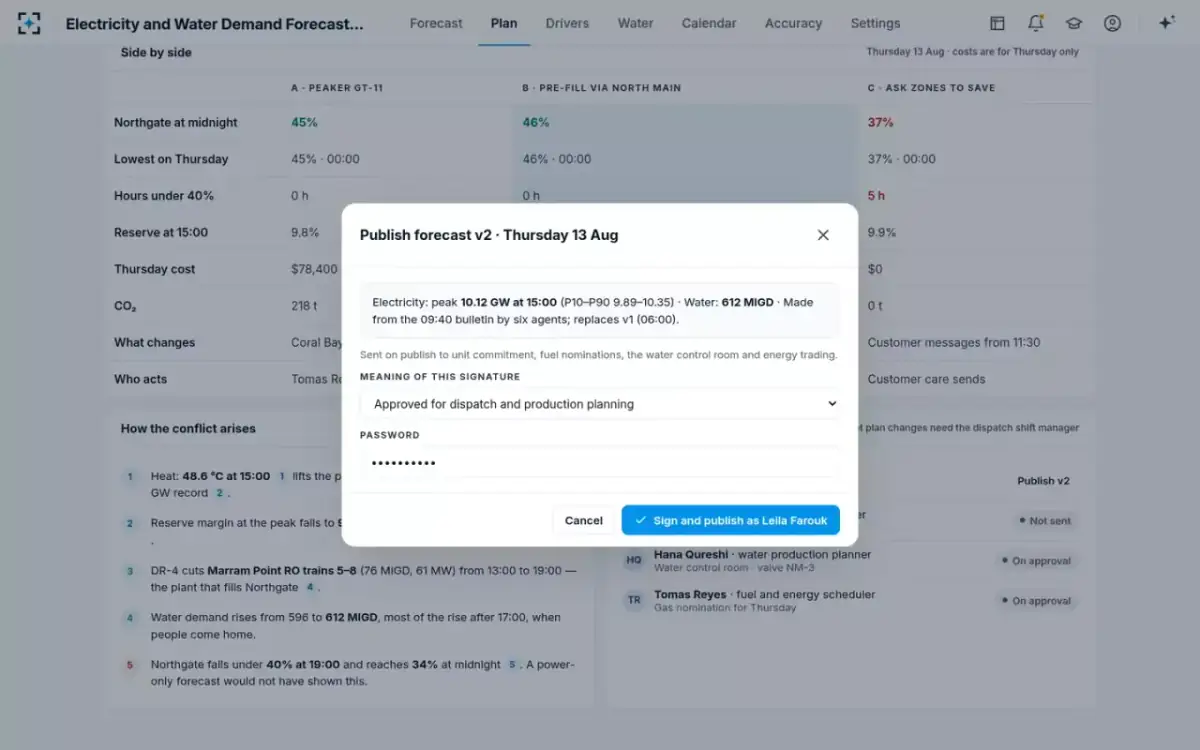

  6. 0610:21

    Leila signs forecast v2, with the meaning of her signature

    Leila Farouk · lead load forecaster

    The signature box shows what she is publishing: peak 10.12 GW at 15:00 (P10–P90 9.89–10.35), water 612 MIGD, made from the 09:40 bulletin, replacing v1. She chooses the meaning — “Approved for dispatch and production planning” — and signs with her password. On publish, v2 goes to unit commitment, fuel nominations, the water control room and energy trading.

    Only the lead forecaster publishes. The forecasters draft; they never publish.

  7. 0710:34

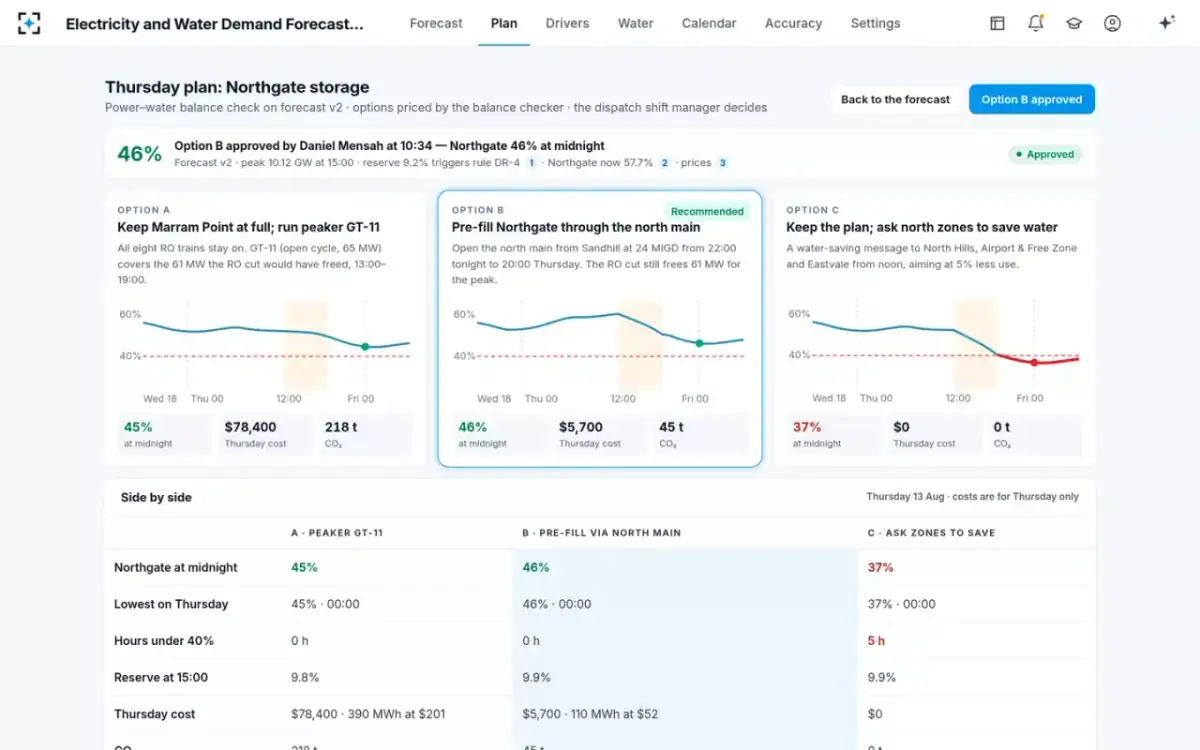

    Daniel approves option B

    Daniel Mensah · dispatch shift manager

    Leila sends option B to Daniel with a note: “Heatwave Thursday — Northgate short by midnight on the current plan.” Daniel approves at 10:34, and the plan goes to Coral Bay and the water control room. The water control room opens valve NM-3 at 22:00; Hana Qureshi, the water production planner, is informed. Option A would have had Tomas Reyes booking gas for GT-11.

    “Option B approved by Daniel Mensah at 10:34 — Northgate 46 % at midnight”

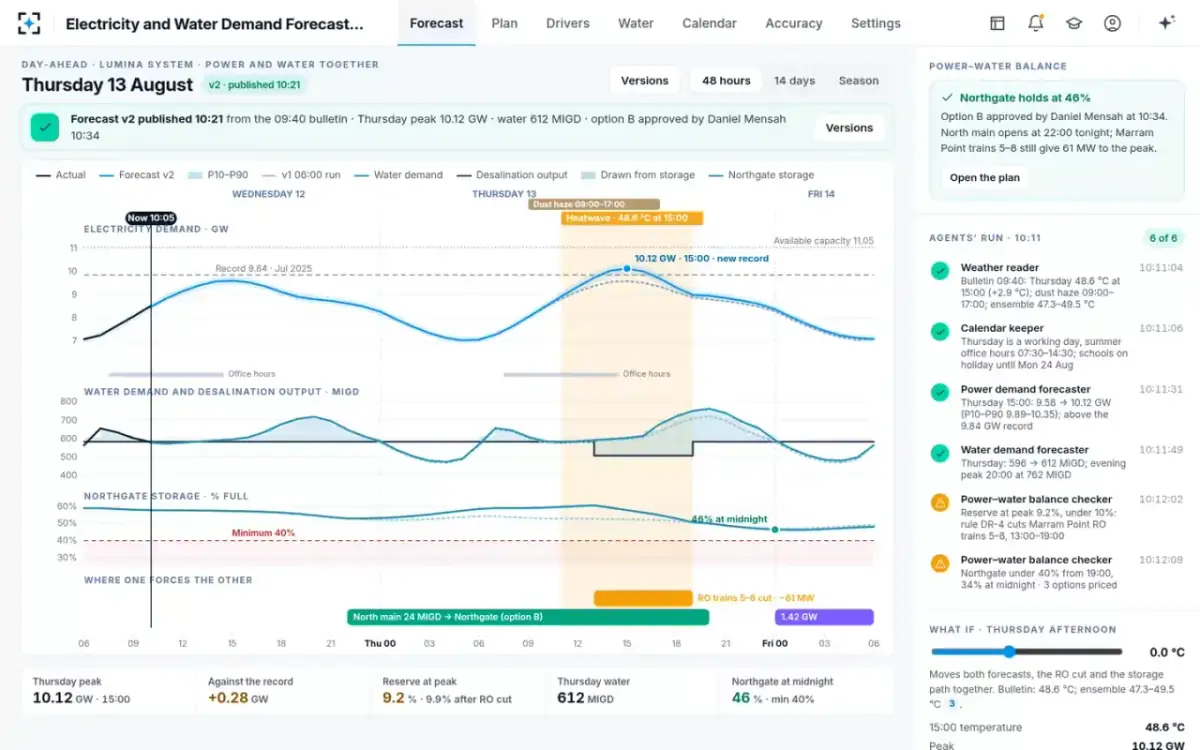

  8. 08Back on the forecast

    Northgate holds at 46 % overnight

    Leila Farouk · lead load forecaster

    The Forecast screen now shows v2 published at 10:21 and the north main transfer drawn on the coupling strip, Wednesday 22:00 to Thursday 20:00. The storage lane stays above the 40 % line. The same strip shows the coupling the other way: Coral Bay units C1–C4 are held at 1.42 GW overnight, because their MSF units need steam.

    “North main opens at 22:00 tonight; Marram Point trains 5–8 still give 61 MW to the peak.”

  9. 09On the record

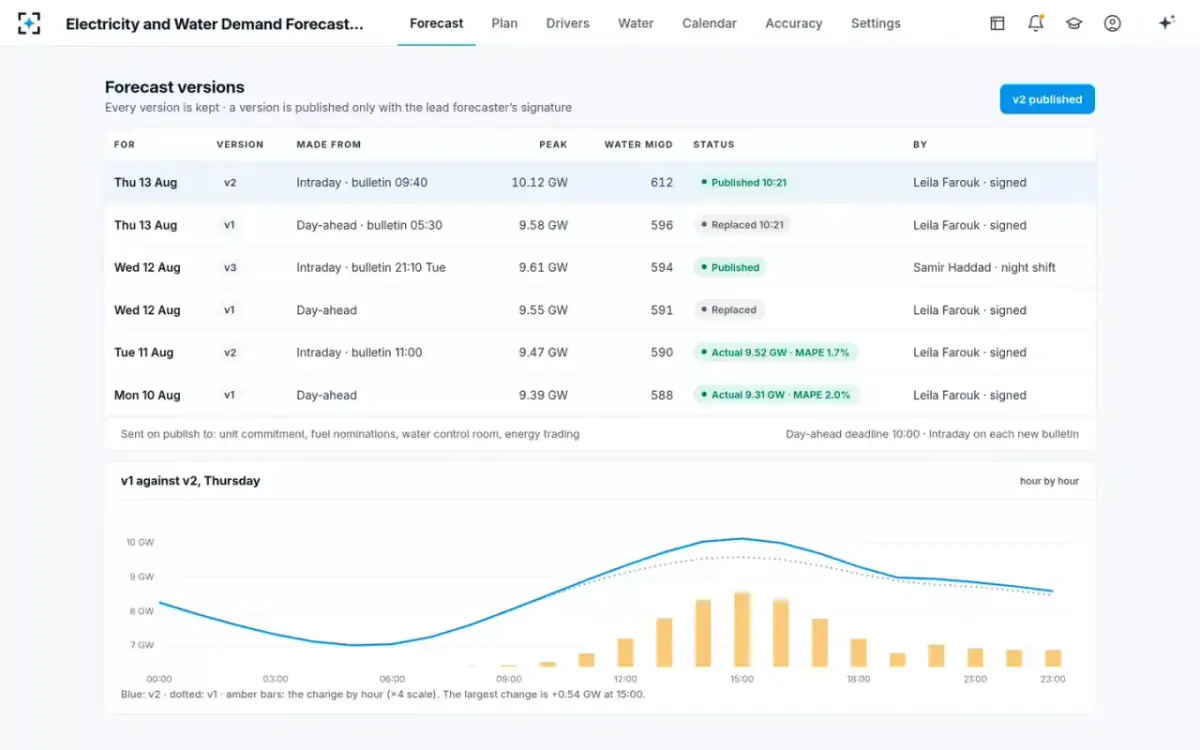

    v1 is replaced, never overwritten

    Every forecast version

    Every version is kept, with what it was made from, its peak and water total, its status and who signed it. Thursday's v1 shows Replaced 10:21; Tuesday's v2 already carries its actual, 9.52 GW, and its MAPE, 1.7 %. The v1-against-v2 chart shows the change by hour: the largest is +0.54 GW at 15:00.

    “Every version is kept · a version is published only with the lead forecaster's signature”

  10. 1001:00 every night

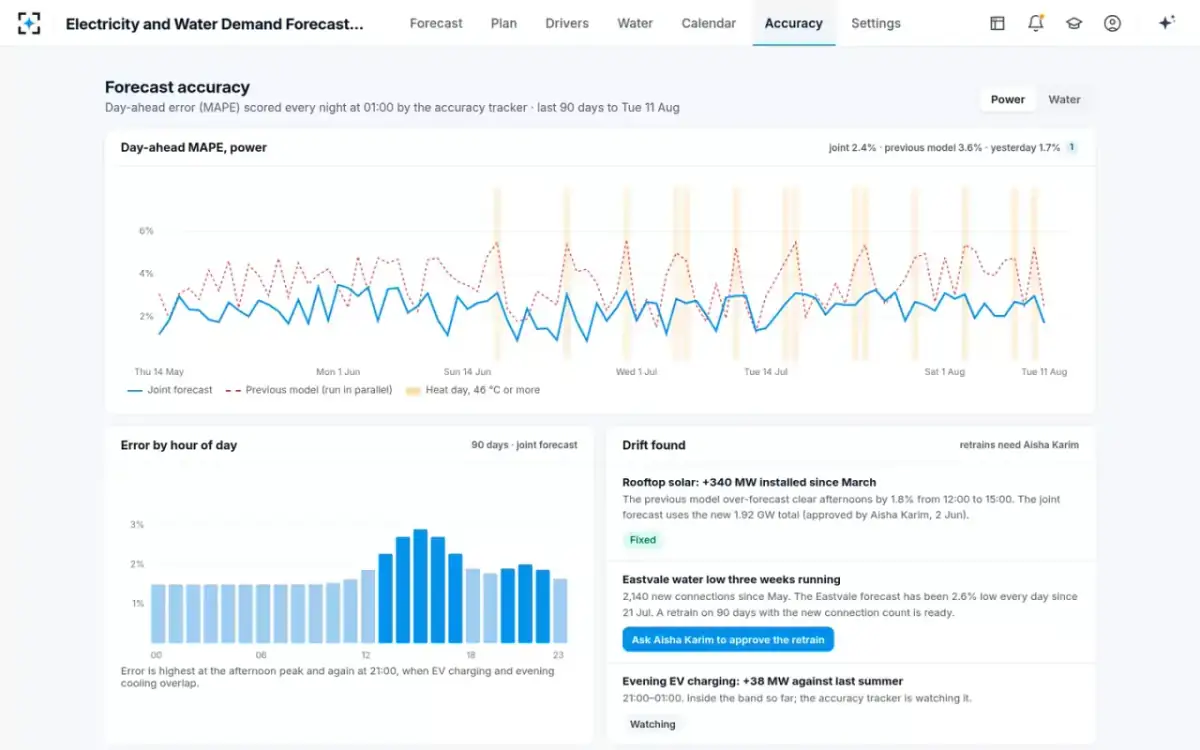

    Scored by hour, by heat day — and drift found

    Accuracy tracker

    The accuracy tracker scores every published version against actuals: over 90 days, a day-ahead MAPE of 2.4 % for the joint forecast against 3.6 % for the previous model, with the error highest at the afternoon peak and again at 21:00, when EV charging and evening cooling overlap. It has found the Eastvale water forecast 2.6 % low every day since 21 Jul, after 2,140 new connections, and has a retrain ready.

    The accuracy tracker never retrains a model without approval — the retrain waits for Aisha Karim.

Who it’s for

Built for everyone who plans the next day's power and water.

The same heatwave Thursday, seen by the five people who forecast, schedule, produce and decide — what their day looked like, and what it looks like now.

LF
Leila FaroukLead load forecaster, System Operations · publishes every forecast version
Lead load forecaster
Before
Publishes the day-ahead forecast at 10:00 and re-runs the power model when the weather changes. “I can tell you the 3 pm peak. I can't tell you what it does to the reservoirs.”
Now
Re-forecasts power and water together on each new bulletin, sees the reservoir path beside the peak, and signs each version with its meaning recorded.
DM
Daniel MensahShift manager, Power and Water Dispatch · approves any change to the plant plan
Dispatch shift manager
Before
Applies standing rules like DR-4 with no view of what they do to water storage. “Show me the options with a cost on each, and I'll pick.”
Now
Gets the conflict and three priced options — storage, reserve at 15:00, cost and CO₂ side by side — and approves one, on the record.
HQ
Hana QureshiWater production planner · sets MSF and RO output by zone each day
Water production planner
Before
Forecasts water demand by zone in a spreadsheet. “The power desk cuts my RO trains and I find out at 2 pm.”
Now
Sees the zone forecasts, every reservoir's path to midnight and each plant's plan, and is told the moment an option that touches her plants is approved.
TR
Tomas ReyesFuel and energy scheduler · nominates gas and books peaker hours
Fuel and energy scheduler
Before
Finds out about a surprise peak when the gas is already expensive. “Every surprise peak is a gas turbine at the worst price.”
Now
Sees each option priced in megawatt-hours and dollars a day ahead — $78,400 for the peaker against $5,700 for the north main — before he books anything.
AK
Aisha KarimHead of System Planning · owns forecast accuracy and approves retrains
Head of System Planning
Before
Gets accuracy as a monthly average. “Our MAPE is fine on average. It's the 14 hottest days that hurt.”
Now
Sees MAPE every morning — by hour, on each heat day and over Ramadan — with drift found and a retrain ready for her approval.
Built on the engine

6 agents. Each with one job, and hard limits.

Six agents forecast power and water together and check one against the other; the lead forecaster publishes and the shift manager approves.

Weather reader

Reads the weather centre bulletin, the 51-member ensemble and the dust bulletin; builds hourly temperature, humidity and solar haze by zone and draws the weather bands. Compares the bulletin with a second weather model and quotes each value with its bulletin line.

  • Never edits a forecast it did not make, or a bulletin
  • Flags sources more than 1.5 °C apart instead of averaging them
Calendar keeper

Keeps Ramadan, Eid, school terms, holidays, events and office hours for 18 months, each with its source and status. Ramadan and Eid stay “expected” until the moon-sighting announcement.

  • Never adds an event without a source
  • Marks expected and confirmed dates
Power demand forecaster

Forecasts hourly electricity demand for 7 days with a P10–P90 band, net of rooftop solar and EV charging, from weather, calendar and the last 3 years of load — and attributes each change against the last version to its driver.

  • Drafts only — the lead forecaster publishes
Water demand forecaster

Forecasts hourly water demand by zone for 7 days with its band, from weather, calendar, connections and the last 3 years of flow — on the same weather run as the power forecast.

  • Drafts only — the lead forecaster publishes
Power–water balance checker

Joins both forecasts with the plant plan and rules — MSF steam must-run, RO power draw, transfer limits, rule DR-4 — and projects every reservoir hour by hour. Where a reservoir falls under its minimum or the reserve under its floor, it prices options in storage, reserve, cost and CO₂ and recommends one.

  • Never changes a plant schedule
  • Never sends a dispatch instruction — options only
Accuracy tracker

Scores every day's published versions at 01:00 — MAPE by hour, heat days and holidays tracked separately — finds drift when a zone is biased for 14 days, prepares the retrain and runs back-casts.

  • Never retrains a model without the head of system planning's approval
Lead forecaster

Publishes; the shift manager approves plan changes. The agents propose; a named person decides.

Ask in plain words

Ask about any hour of the forecast, in plain words

Ask about any hour of the power or water forecast — or say what to change. Every answer points to its sources.

Why does Northgate run short tonight?

Because the power peak cuts the desalination that fills it. The 09:40 bulletin puts Thursday at 48.6 °C at 15:00, which lifts the peak to 10.12 GW and the reserve margin to 9.2 %. Under 10 %, rule DR-4 cuts Marram Point RO trains 5–8 from 13:00 to 19:00 — 76 MIGD that feed Northgate. With the evening rise in demand, Northgate falls under 40 % at 19:00 and reaches 34 % at midnight.

Compare the fixes for Thursday

Three options, priced with today's fuel and energy prices. A: run peaker GT-11 instead of cutting RO — Northgate 45 % at midnight, $78,400. B: pre-fill Northgate through the north main from 22:00 tonight — 46 %, $5,700; recommended. C: ask the north zones to save 5 % — 37 %, still under the minimum.

What if Thursday reaches 50 °C?

At 50.1 °C — 1.5 °C above the bulletin and beyond the ensemble's 90th percentile of 49.5 °C — the peak would be 10.40 GW and the reserve margin 6.3 %, under the 8 % floor, so dispatch would need more capacity. Northgate would reach 33 % at midnight without a fix, or 45 % with option B.

How close were we last Ramadan?

Over Ramadan 2026 the joint forecast's day-ahead MAPE was 3.4 %, against 6.8 % for the previous model. The gain is the late-night peak after 22:00, which the old model treated as a normal evening. Ramadan 2027 is expected from 8 February, to be confirmed by moon sighting; it is already in the calendar.

Every screen

The working solution, as it ships.

13 screens from the working solution, on its sample data. Pick one to see it large.

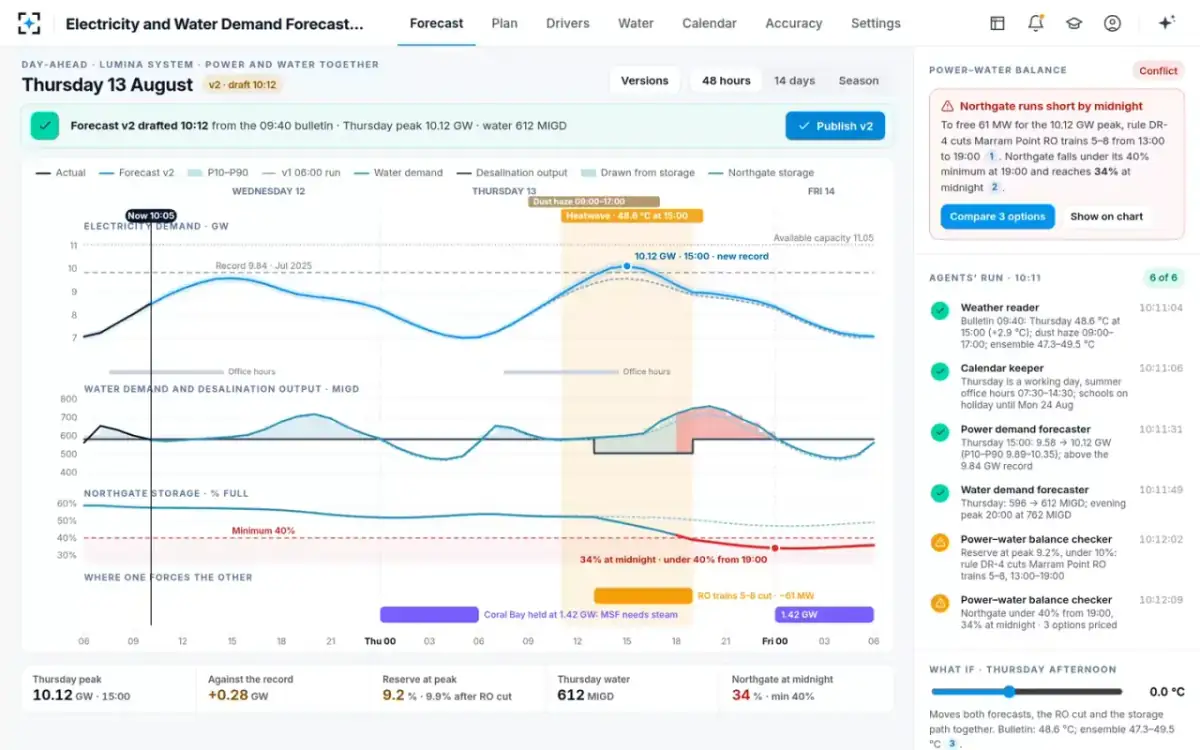

Power and water, togetherElectricity demand with its P10–P90 band, water demand against desalination output, Northgate storage and where one forces the other — on one hourly axis, with the conflict and the agents' run in the side rail.
A new weather bulletinThe 09:40 bulletin raises Thursday to 48.6 °C; the heatwave band is drawn across every lane before the forecast is re-run.
Why the forecast movedThe change from 9.58 to 10.12 GW at 15:00, attributed driver by driver, beside the cited bulletin and the weather by zone.

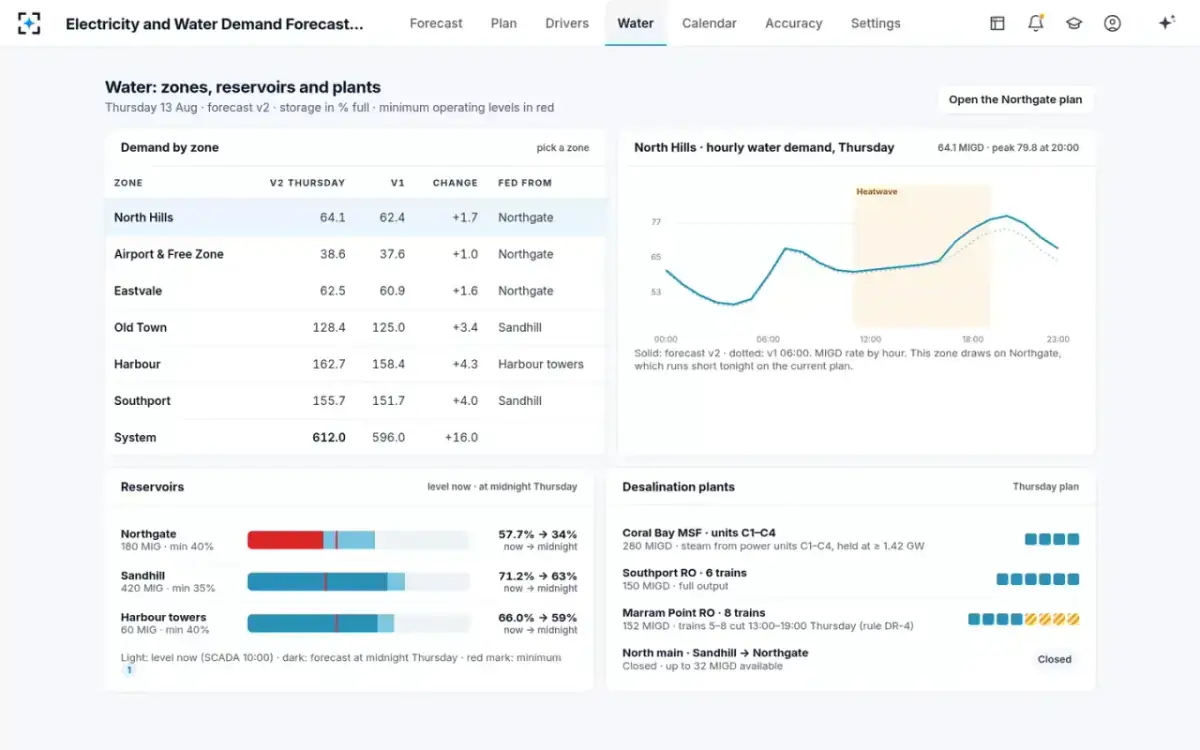

Zones, reservoirs and plantsWater demand by zone, each reservoir's level now and at midnight against its minimum, and the Thursday plan for every desalination plant.
Three fixes, pricedEach option with its Northgate path, storage at midnight, cost and CO₂, and the side-by-side comparison below.
Publish with a signatureForecast v2 signed by the lead forecaster, with the meaning of the signature recorded, and sent to unit commitment, fuel, water and trading.
The shift manager approvesOption B approved by Daniel Mensah at 10:34; Northgate holds at 46 % at midnight.
The plan on the forecastForecast v2 published, the north main transfer on the coupling strip and the storage lane above its minimum.

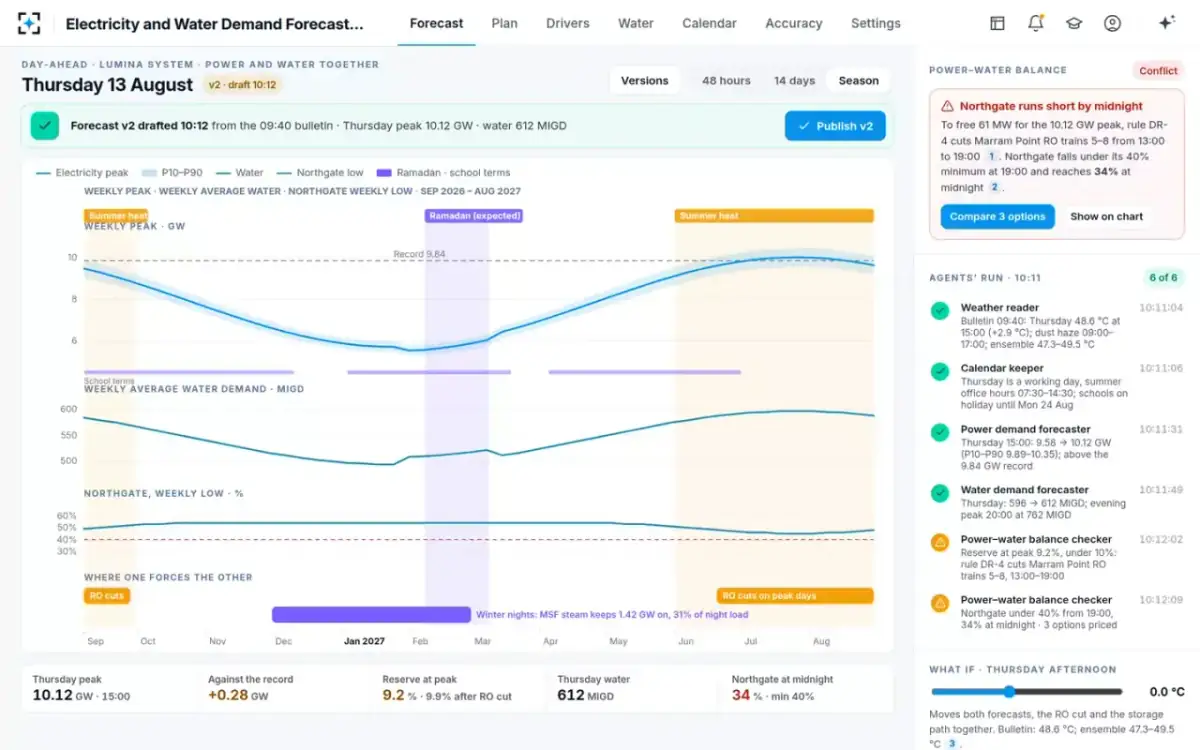

The season aheadWeekly peak, water and lowest storage from September to August, with Ramadan, school terms and the summer heat drawn as bands.
Forecast versionsEvery version with what it was made from, its peak, water total, status and signature, and v1 against v2 hour by hour.

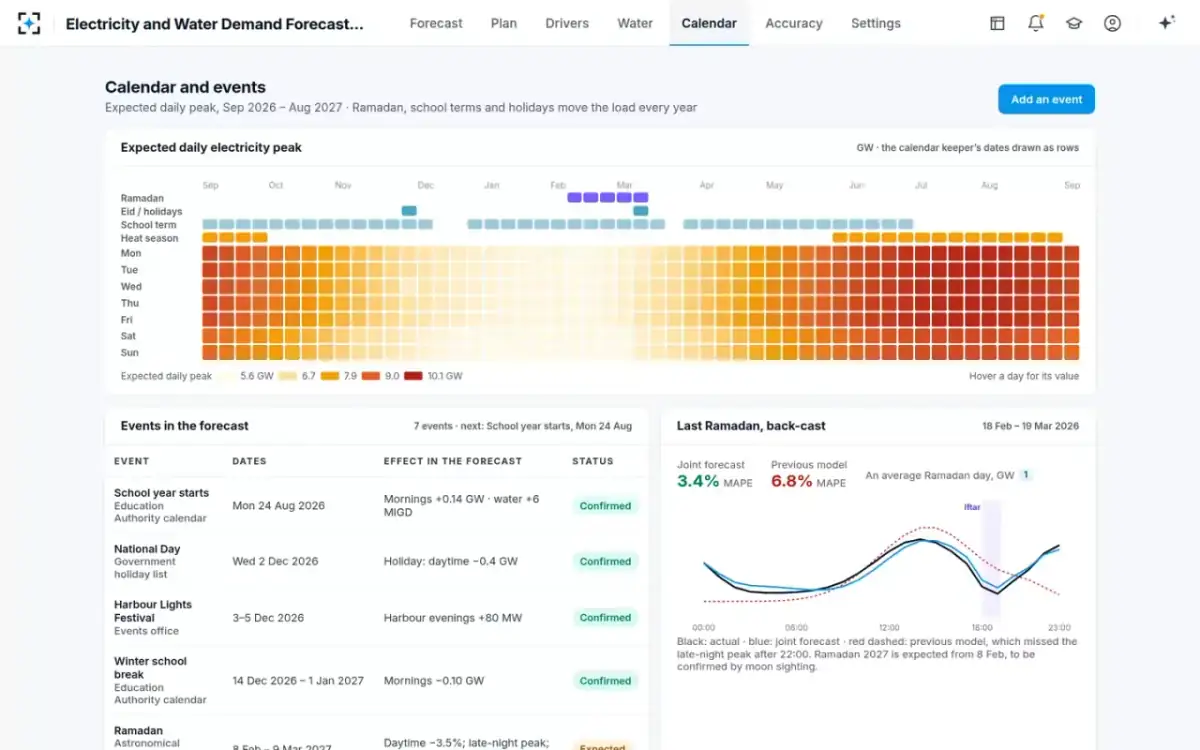

Calendar and eventsTwelve months of expected daily peak, the events in the forecast with their sources, and last Ramadan's back-cast.
Forecast accuracyDay-ahead MAPE for 90 days against the previous model, error by hour of day and the drift the accuracy tracker found.
Your rulesReservoir minimums, the plant rules the balance checker applies, the publish deadline, sources and who decides.
Governance

Built for the control room: cited, signed, never dispatched by an agent.

Every number cites its sourceEach driver, bulletin line and figure on the plan links to where it came from — the weather centre bulletin, the ensemble, the SCADA reading, the plant plan, rule DR-4, the price sheet, the accuracy record.
The lead forecaster signs every versionA forecast version is published only with the lead forecaster's e-signature, with its meaning recorded — “Approved for dispatch and production planning” or “Approved for information only”. The forecasters draft; they never publish.
No agent touches dispatchThe agents read SCADA, plant plans and meters read-only. The balance checker proposes options; it never changes a plant schedule or sends a dispatch instruction. Any change to the plant plan needs the dispatch shift manager.
Retrains need the head of system planningWhen the accuracy tracker finds drift, it prepares the retrain and asks. Nothing changes in a model until Aisha Karim approves, and the approval is on the record.
Published versions are kept unchangedA published version is never edited. A new bulletin makes a new draft; when it is signed, the old version is marked Replaced, so the forecast that unit commitment and fuel nominations read at 10:00 can always be shown again.
Every run, version, approval and setting change on the trailEach agent step and each human decision is recorded with its time: who read the bulletin, who published v2, who approved option B, who changed the heat band trigger. Utility data stays with Lumina.
Configuration

Your plant rules and limits, not ours

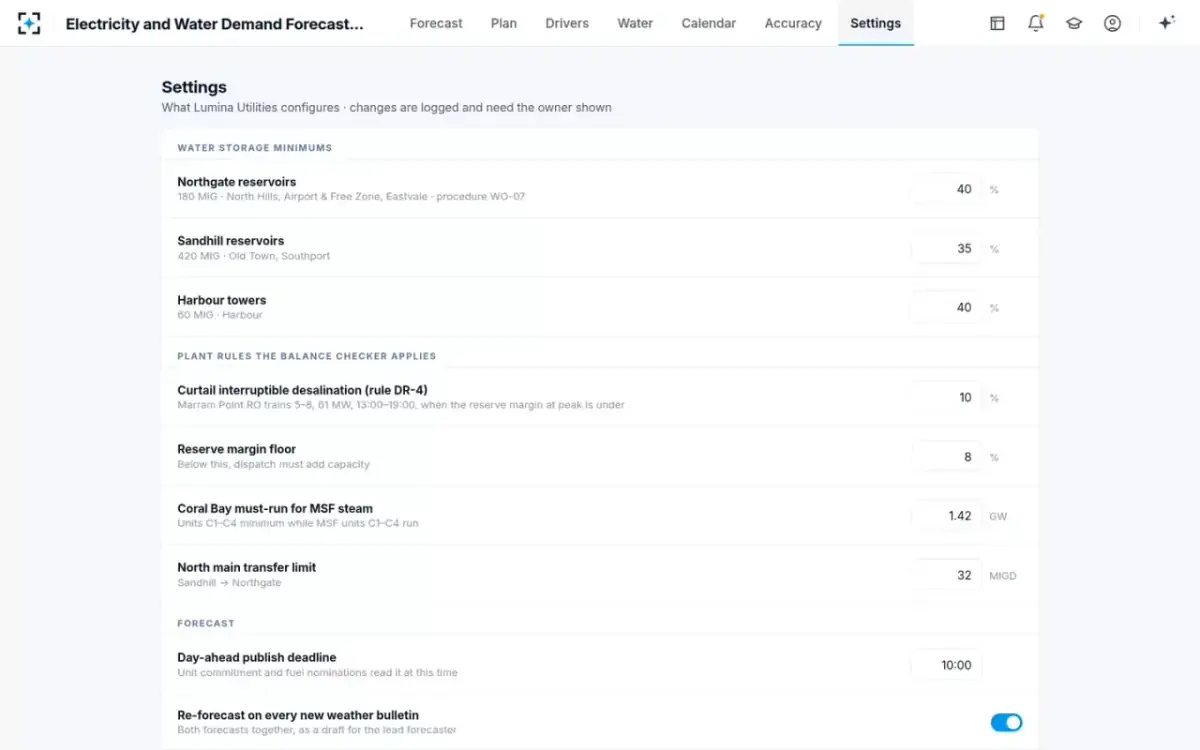

Reservoir minimums, the dispatch rules the balance checker applies, the publish deadline and who decides are settings. Changes are logged and need the owner shown.

SettingDefaultChoose from
Water storage minimumsNorthgate 40 %A % for each reservoir — Northgate 40 %, Sandhill 35 %, Harbour towers 40 %
Curtail interruptible desalination (rule DR-4)Under 10 %The reserve margin at peak below which Marram Point RO trains 5–8 (61 MW) are cut, 13:00–19:00
Reserve margin floor8 %Below this, dispatch must add capacity
Coral Bay must-run for MSF steam1.42 GWUnits C1–C4 minimum while MSF units C1–C4 run
North main transfer limit32 MIGDSandhill → Northgate
Day-ahead publish deadline10:00The time unit commitment and fuel nominations read it
Re-forecast on every new weather bulletinOnOn · Off — both forecasts together, as a draft for the lead forecaster
Heat band≥ 46 °C or +2 °C on the last runDraws a heatwave band and widens the confidence band; the P10–P90 band is shown on every chart and sent with each version
Connections

Works with the data your control room already runs on

Weather forecaststhe national weather centre's bulletin, 51-member ensemble and dust bulletin, and a second weather model
Smart meters and SCADAhistorical load, 15-minute load by zone, reservoir levels and plant output
Calendar and eventsRamadan, Eid, school terms, public holidays, events and office hours, each with its source
Rooftop solar and EV registersinstalled rooftop solar and EV chargers, netted out of the load forecast
Plant plans and dispatch rulesdaily production plans, must-run limits, transfer limits and rules such as DR-4
Fuel and energy pricesthe price sheet each option is costed with, in dollars and megawatt-hours
What it changes

The difference, in numbers.

Every figure is labelled: a target the solution is built to, an estimate, a typical published result, or a proven one.

target
1day
warning before a reservoir runs short in a heatwave, seen when the forecast is made
typical
$300K/yr
per GW of peak for each point of short-term forecast error (MAPE) cut
typical
15%
less pumping energy when pumps follow an hourly water demand forecast
pumping energy cost

“demo” = seen in the working solution, on its sample data · “target” = the design goal, measured in the live solution · “estimated” = our estimate: $72,700 is the peaker option's $78,400 (390 MWh at $201) less the north main option's $5,700 (110 MWh at $52) for the one day, and 173 t is 218 t less 45 t of CO₂; the split of hours is an estimate of desk practice · “typical” = published figures (Tao Hong, EnergyBiz 2015, as summarised on Wikipedia, not re-checked — about $300K a year for a 1 GW utility per point of short-term MAPE; CAISO root cause analysis of August 2020, via Western Resource Advocates; Sydney Water / Data61 pump scheduling simulation, about 15 % lower energy cost). Lumina Utilities, its people, plants, reservoirs, zones and the Lumina National Weather Centre named on this page are fictional — characters and sample data in the working solution.

Questions

What system operators and planners ask us.

What is electricity and water demand forecasting?

It is the hourly and day-ahead forecast of how much electricity and how much water a system will need, used for unit commitment, fuel nominations and desalination scheduling. Electricity and Water Demand Forecasting makes the two forecasts together, on the same weather and calendar, so a utility whose plants make both can see where one forces the other.

How does the short-term load forecast work?

The power demand forecaster forecasts hourly demand for 7 days with a P10–P90 band from weather, calendar, rooftop solar, EV charging and the last 3 years of load. Each change against the last version is attributed to its driver — in the sample case, +0.41 GW from temperature, +0.06 from humidity and +0.05 from dust haze on rooftop solar.

Why forecast power and water demand together?

Because the same plants make both. A power peak can trigger a rule that cuts RO trains, and MSF units need steam that holds power units on overnight. The power–water balance checker pushes the power result through the plant rules into every reservoir's path, so in the sample case the 34 % midnight level at Northgate showed up a day ahead, where a power-only forecast would not have shown it.

How does it handle heatwaves, dust, school terms and Ramadan?

The weather reader draws a heatwave band and widens the confidence band at 46 °C or 2 °C above the last run, and accounts for dust haze on rooftop solar. The calendar keeper keeps school terms, holidays and Ramadan, which stays “expected” until moon sighting. Last Ramadan the joint forecast's back-cast MAPE was 3.4 %, against 6.8 % for the previous model.

How is forecast accuracy (MAPE) tracked?

The accuracy tracker scores every published version against actuals at 01:00 each night, by hour of day, with heat days and holidays tracked separately. When a zone is biased for 14 days it prepares a retrain — in the sample, the Eastvale water forecast had been 2.6 % low every day since 21 Jul.

Do system operators stay in control?

Yes. The forecasters draft and the lead forecaster publishes each version with an e-signature. The balance checker proposes priced options but never changes a plant schedule or sends a dispatch instruction; the dispatch shift manager approves any change to the plant plan, and the head of system planning approves retrains.

Can we set our own plant rules and reservoir minimums?

Yes. The minimum for each reservoir, the reserve margin that triggers desalination curtailment, the reserve margin floor, must-run limits, transfer limits, the publish deadline, re-forecasting on each bulletin, the heat band, the weather sources and who decides are all settings, and every change is logged.

How long does it take to go live?

The Agentic Solution Engine builds and deploys it from your requirements and documents — your load and water history, weather feeds, calendar, plant plans and dispatch rules — and it goes live once every quality gate has passed. We will walk you through it first on a back-cast of your own last heatwave.

See it on
your summer peak.

We'll run Electricity and Water Demand Forecasting on a back-cast of your own last heatwave.
